Challenge

Usage of Navigation tool , Timeliner and Clash Detection test using Naviswork

1.

AIM:

To expert the revit architecture and structure model created in week 6 challenge to naviswork cache files following the export settings

PROCEDURE:

initally open the autodesk account and download thw naviswork manage software

now open the architectural mode created in week 6 challenge in the revit software

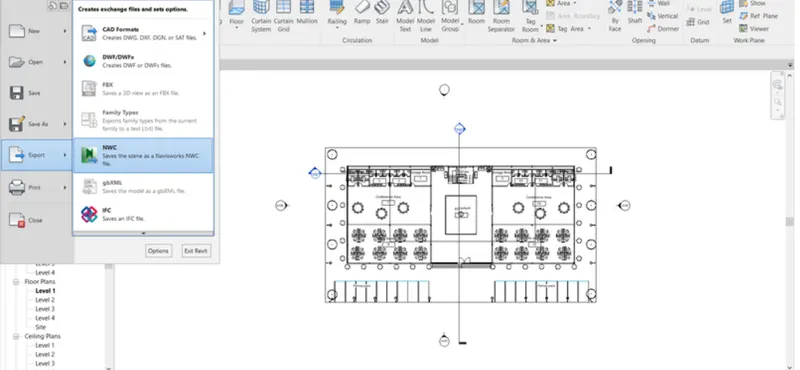

then go to files export NWC files

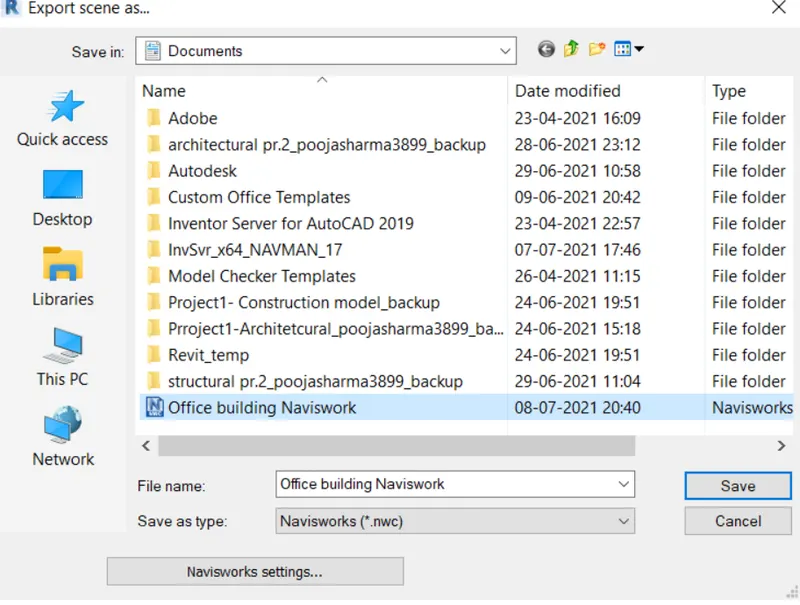

now save the files

hence the files is exported

RESULT:

initally open the architectural files in the naviswork

2)

AIM:

To use navigate tools walk around model walk through the rooms created and record your moving as animation in your naviswork files

PROCEDURE:

initally open the architecture files naviwork

now go to walk option in the viewport tab of the naviswork software

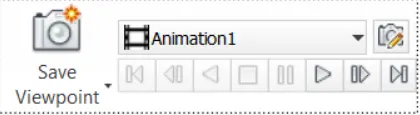

use the record option in the save viewport option to record animated view of each and every room

entrance area:

managing room:

work station

wash room

hence the walk around is completed

RESULT:

walk around model is completed

3)

AIM:

To use realism feature to walk through the model and record moving as animation in naviswork files

PROCEDURE:

in the naviswork software underview port tab and go to realism and realism choose third person

now again record the moving from save port position

entrance area:

work station:

manager room

courtyard:

Washroom:

RESULT:

Walk through the model using realism is completedly sucessfully.

4.

AIM:

to create the clash detection test between the two models

PROCEDURE:

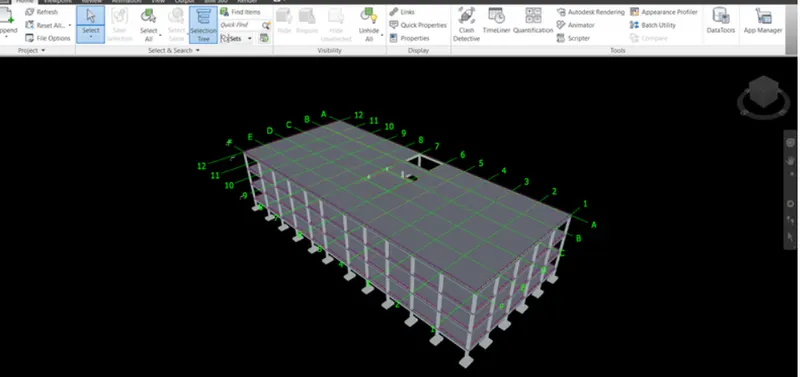

initally append the structural model to this architetural model

study the clashes between two models

list which of the clashes could be approved

list which of the clashes could be neglected

list which of the clashes can be resolved

save the result after colour coding the clashes the naviswork files

RESULT:

The naviswork clash analysis have been sucessfully carried out

5.

AIM:

Using the Timeliner feature in Navisworks prepare a schedule for the project developed in week 6 to 8 by adding reasonable assumptions for task start date and end date and simulate the task completion as a visual simulation. Record it and save the timeline simulation to Navisworks file

PROCEDURE:

Initally open the structural model in the revit

then go to menu export NWCfiles

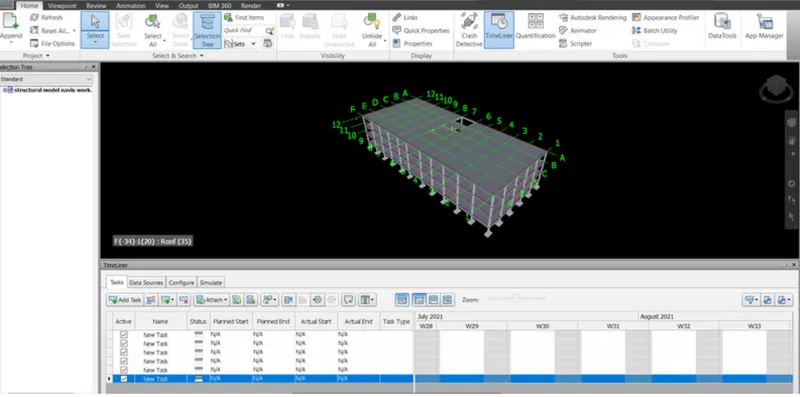

now go to timeline in the home tab

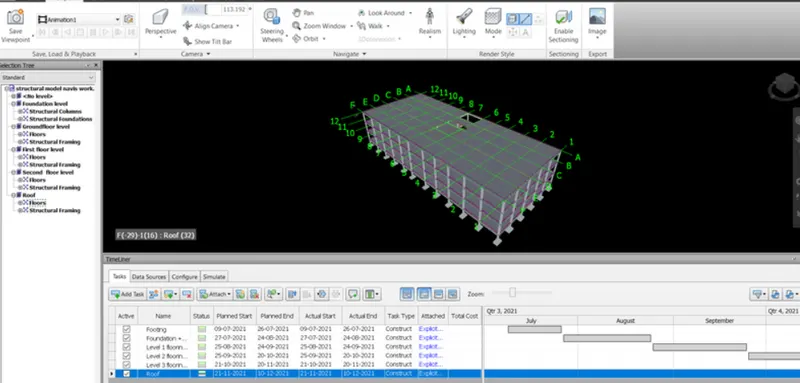

click add task option available in the timeliner to add new tasks

next we have to update the planned and actual dates and provide type

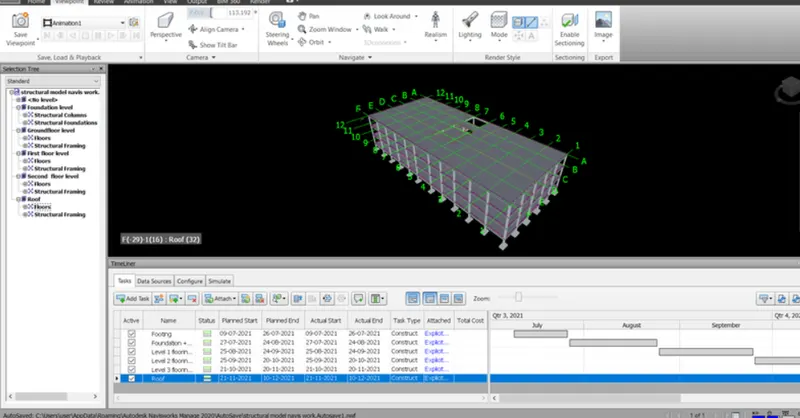

click ok simluate and record it and save the work

hence the timeliner simulation is completed

RESULT:

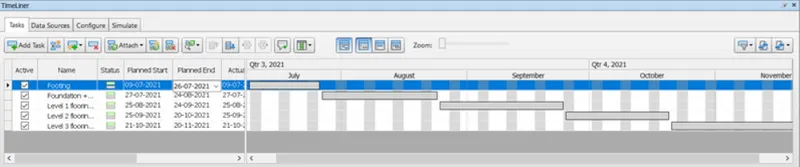

Timeliner feature in the naviswork has been successfully completed and result given below
