Challenge

Project 2

A 100 m WBM road needs to be constructed inside the Skill Lync Education center premises to allow access to the centre for students and faculties.
Create the following Project (under same EPS/OBS as project-1) and Resource :
Project Name - Education Centre Road
Assume - Calendar as 6 x 24 and start date on 22nd feb 2021

Please do the following:
1. Develop the project schedule as per the criteria above
2. Use 3-Tier timescale with Year / Month / Weeks
3. Define and Add resources
4. Add a budget to your project - INR 6 cr.
5. Assign a baseline to the project
6. Add following expense:
Task - 1 - Rs 20,000/- (Item - Fuel)
Task - 2 - Rs 30,000 /- (Item - Maintenance)
7. Generate material resource costs curve
8. Generate an activity wise cost report
9. Create a reflection
10. In the reflection, auto update the project at 15 days from start
11. Open a TSLD view of the project in Visualizer
12. Add curtains up-to first 15 days of the project.
13. Find out the actual cost for labour, non-labour and material cost of the updated schedule

Ans:

Project: Education Centre Road

Introduction:

This report outlines the creation and analysis of a project schedule for constructing a 100m WBM road within the Skill Lync Education Center premises. The project will be created under the same EPS/OBS as project-1 in Primavera P6 with specific assumptions and functionalities implemented.

Step-by-Step Guide:

1. Create the Project:

  • Open Primavera P6.
  • Go to the "Projects" tab and click "New Project."

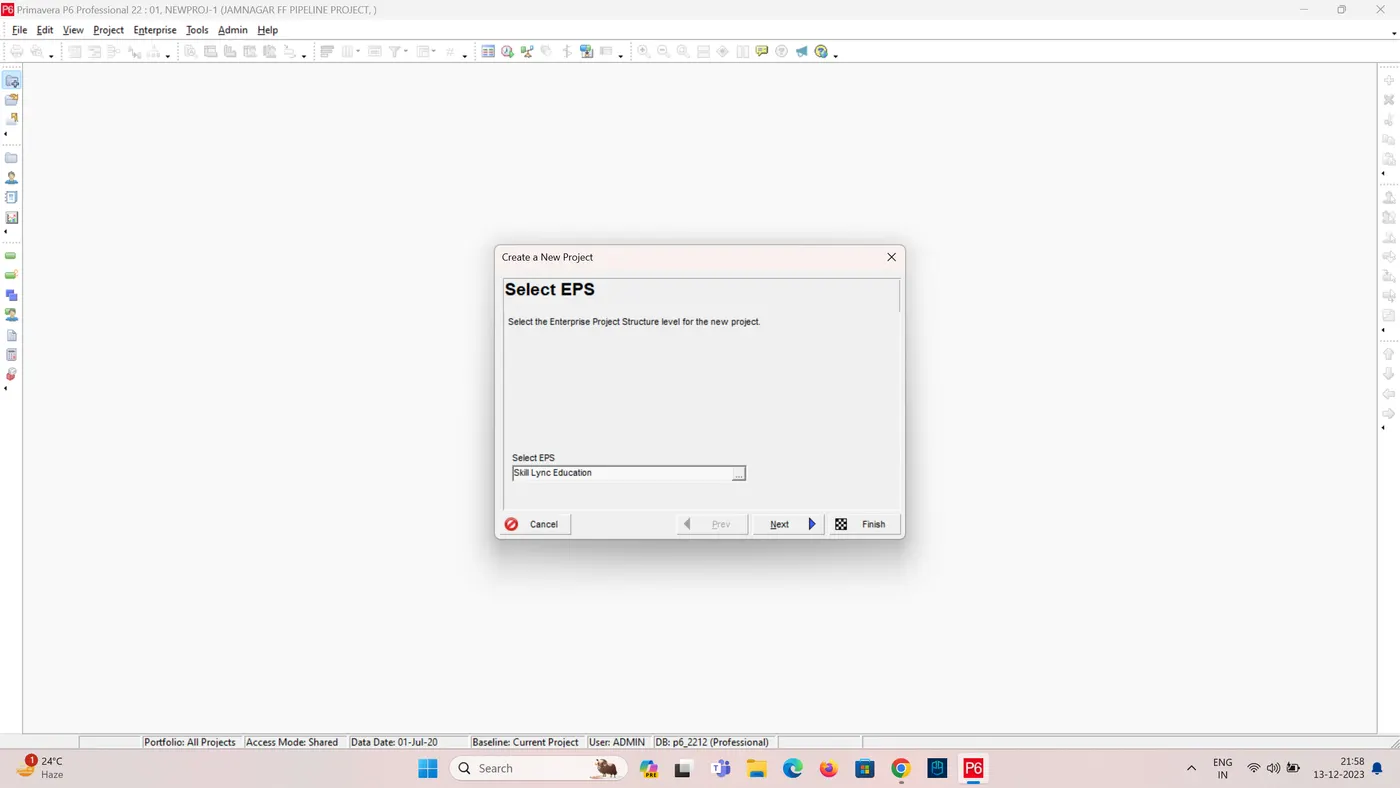

  • Select the EPS as Skill Lync Education
  • Enter "Education Centre Road" as the project name.

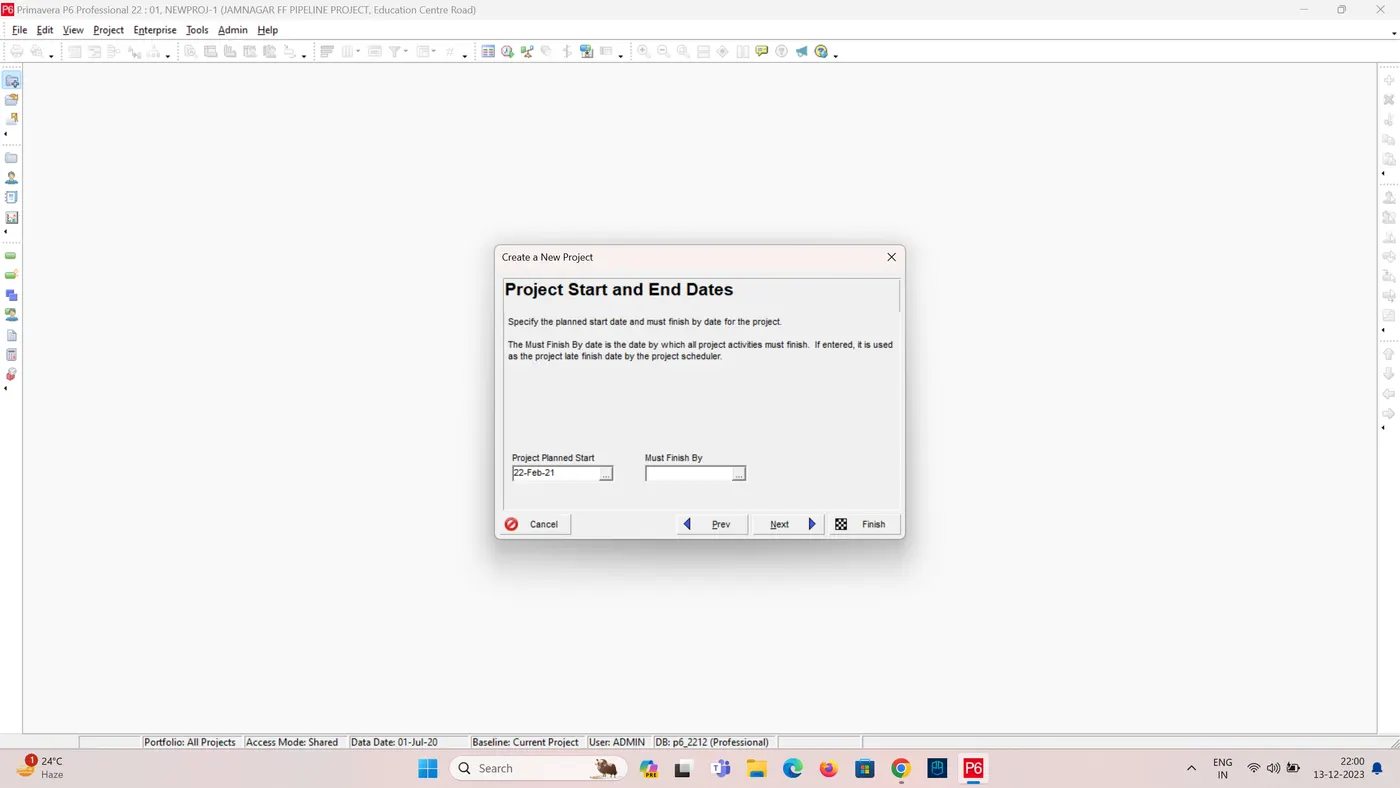

  • Select the start date as 22nd February 2021.
  • Select the responsible manager as Project Manager

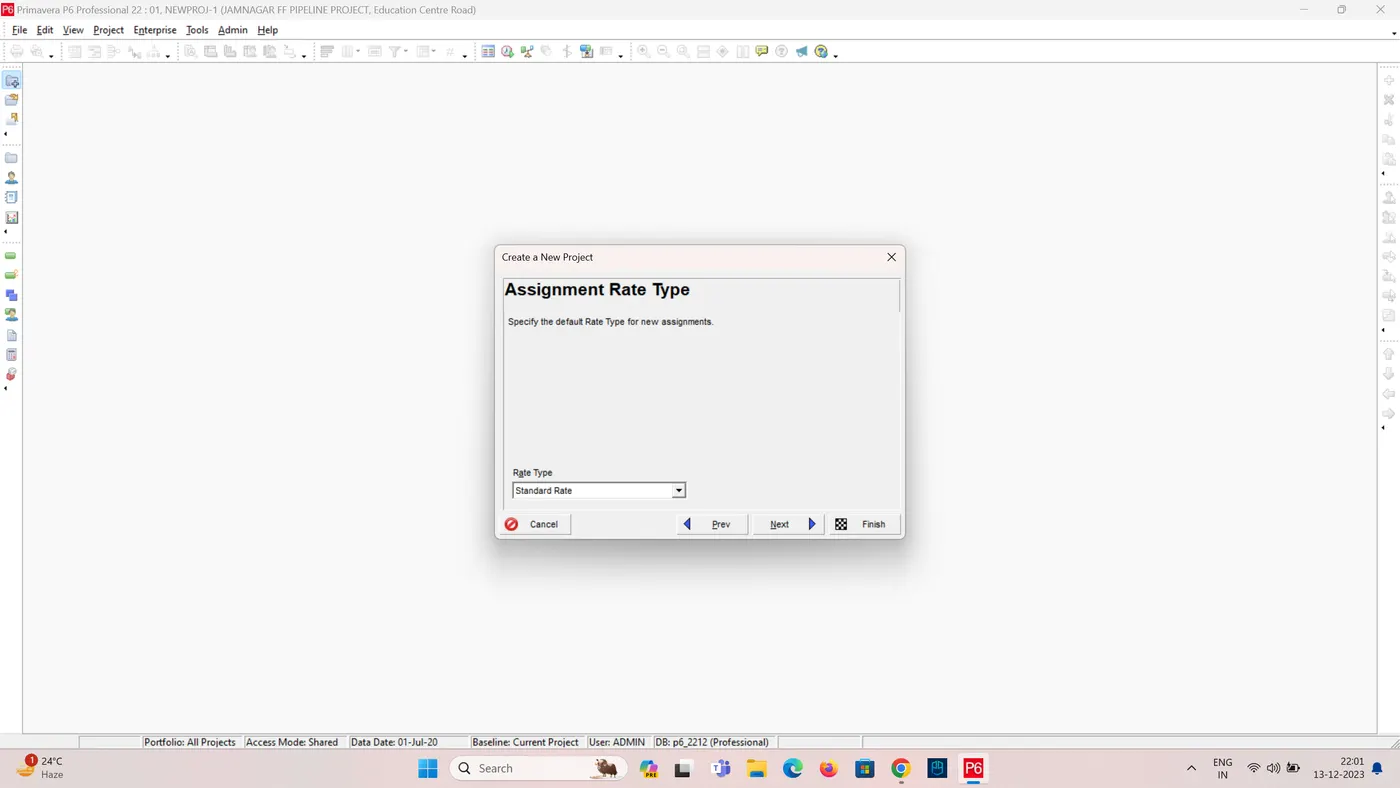

  • Select the Standard Rate type.
  • Click Finish to create a project.

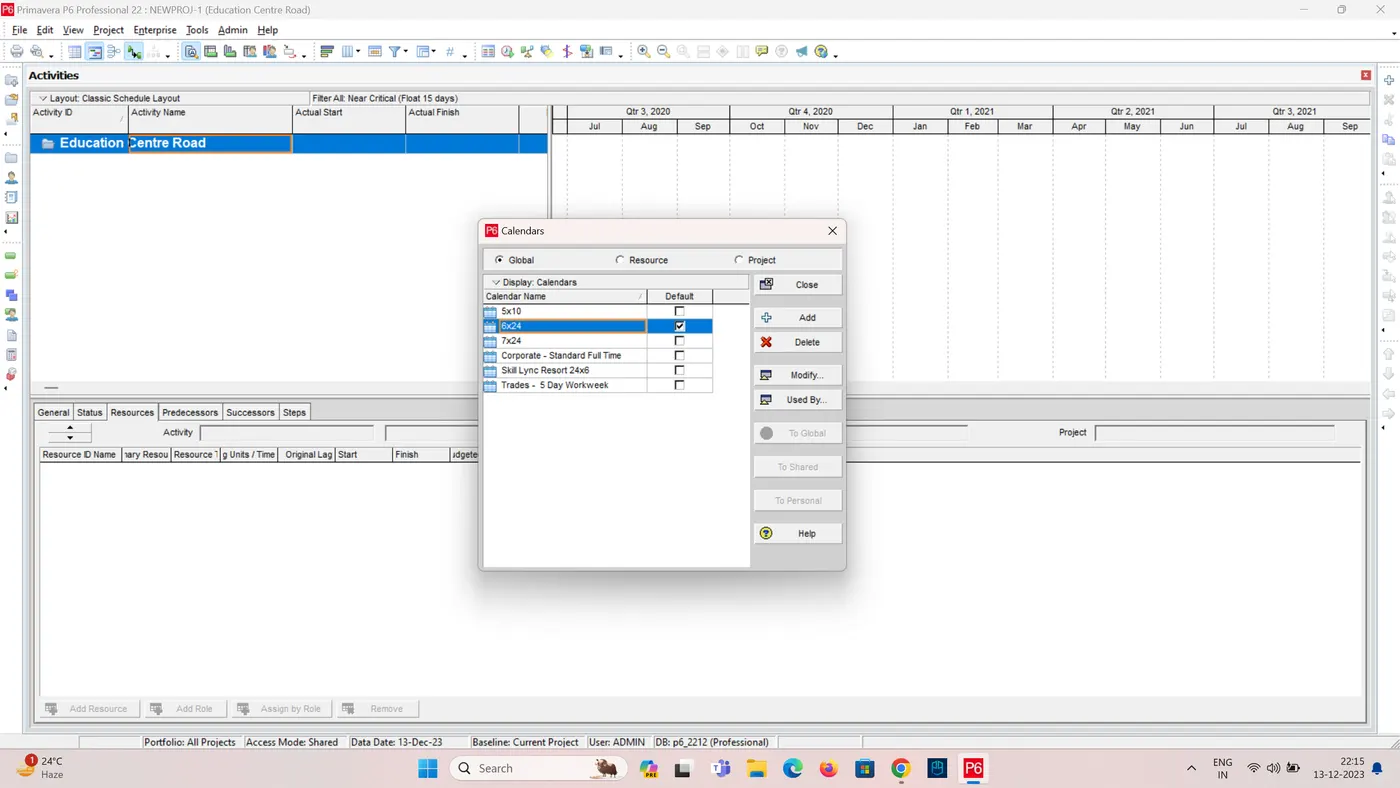

  • Define your base calendar as "6 x 24" to represent a 6-day work week with 24-hour workdays.
  • Now open the created project by Clicking the "Open" button on the EPS toolbar. This will open the Open Projects dialog box.

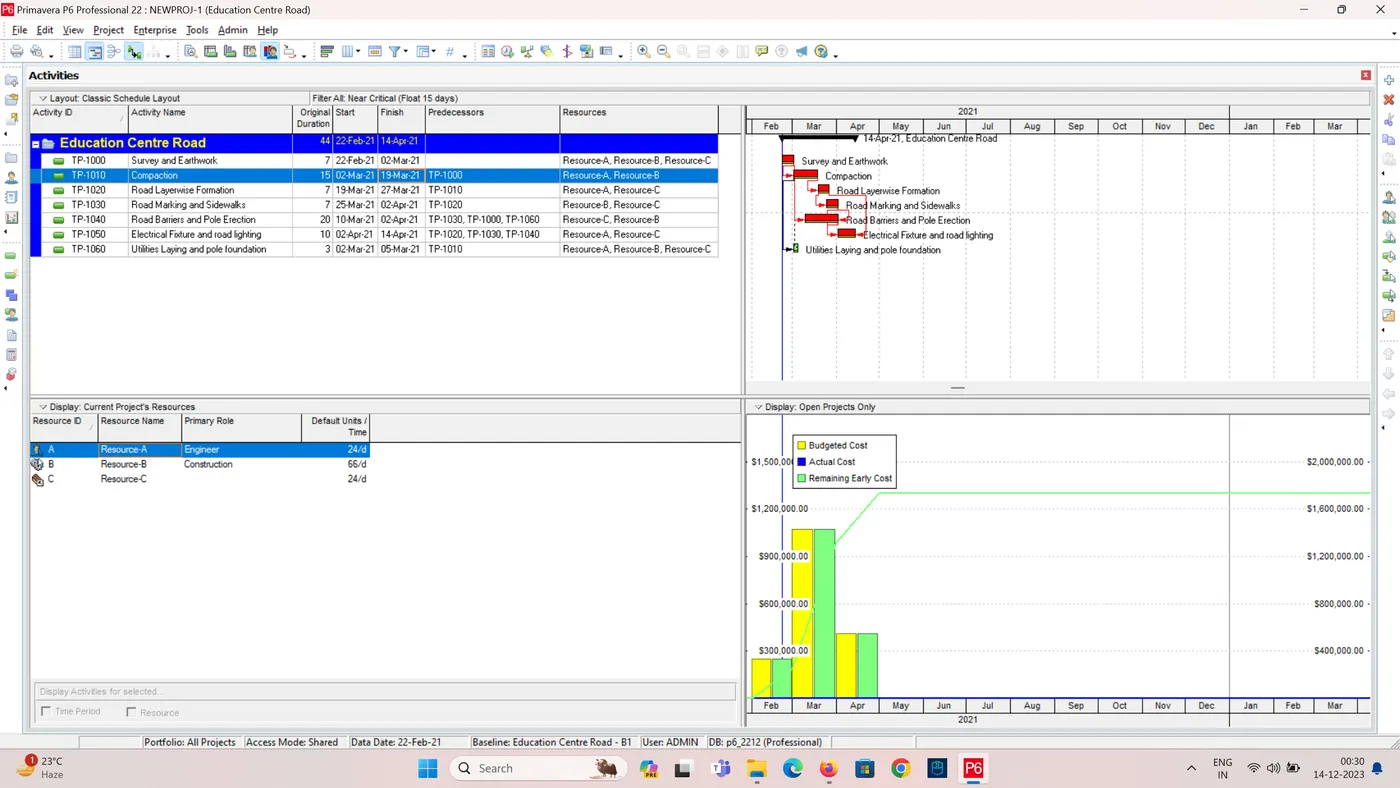

2. Create the Activities:

  • Click on the New Activity button.
  • In the Activity ID field, enter a unique identifier for the activity.
  • In the Activity Name field, enter a descriptive name for the activity.
  • In the Duration field, enter the estimated time it will take to complete the activity. You can choose from various units like days, hours, weeks, etc.

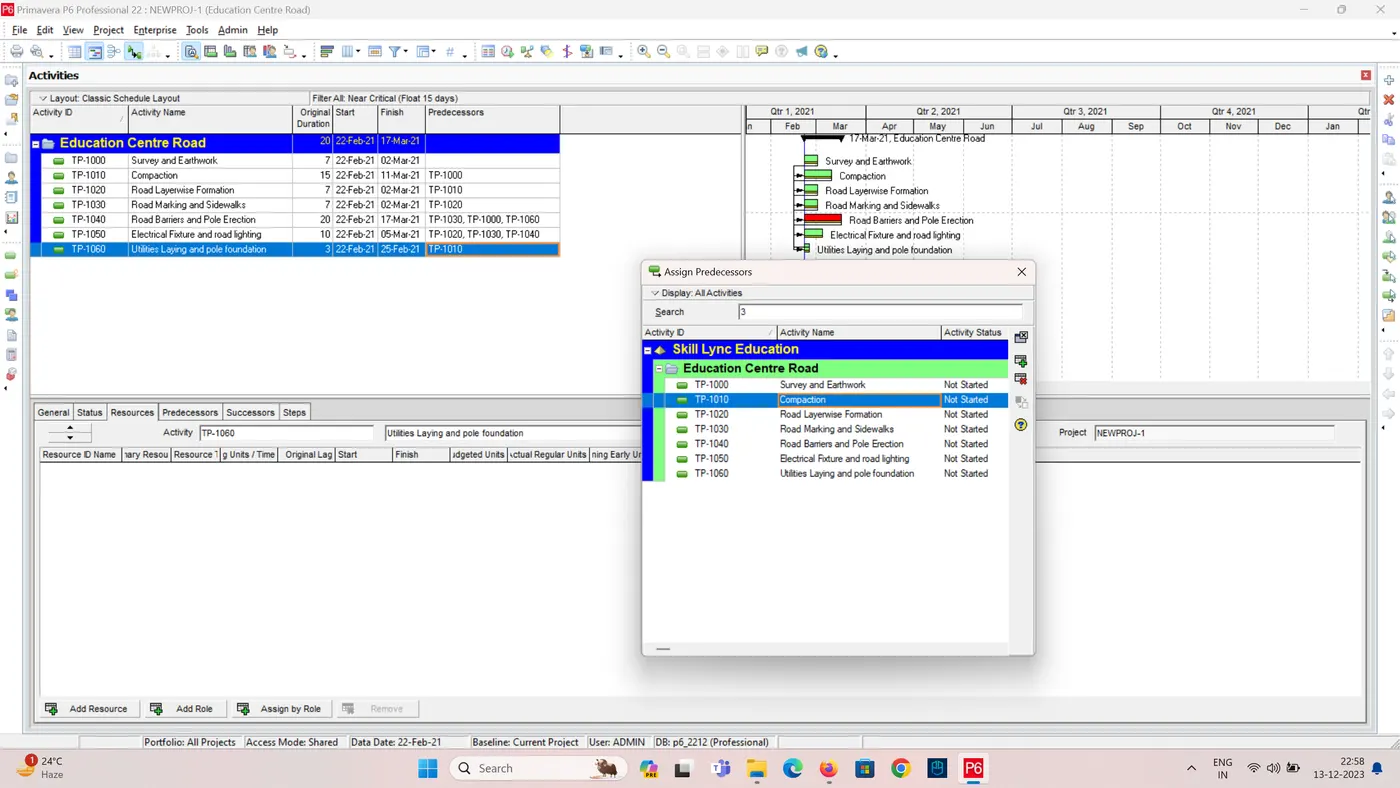

  • You can also use the Start and Finish date fields to specify the planned dates for the activity.
  • Click on the Predecessors tab.
  • Click on the Add button.
  • In the Activity field, select the activity that must be completed before this activity can start.
  • Choose the type of relationship between the activities. Common relationships include:
    • Finish-to-Start (FS): This means the successor activity can start once the predecessor is finished.
    • Start-to-Start (SS): This means both activities start at the same time.
    • Finish-to-Finish (FF): This means both activities finish at the same time.
  • add a lag or lead time to the relationship which is given in the question. A lag delays the start of the successor activity, while a lead allows it to start before the predecessor finishes.

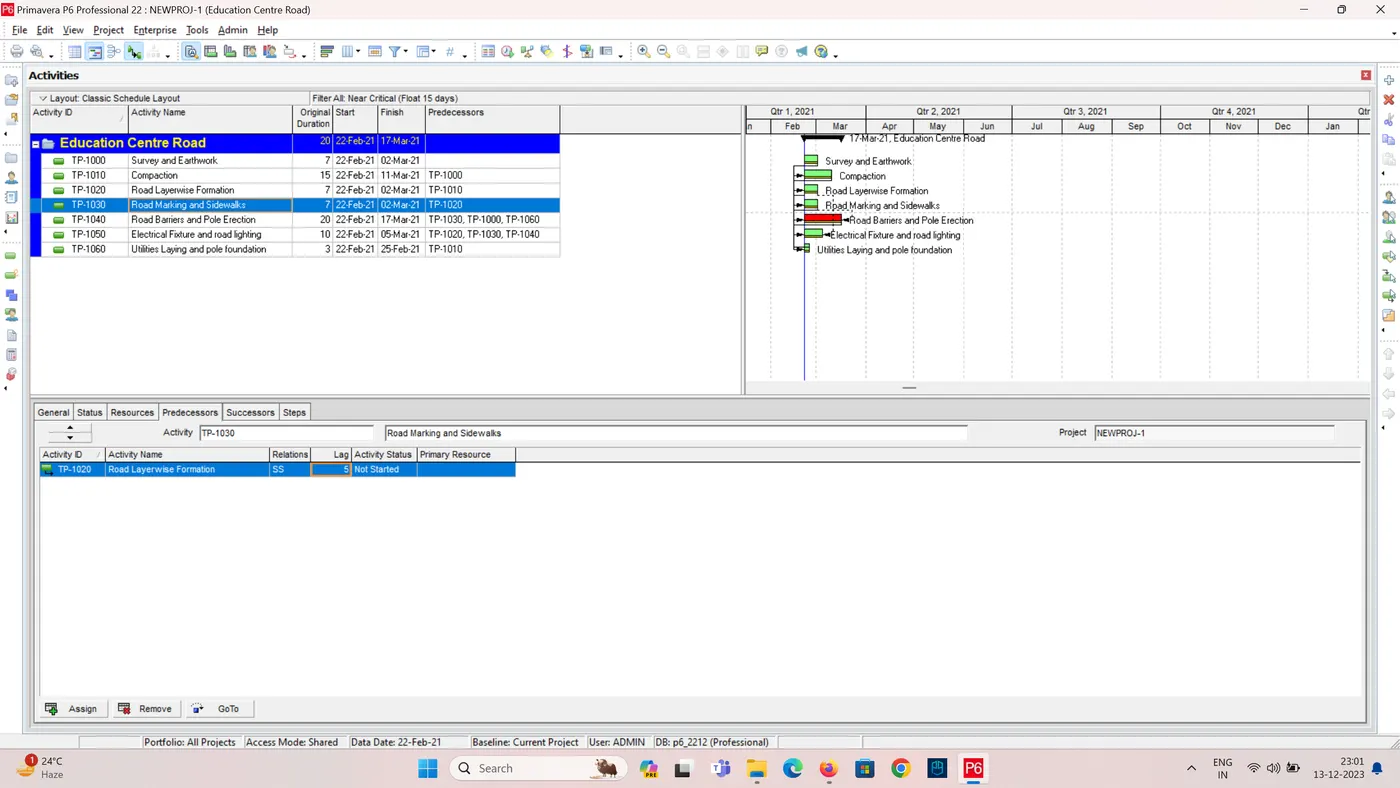

  • Follow steps to create and link all activities in your project.
  • You can use the drag-and-drop functionality to rearrange activities in the list.

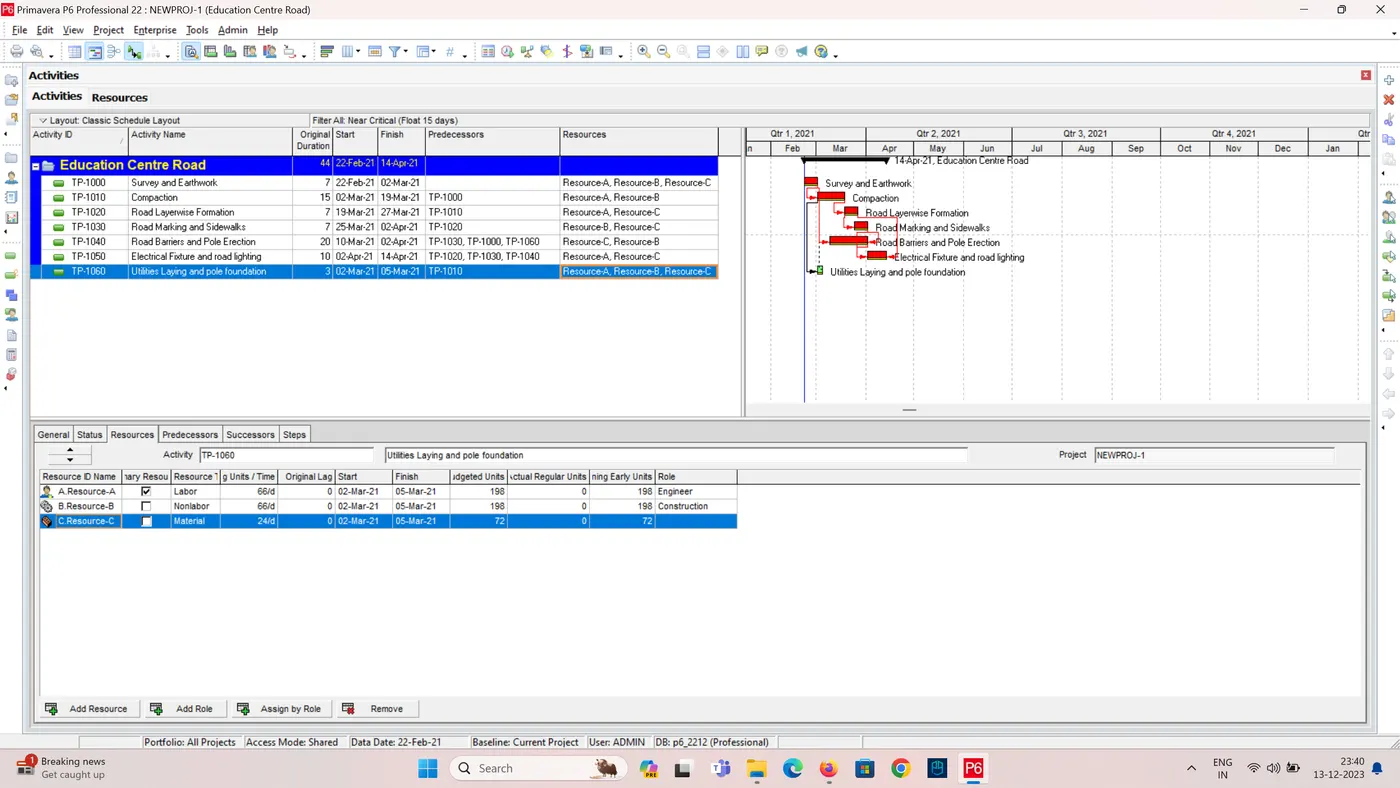

3. Create Resource and assign the suitable resource to the activity:

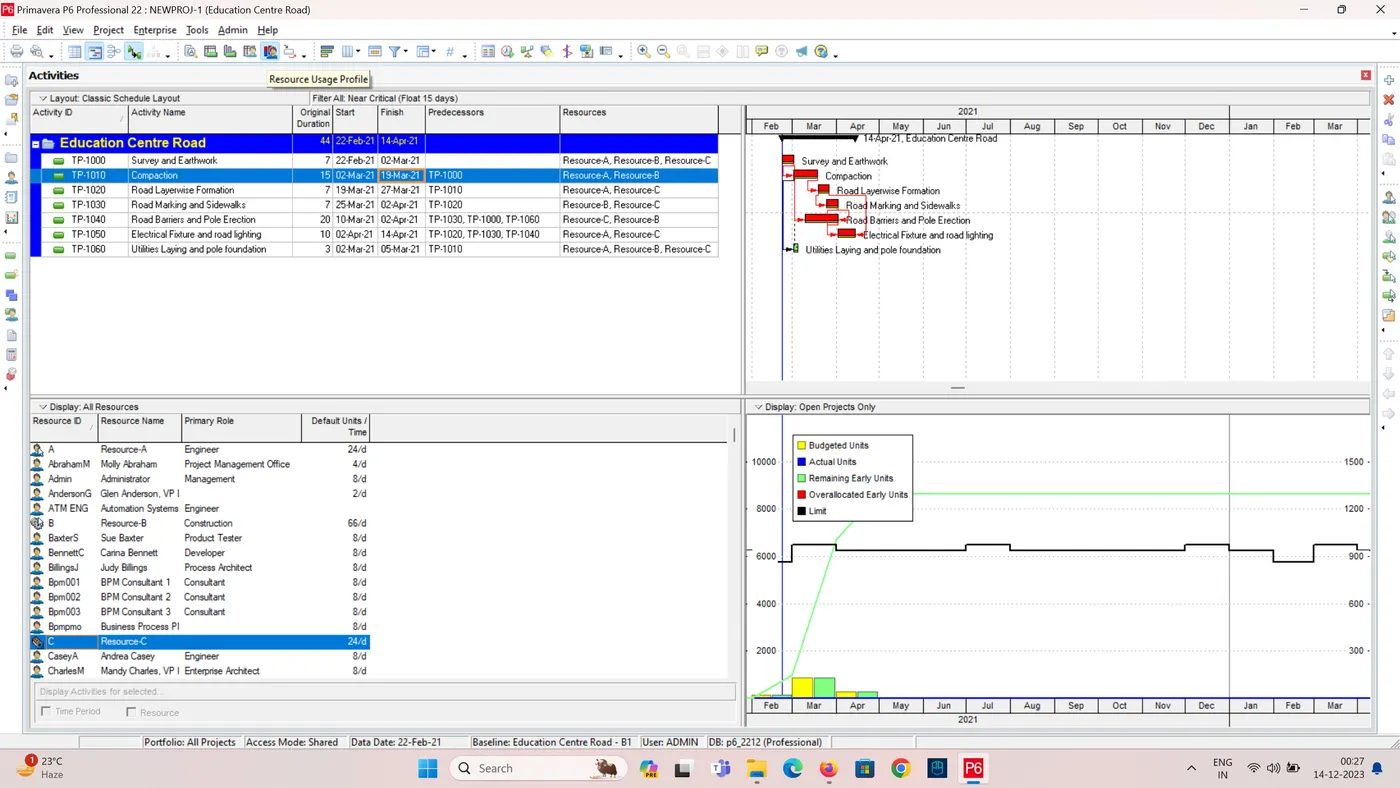

  • Go to the Projects tab.
  • Click on Resources.

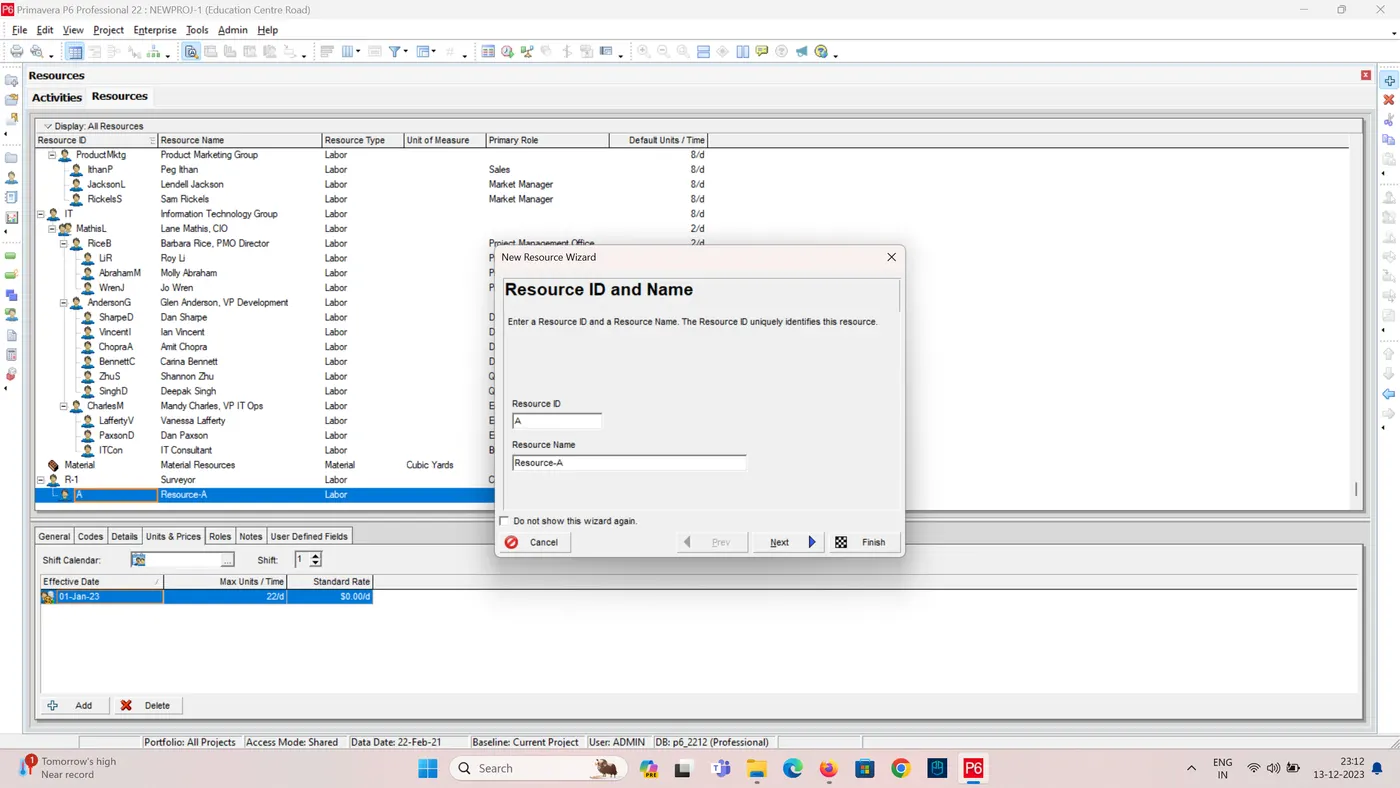

  • Click on the New Resource button.

  • Enter a unique Resource Code and a descriptive Resource Name.

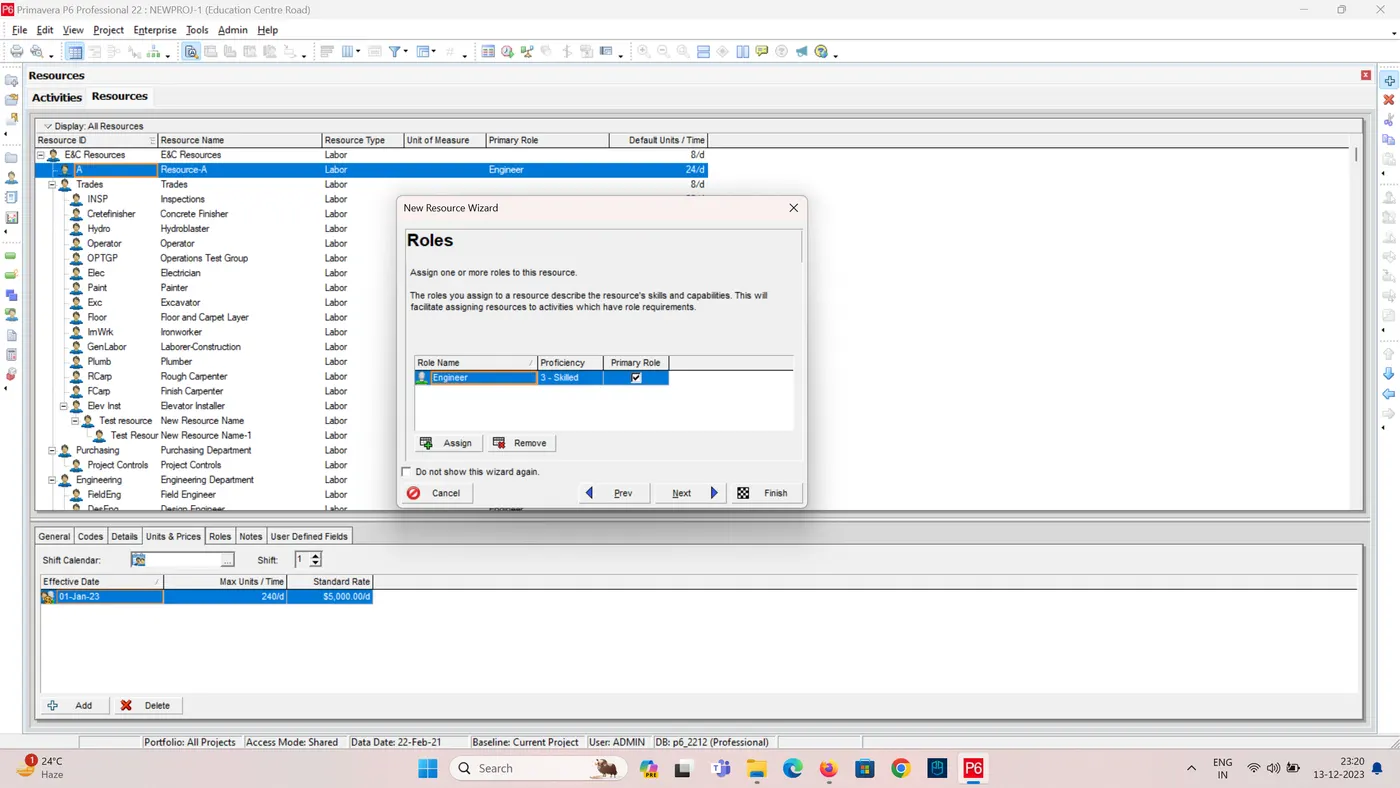

  • Define the Resource Type (e.g., Labor, Equipment, Material).
  • Specify additional details like Units, Cost, Role, Availability Calendar, etc. (optional).
  • Click OK to save the new resource.
  • Now repeat the same process for Resource-B and Resource-C

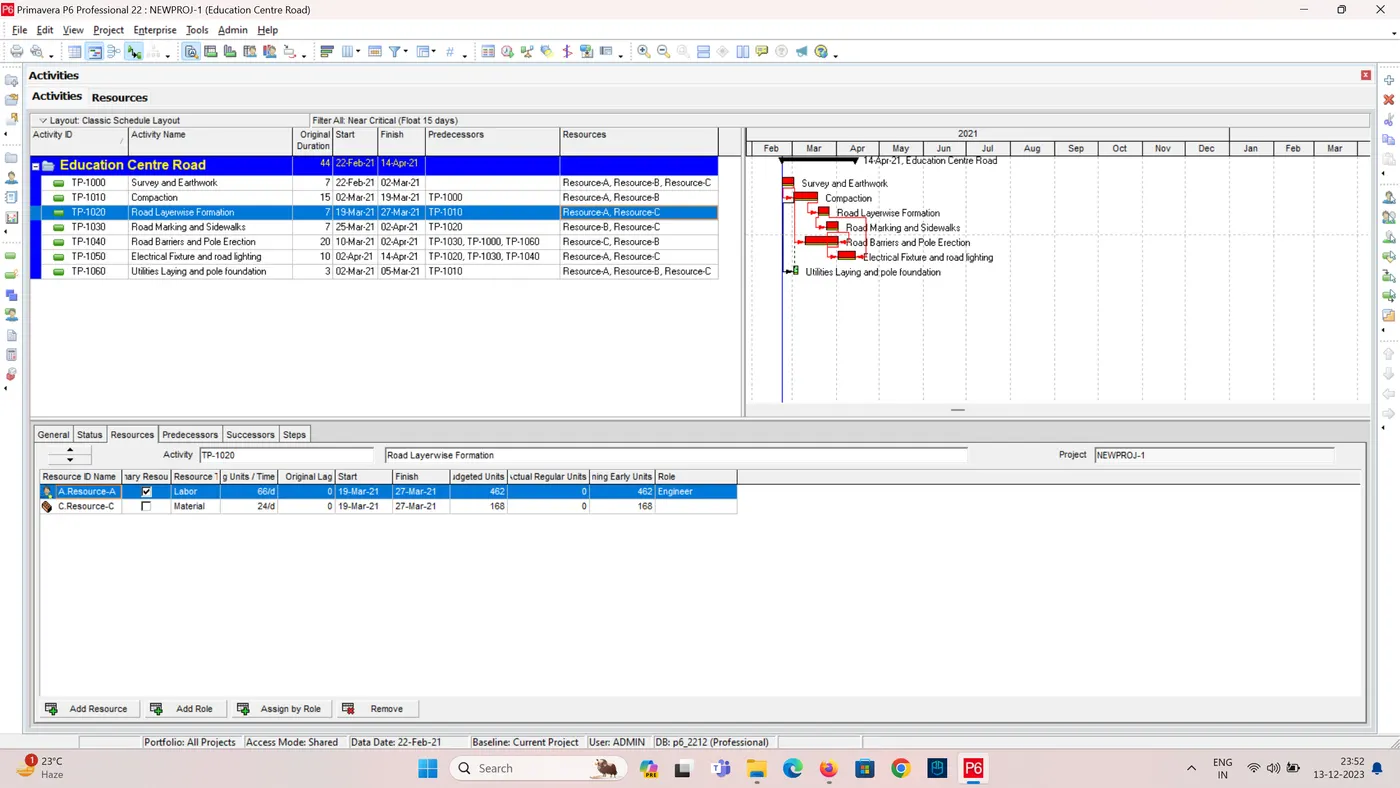

  • Add Resources to Activities:
    • Go to the Schedule tab.
    • Click on Activities.
    • Right-click on the activity you want to assign a resource to.
    • Select Assign Resources.
    • In the Assign Resources window, click the Add Resource button.
    • Select the desired resource from the list.
    • Enter the Units of the resource required for the activity (e.g., hours, number of workers).
    • Optionally, set the Start and Finish dates for the resource assignment.
    • You can assign multiple resources to an activity by repeating steps 6-8.
    • Click OK to save the resource assignment.

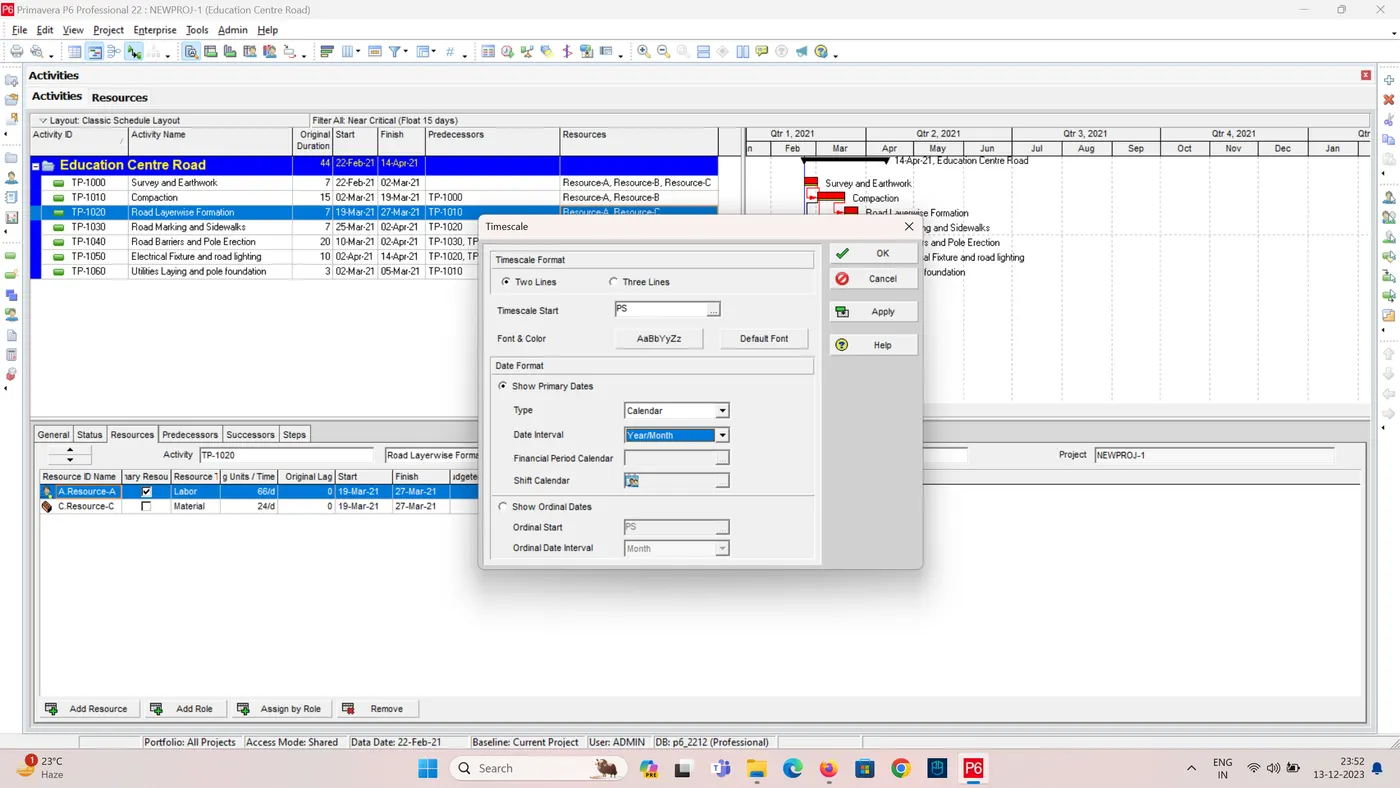

4. To Change Timescale in Gantt Chart:

  • Right click anywhere on Gantt Chart.
  • select Three Lines, and select Year/Month and Week
  • Now, the Timescale has changed.

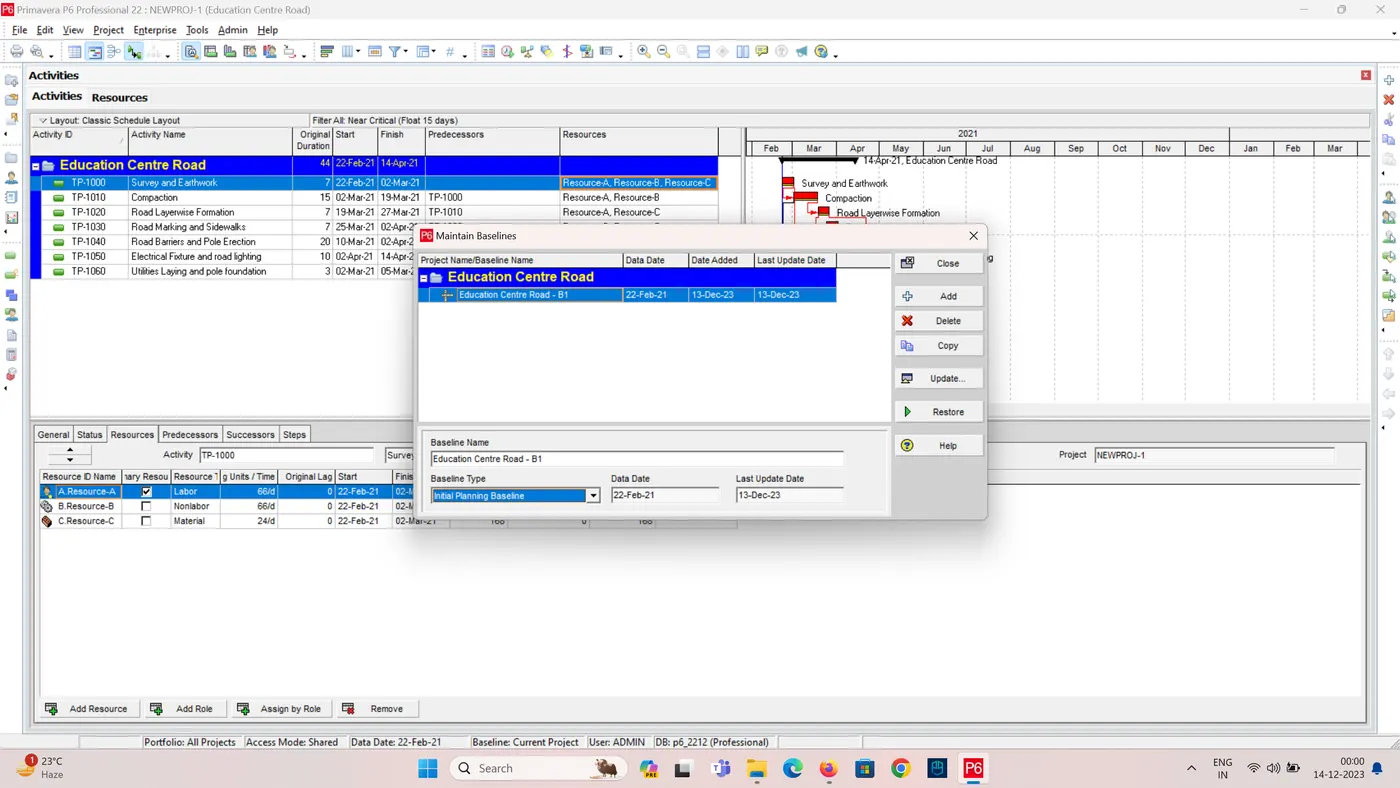

5. Maintain and Assign a baseline to the project:

  • Ensure you have completed your project schedule in Primavera P6, including activities, durations, relationships, and resources.
  • Go to the Project tab and click on Maintain Baselines.

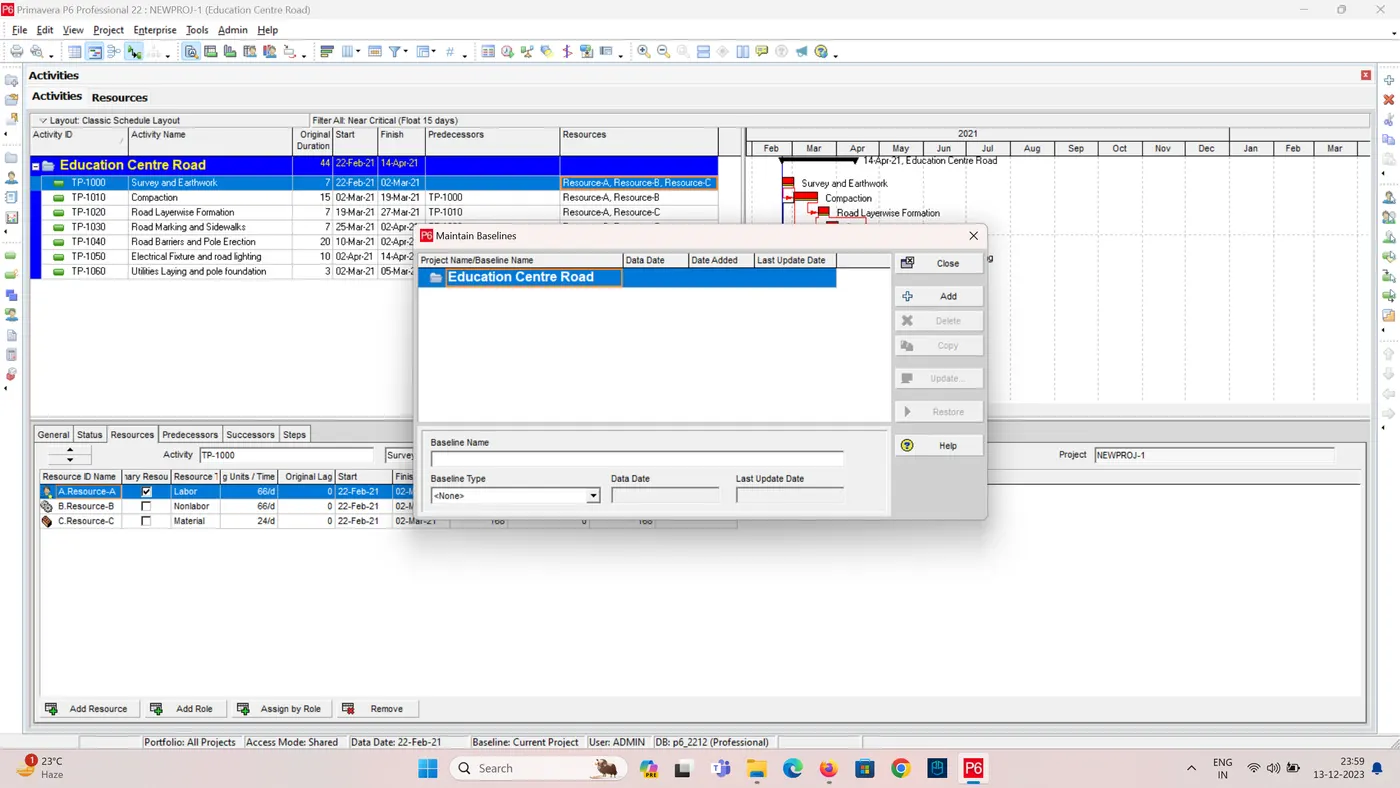

  • Click on Add. Choose Save a Copy of the Current Project as a New Baseline. This creates a complete copy of your current schedule as a baseline.
  • Give your baseline a descriptive name
  • Click OK to save the baseline assignment
  • Assigning a Baseline:

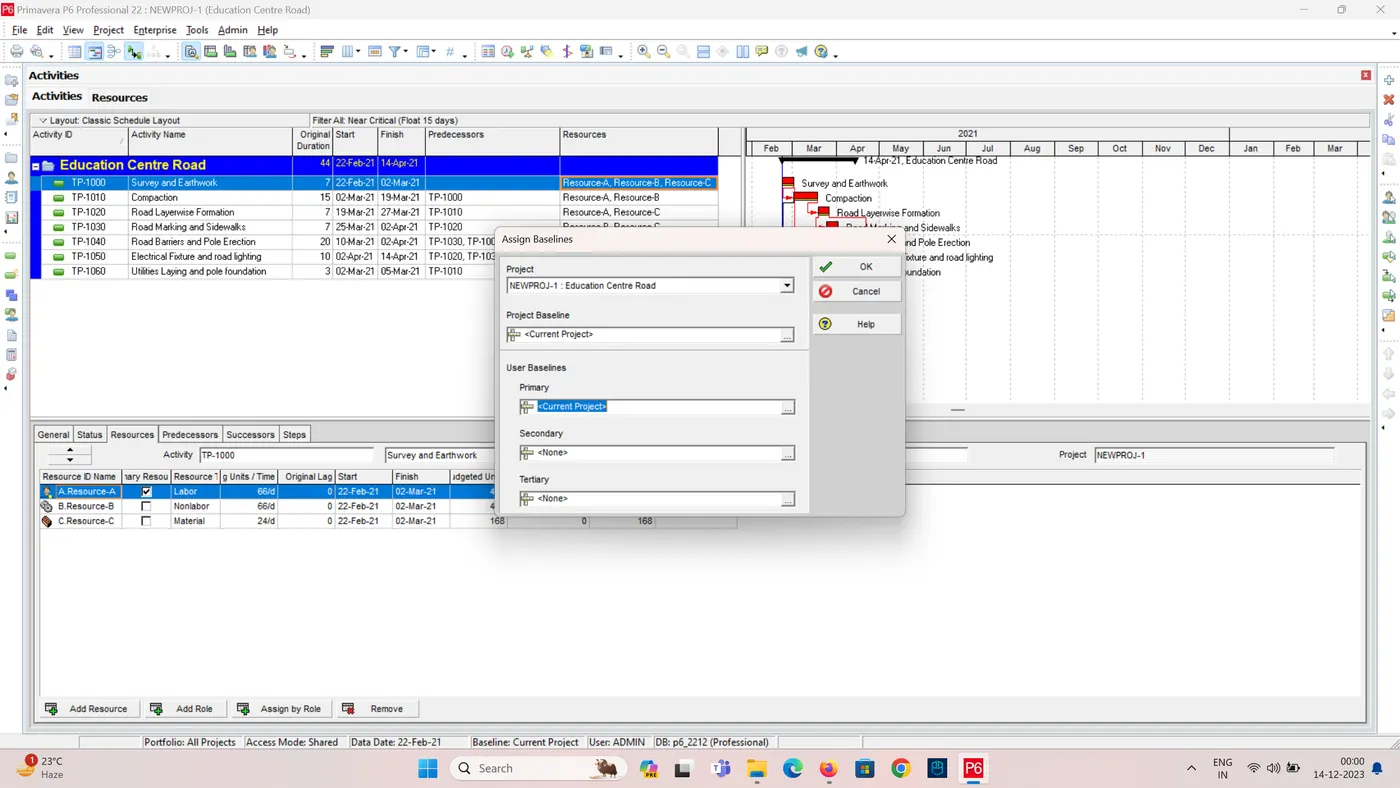

    • go to Project Tab, and select Assign Baseline to assign.
    • Assign created Baseline as Primary and Project Baseline.

6. Add a budget to your project

  • Go to the Projects tab.
  • Click on Budget Log.
  • Enter the Original Budget amount as 6Crs.

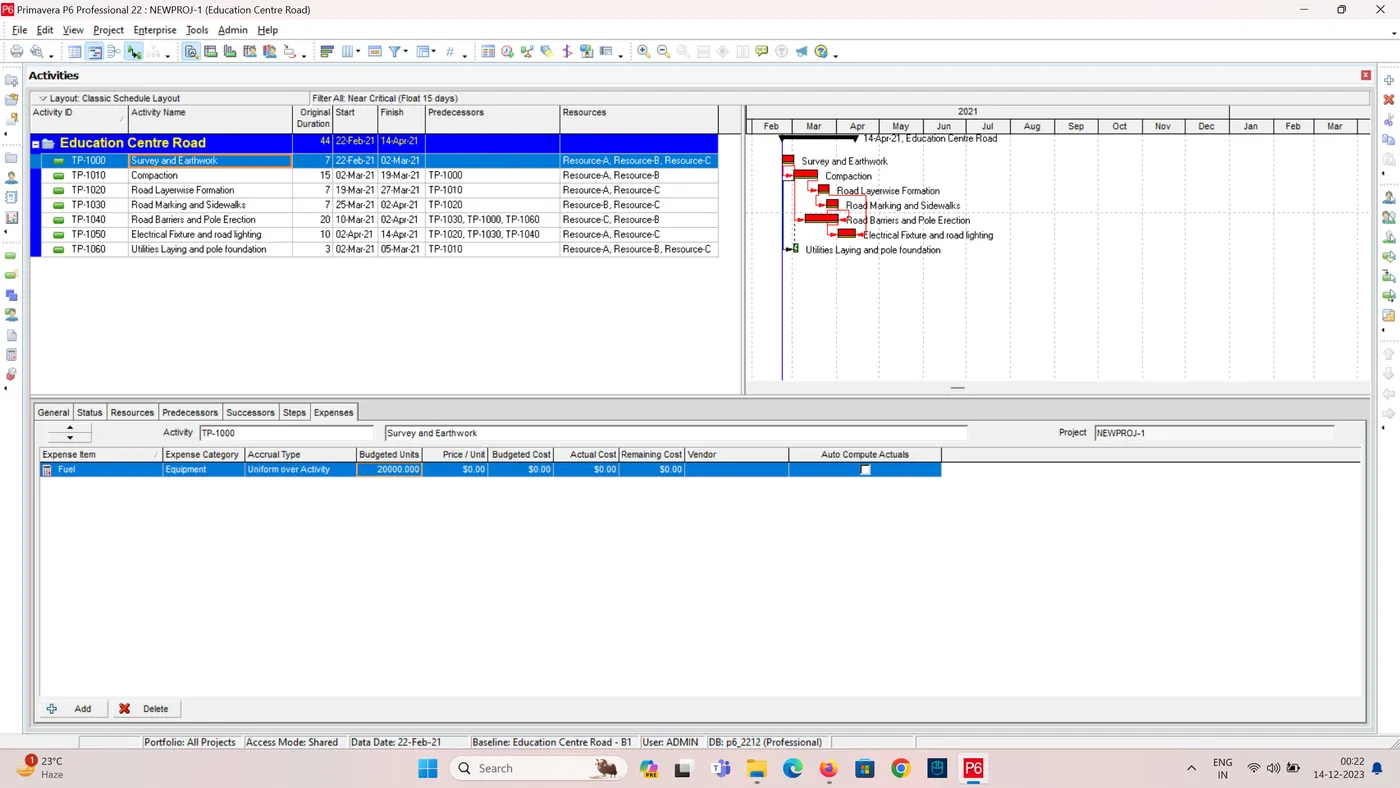

  • Open Expenses Log by adding expenses column.

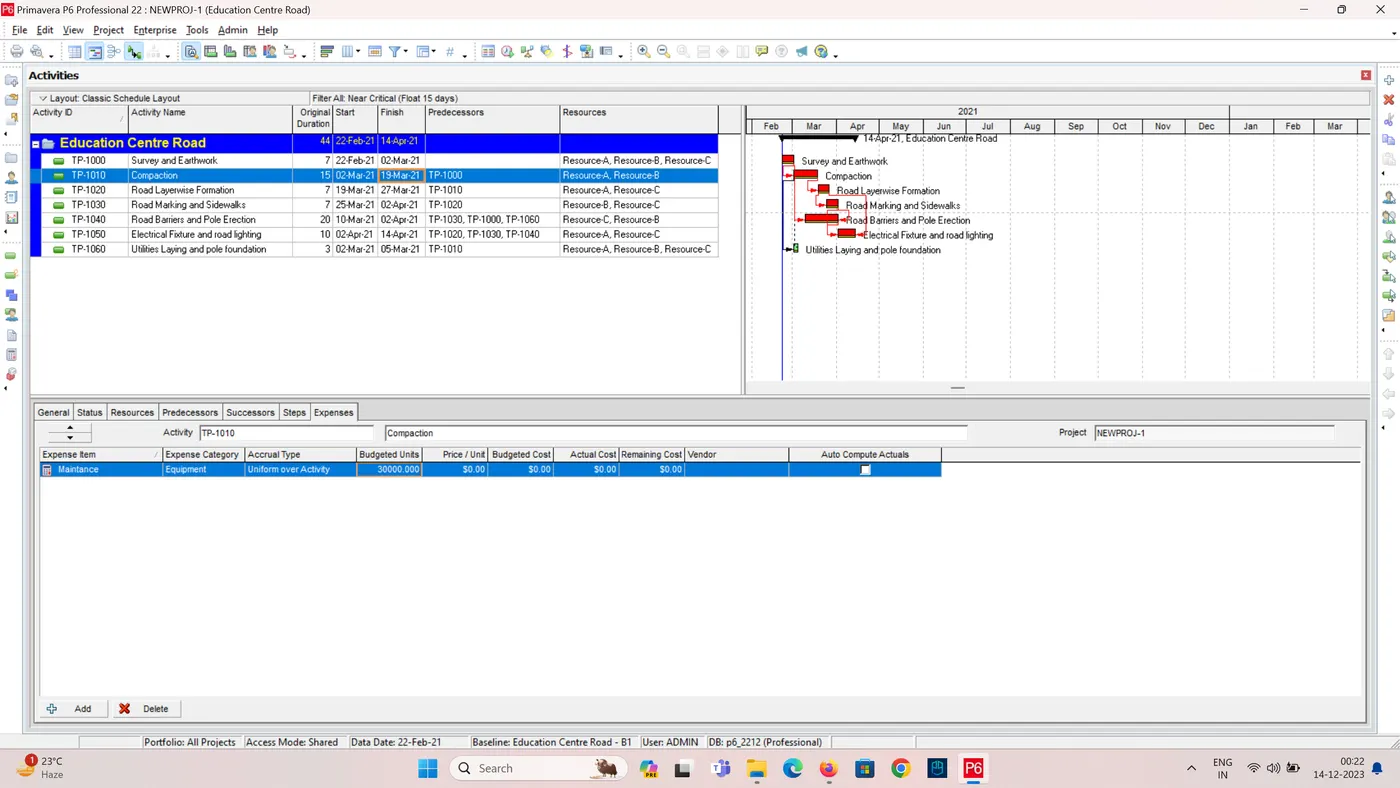

  • Then select the Activity and add expense as given.

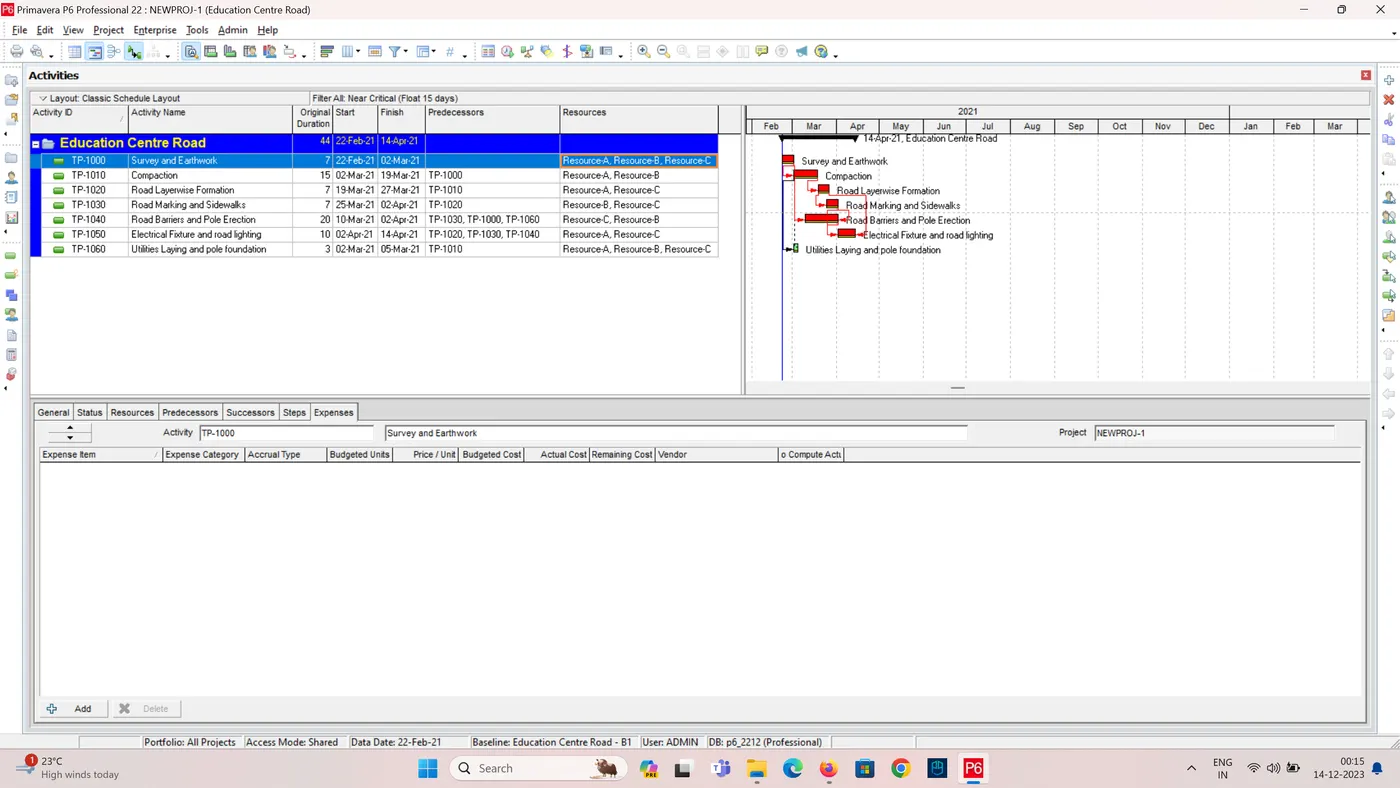

  • Now add all expense to the respected activities.

7. Generate material resource costs curve

  • To show material resources cost curve, we have select Resource Usage Profile.
  • Right click on Curve window and select Resource Usage Profile Option.
  • Choose Cost curve. Now, it shows Material Resource cost Curve

8. Generate an activity wise cost report:

  • Go to Tools Tab, select Report then click Reports.
  • Then Activity Costs, and click Run then click Report.
  • set the page margin carefully to fit the report in sheet.

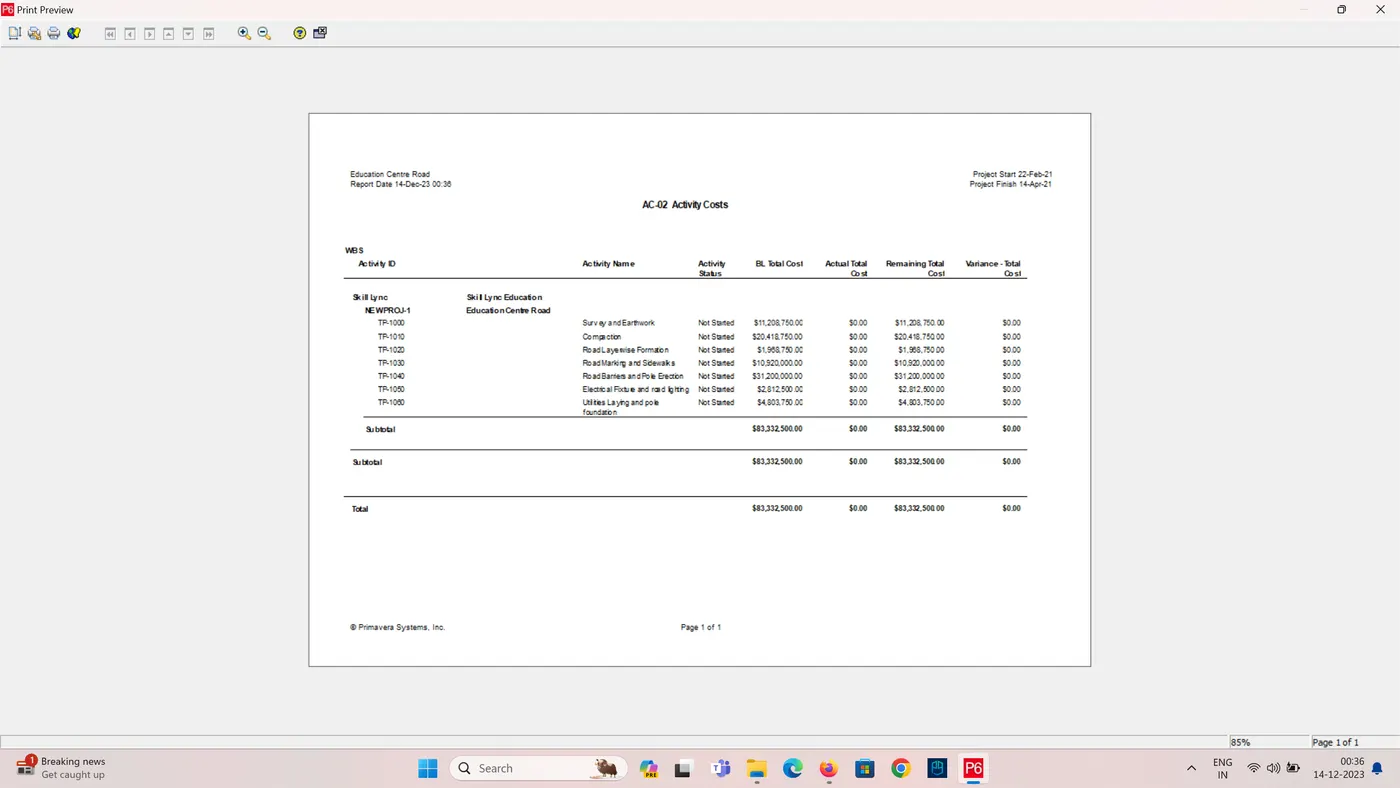

  • Click Print to get hardcopy of the activity cost of your project.

10. Create a reflection and In the reflection, auto update the project at 15 days from start:

  • Right-click on the project in the Projects tab.

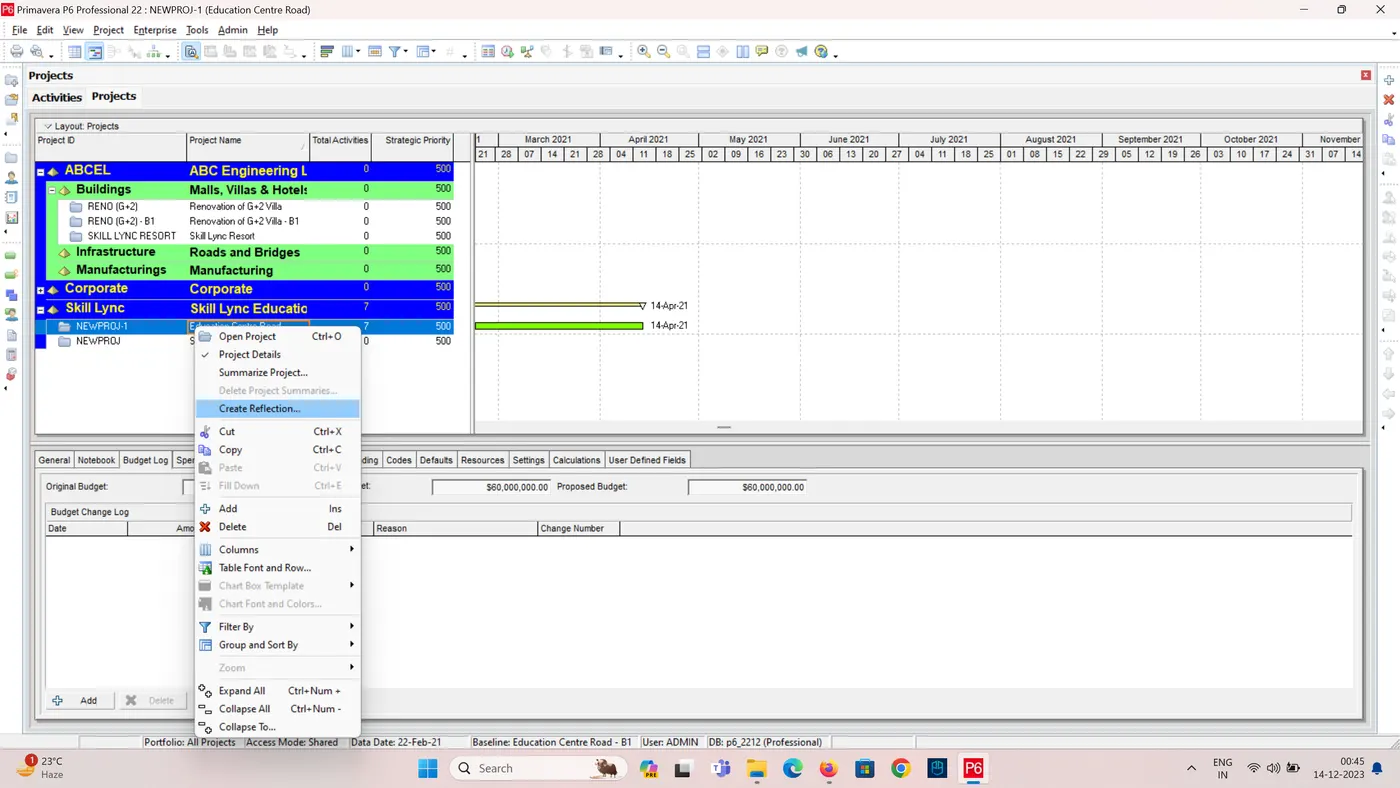

  • Select Create Reflection.
  • A new project file will be created within the same EPS node containing a copy of your original schedule.
  • The reflection project will have a unique name appended with "(Reflection)".
  • Then Open the Reflected Project.
  • Now Click Update Progress from Tools Tab.

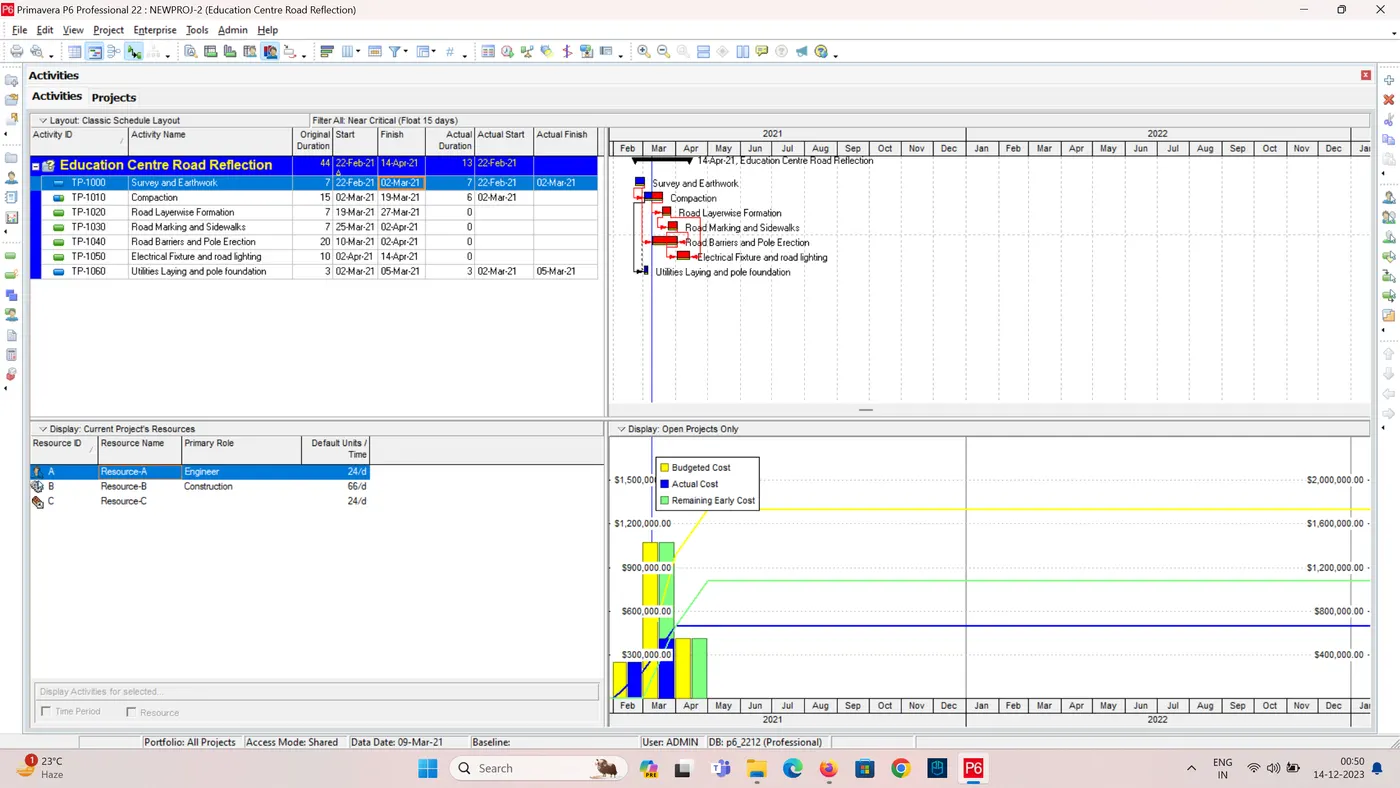

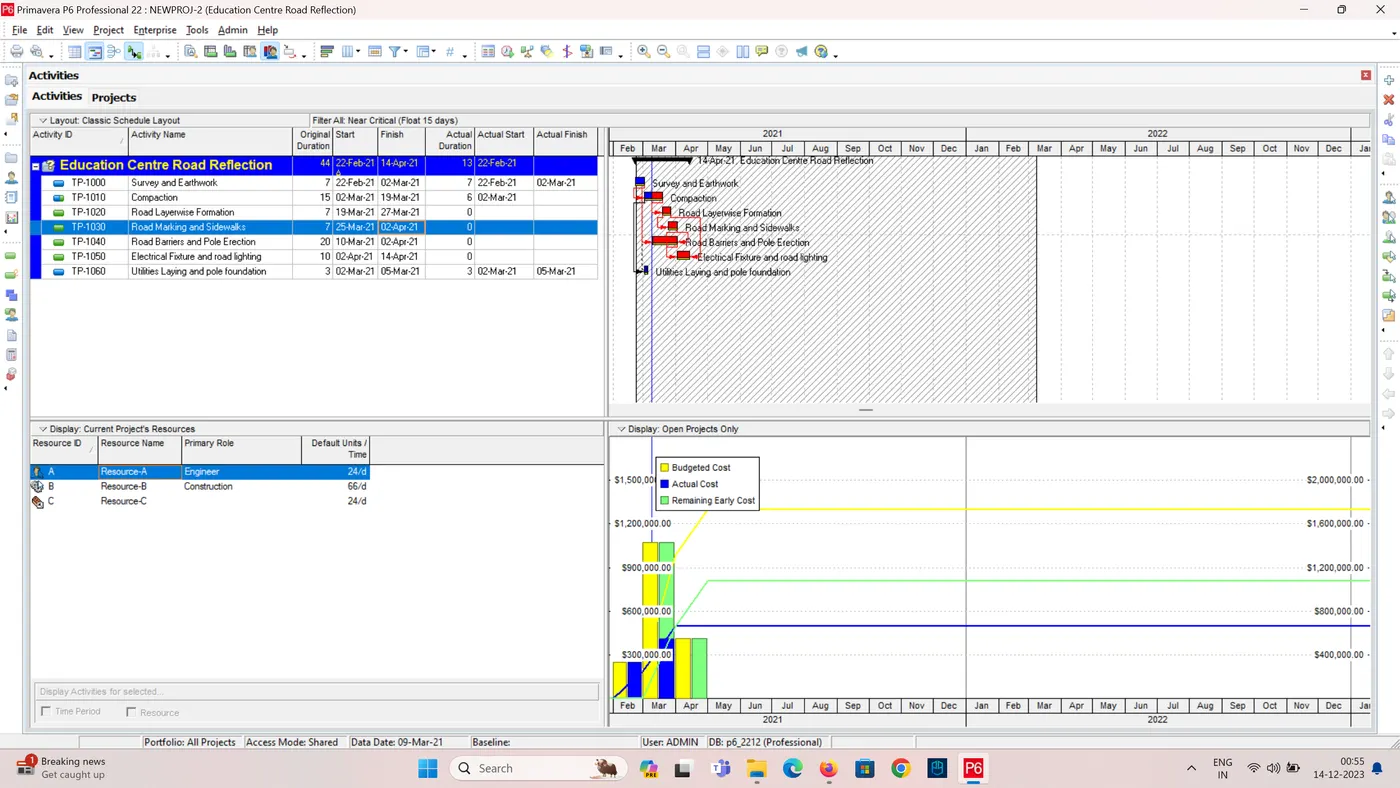

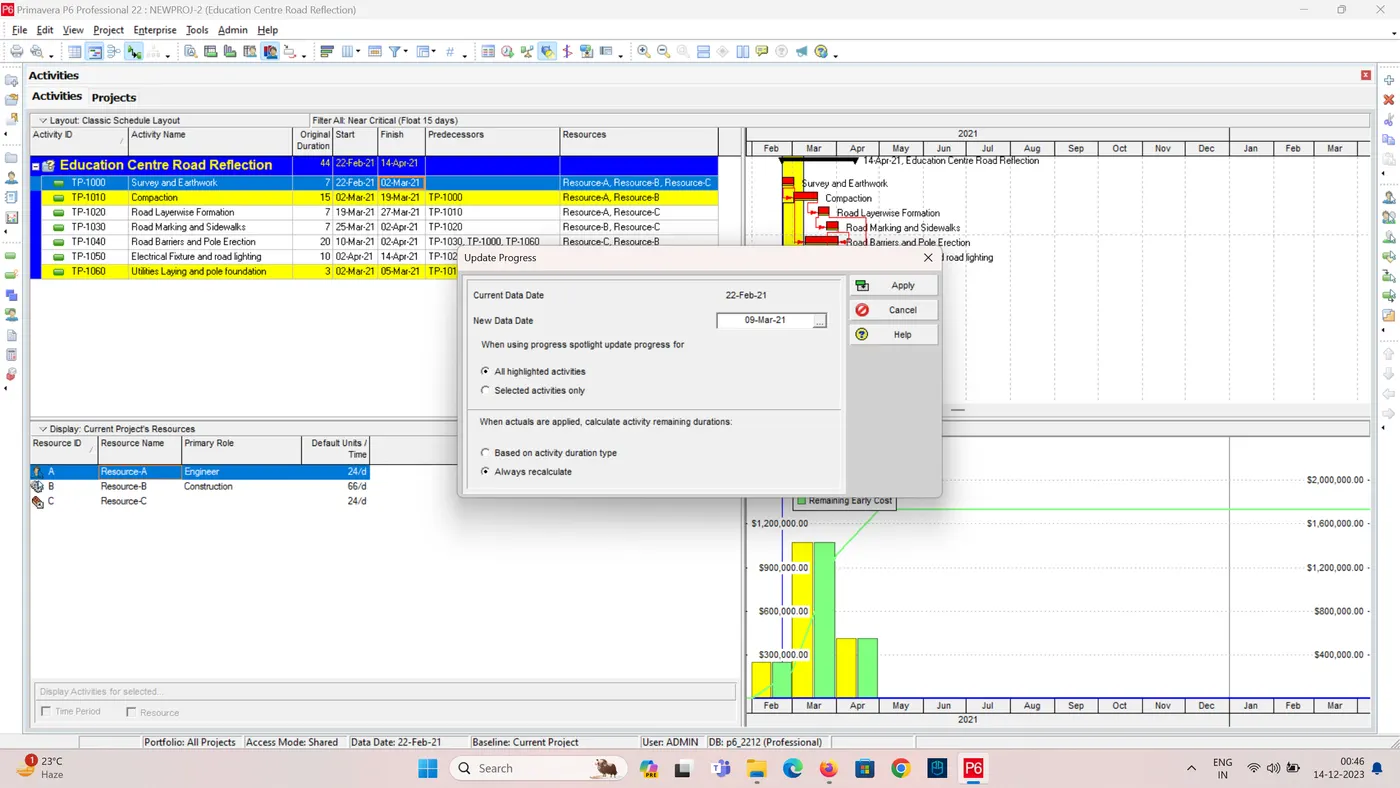

  • Choose 15 days from Start Date (09-Mar-21).
  • Now add column to see the Actual Start and Finish date

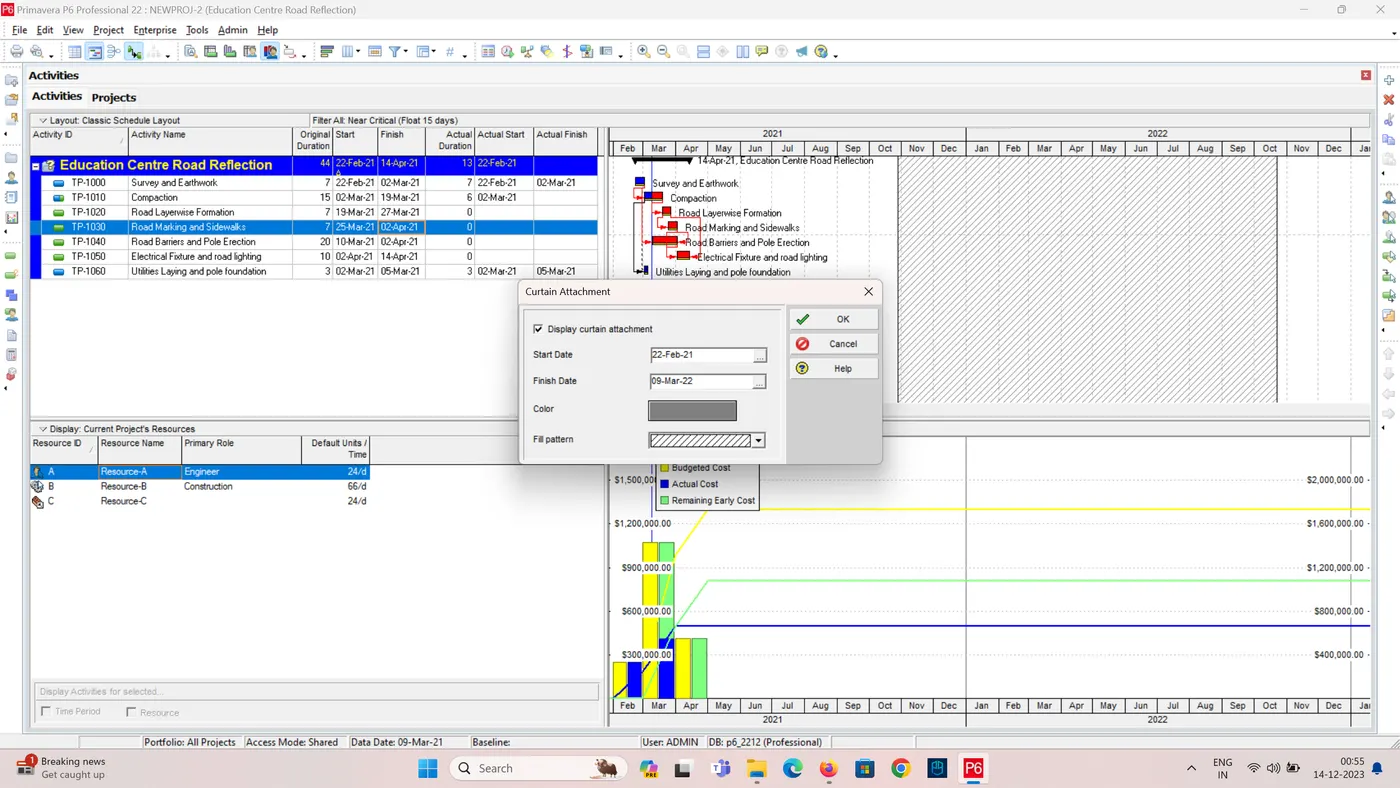

11. Add curtains up-to first 15 days of the project:

  • Right on the gantt chart click attachment then click curtain then add curtain
  • Add the days of the project

12. TSLD view of the project in Visualizer:

1. Activate the Visualizer Module:

  • Go to the Tools tab in your Primavera P6 interface.
  • Click on Visualizer. This will launch the dedicated Visualizer module within Primavera P6.

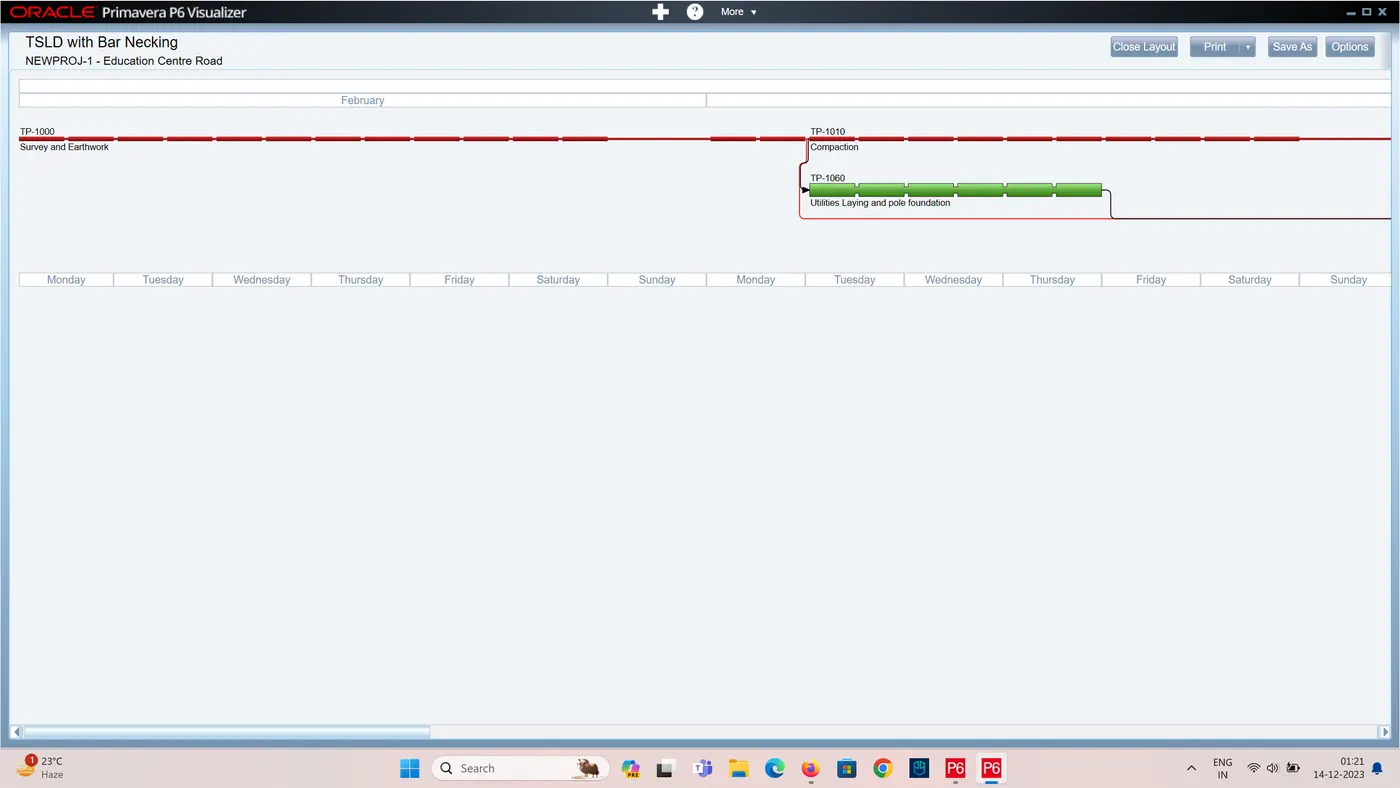

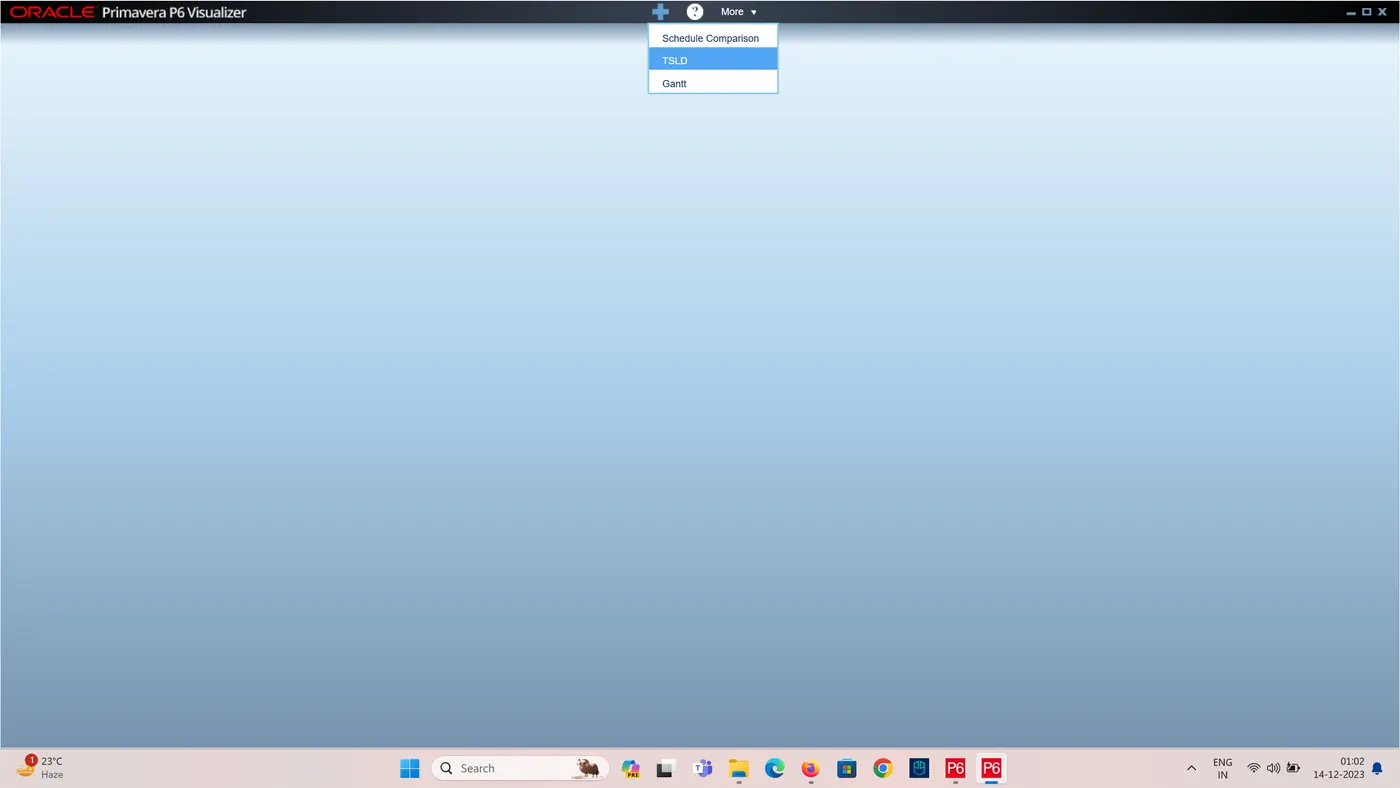

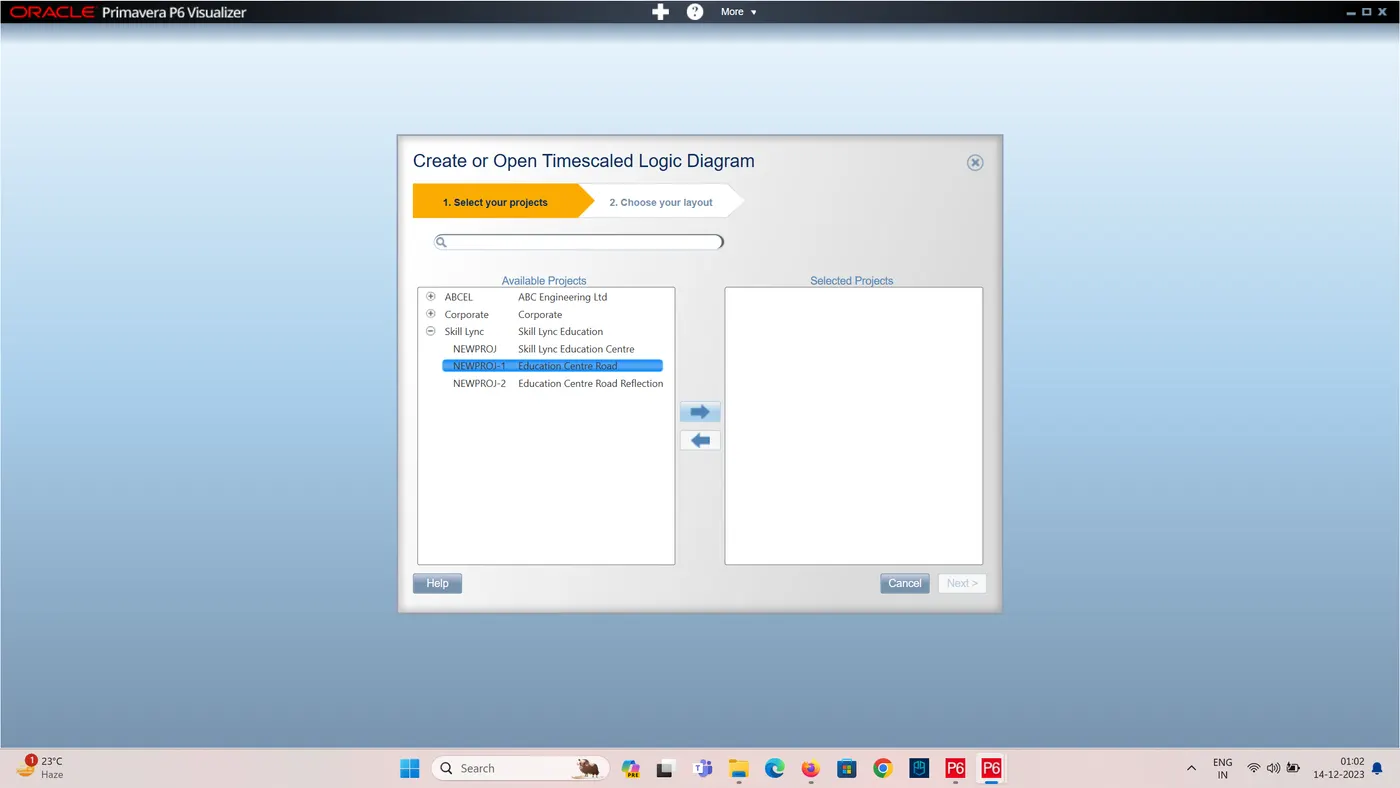

2. Choose the TSLD View:

  • In the Visualizer workspace, you'll see different layout options.
  • Locate the TSLD button or icon. It might be located in the main menu bar, a dedicated layout category, or a context menu depending on your Primavera P6 version.
  • Click on the TSLD button.

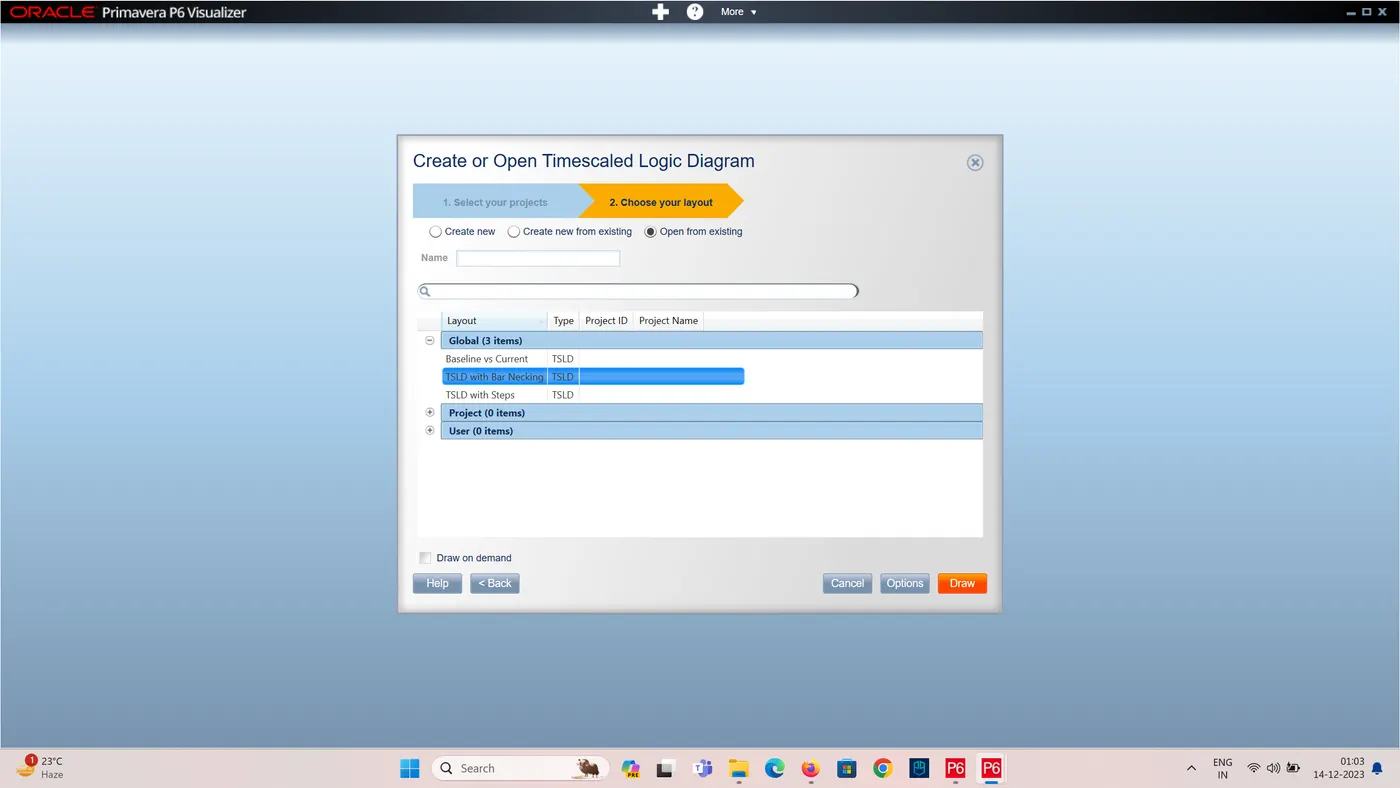

3. Customize your TSLD:

  • Primavera P6 Visualizer will present you with a blank TSLD canvas.
  • You can now add activities and relationships to build your project's logic diagram.
  • Use the available tools and options to customize the TSLD view:
    • Activity List: Drag and drop activities from the list to the canvas.
    • Relationships: Connect activities with arrows to represent dependencies.
    • Formatting: Adjust colors, line styles, labels, and other visual elements of your TSLD.
    • Timescales: Define and display relevant timescales at the top or bottom of the diagram.
    • Filters: Apply filters to focus on specific activities or aspects of your project.

4. Save and Share your TSLD:

  • Once you've built and customized your TSLD, you can save it for future use or share it with others.
  • Use the Save or Export options within Visualizer.
  • You can save your TSLD as a VLF file (specific to Primavera P6) or export it to other formats like PDF or image files.

Conclusion:

Hence , the project schedule for the given work is completed.
