Challenge

Project 2

A 100 m WBM road needs to be constructed inside the Skill Lync Education center premises to allow access to the centre for students and faculties.
Create the following Project (under same EPS/OBS as project-1) and Resource :
Project Name - Education Centre Road
Assume - Calendar as 6 x 24 and start date on 22nd feb 2021

Please do the following:
1. Develop the project schedule as per the criteria above
2. Use 3-Tier timescale with Year / Month / Weeks
3. Define and Add resources
4. Add a budget to your project - INR 6 cr.
5. Assign a baseline to the project
6. Add following expense:
Task - 1 - Rs 20,000/- (Item - Fuel)
Task - 2 - Rs 30,000 /- (Item - Maintenance)
7. Generate material resource costs curve
8. Generate an activity wise cost report
9. Create a reflection
10. In the reflection, auto update the project at 15 days from start
11. Open a TSLD view of the project in Visualizer
12. Add curtains up-to first 15 days of the project.
13. Find out the actual cost for labour, non-labour and material cost of the updated schedule

Aim:-
To develop the project schedule as per the criteria above.
Procedure:-
Step 1:-
  • Open Primavera P6 Software.
  • Go to Enterprise and click Project.

  • Then Click Add, a New window opens.

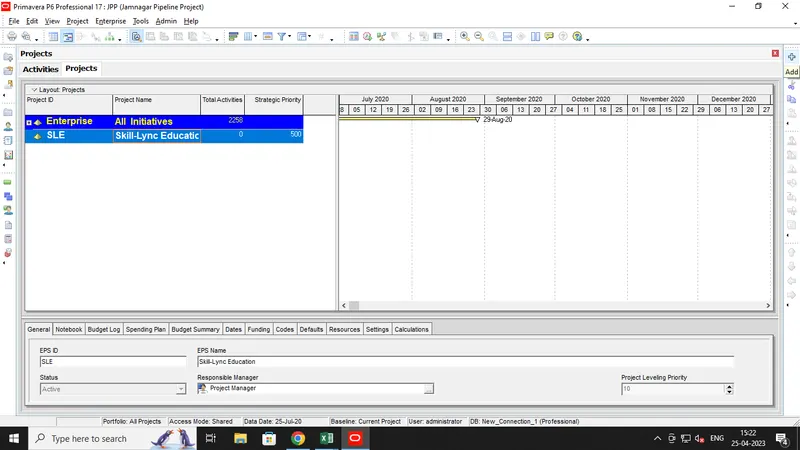

  • Then Select EPS as Skill-Lync Education.

  • Then Enter Project ID and Project Name as Education Centre Road.

  • Define Project Start Date and Assign Responsible Manager as Project Manager.

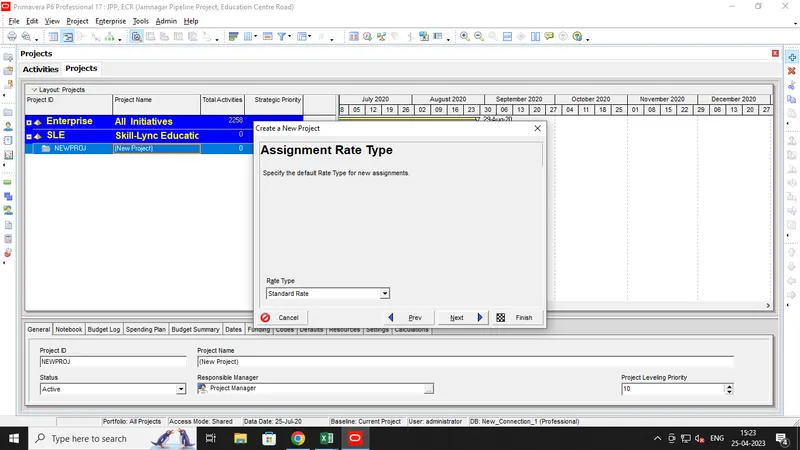

  • Then Select Standard Rate for Rate Type.
  • And Click Finish to Create a Project.

Step 2:-

  • Now Select and Open the Project "Education Centre Road".

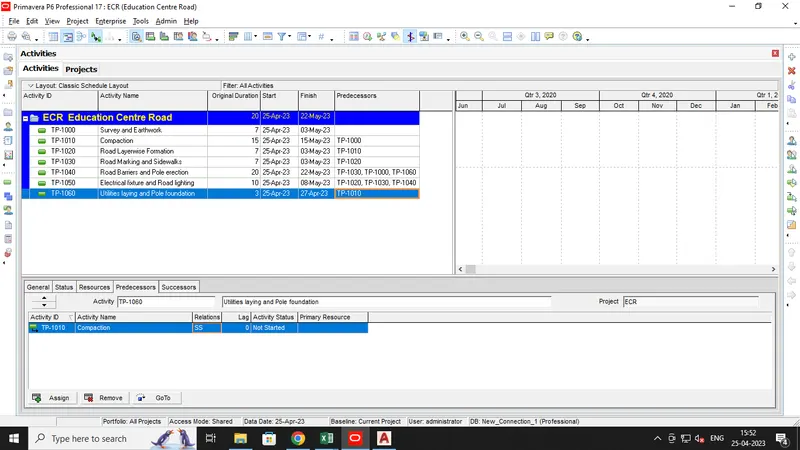

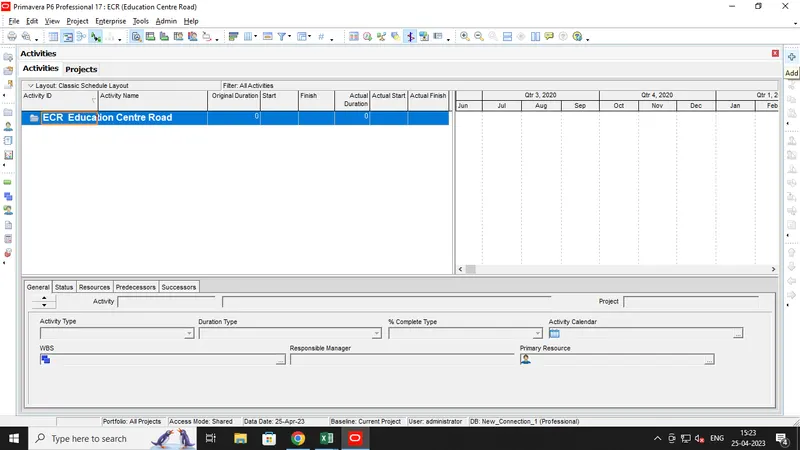

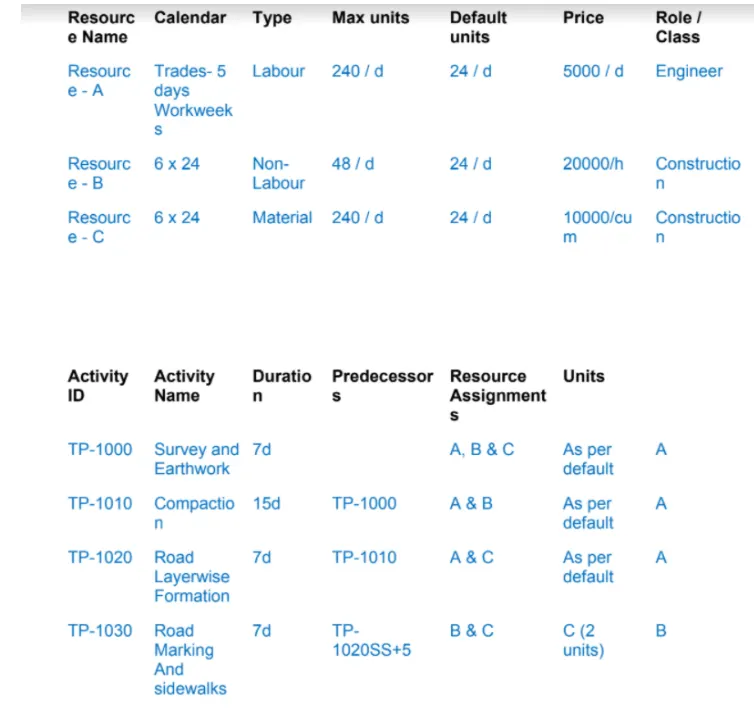

  • Now Project opened and then Add Activities as given above.

  • After Activity addition give Durations as shown below.

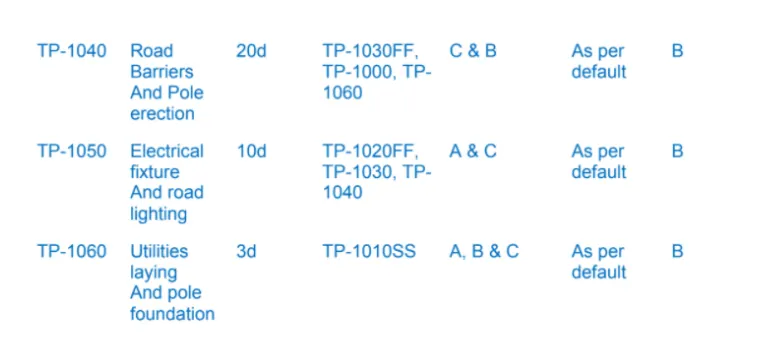

  • Then Assign relationships as shown below.

Step 3:-

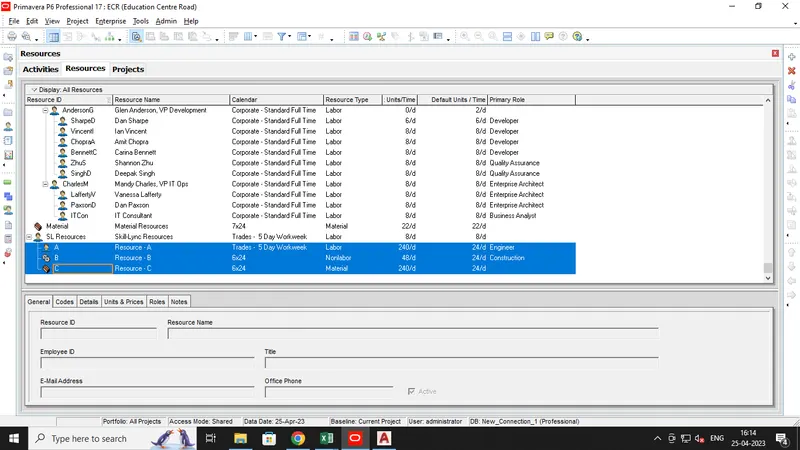

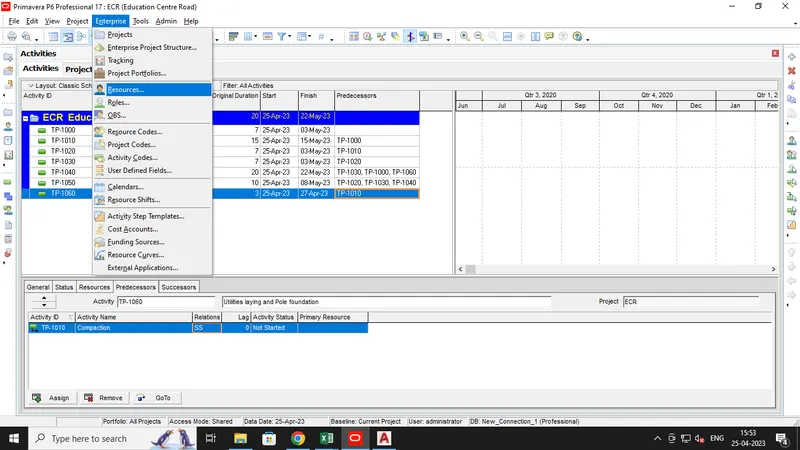

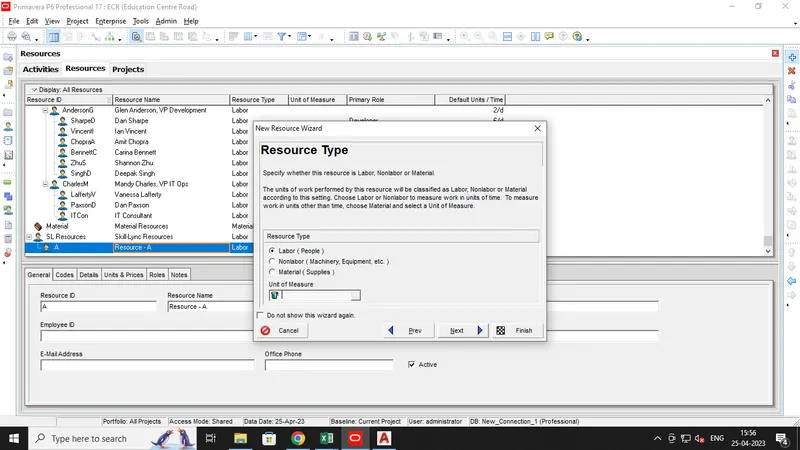

  • Go to Enterprise Tab, then select Resources to define Resources.

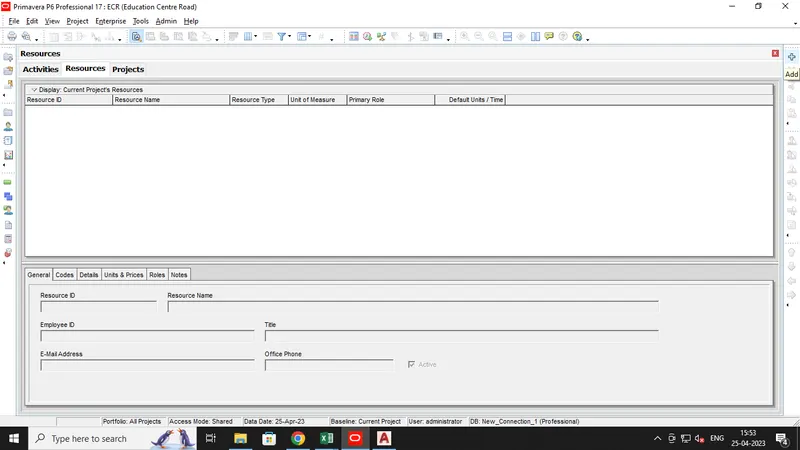

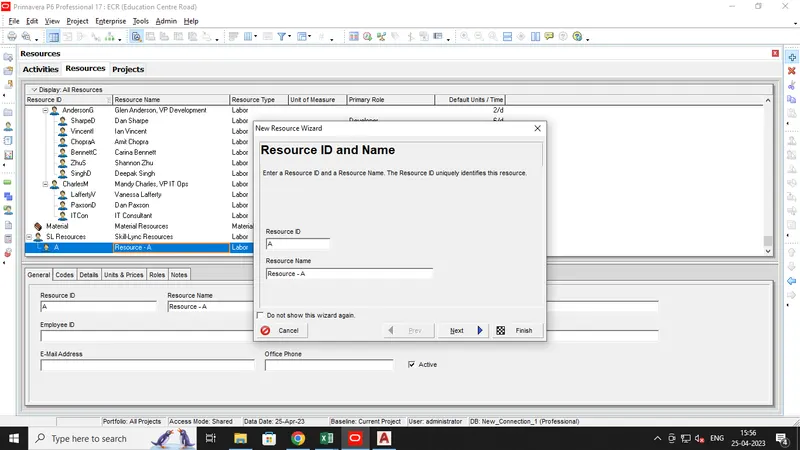

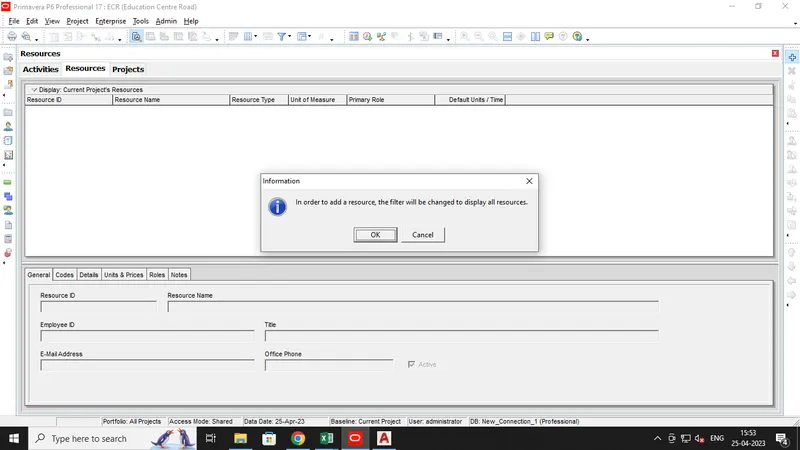

  • Now new window pops up, then click Add icon.

  • Now define Resource ID and Resoure Name. as shown below.

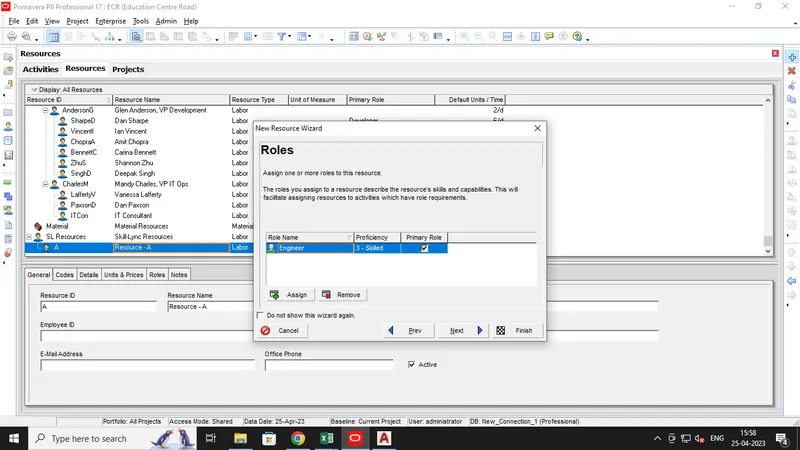

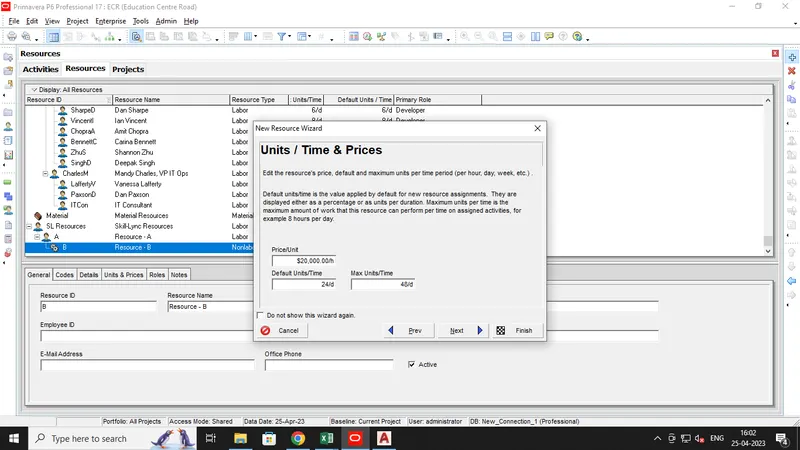

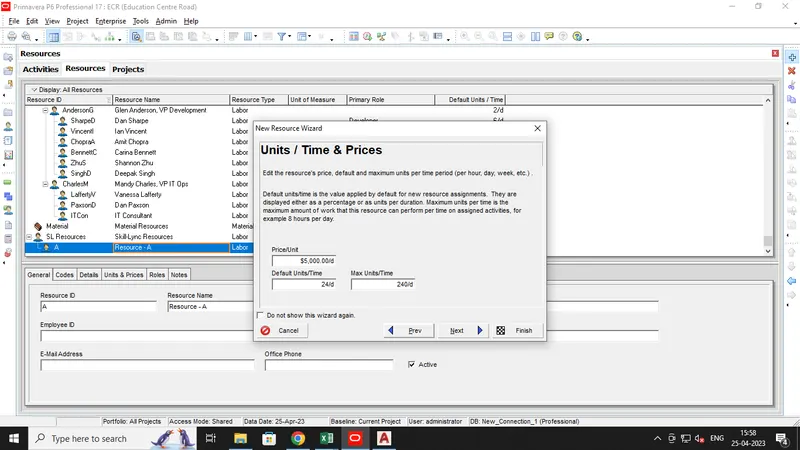

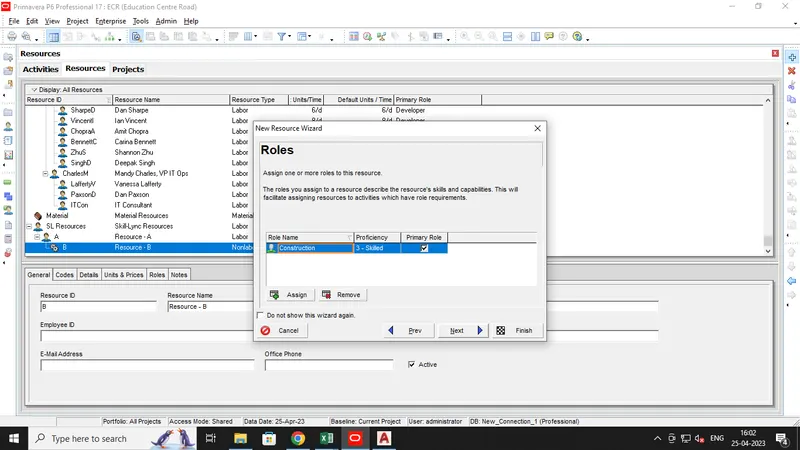

  • Then Select Resource Type, Unit/Time & Prices and Roles of Resources.

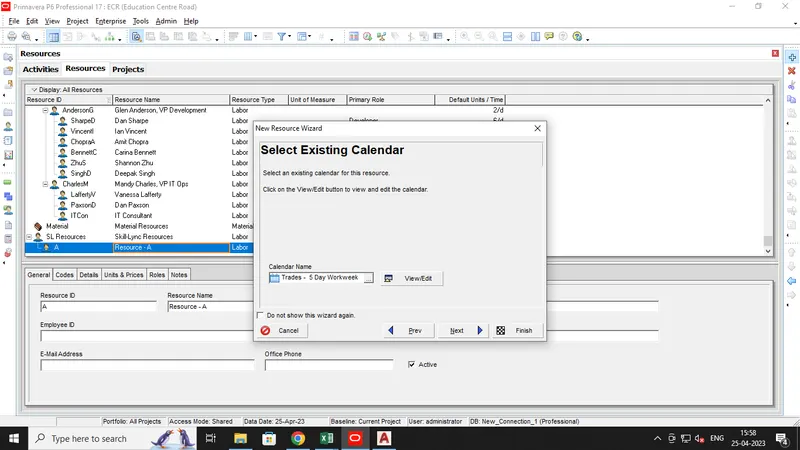

  • Then Select Calender, and click Finish.

  • Similarly Add other resources.

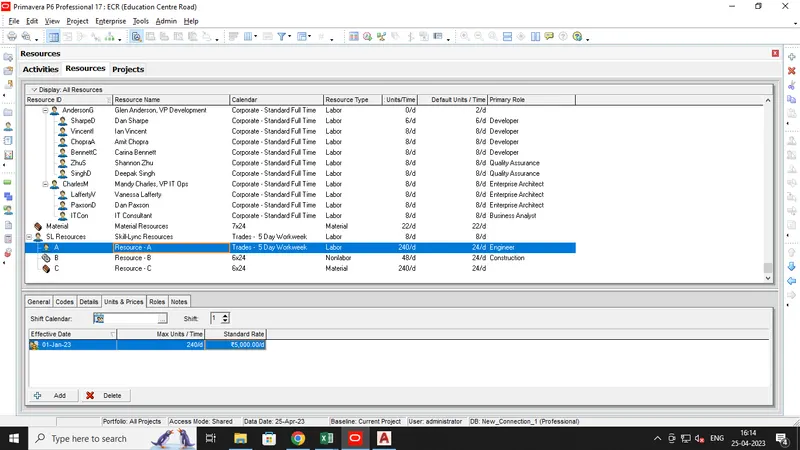

  • Resources add successfully.

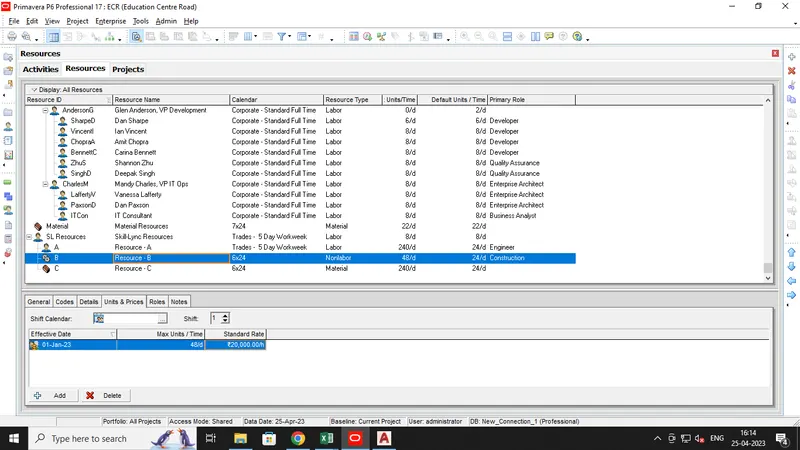

  • Now assign resources to the particular activities as shown below.

Step 4:-

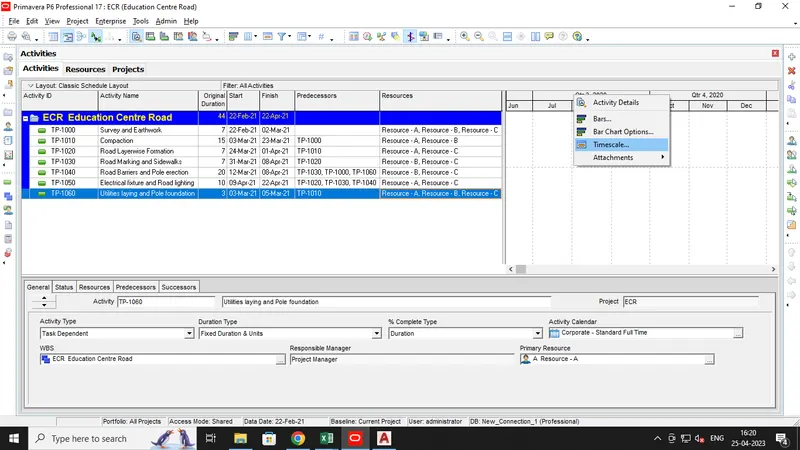

  • To Change Timescale in Gantt Chart, first we need to Right click anywhere on Gantt Chart.

  • Then select Three Lines, and select Year/Month and Week as shown below.

  • WQe can see the Timescale changed.

Step 5:-

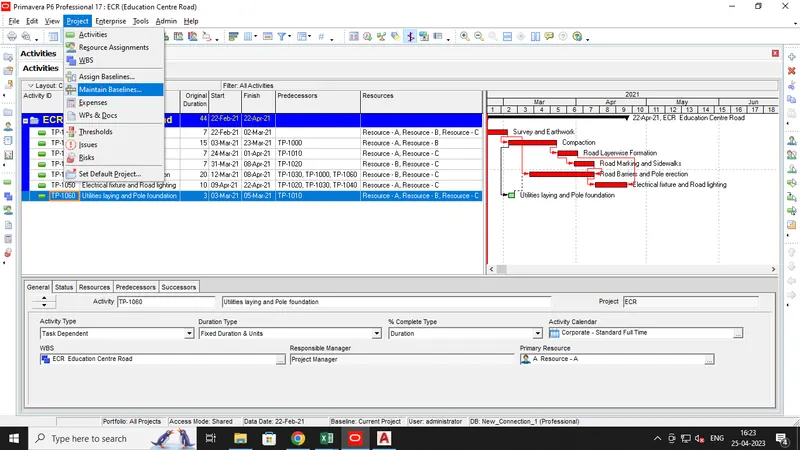

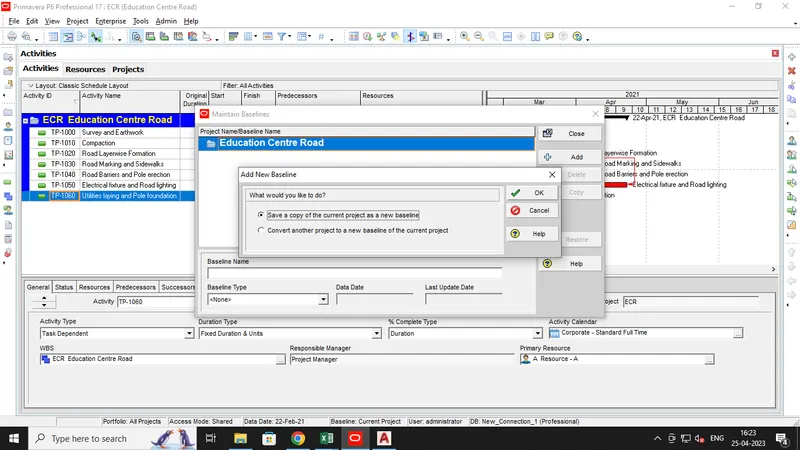

  • Now add Baseline by selecting Maintain Baseline from Project Tab.

  • Then Click Add and change type Initial Planning.

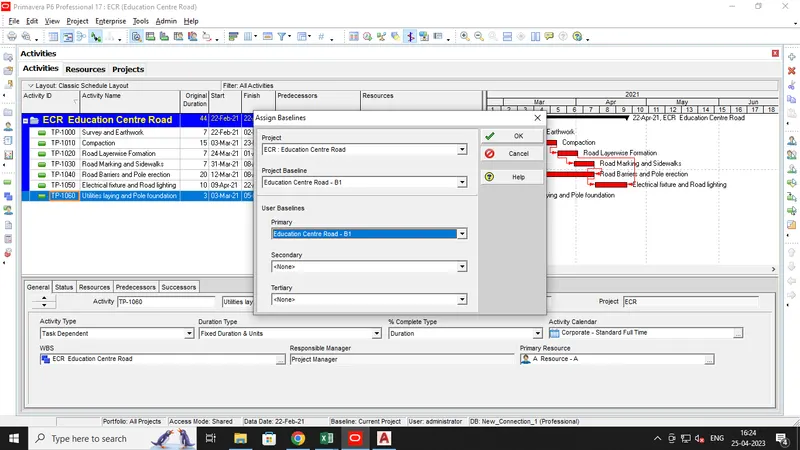

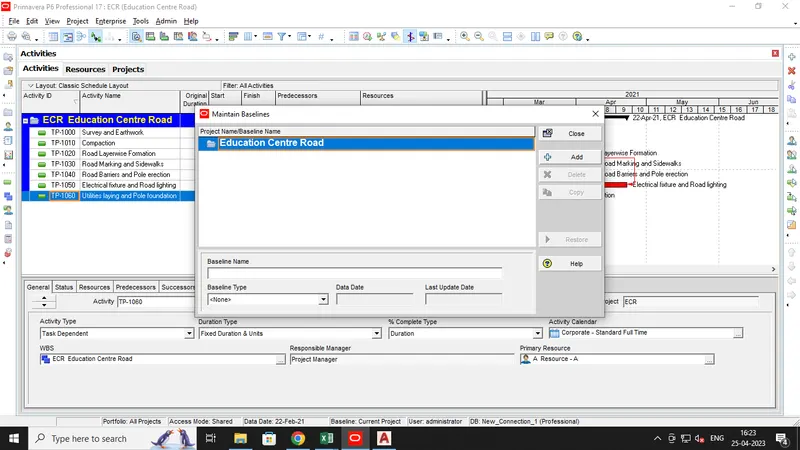

  • Again go to Project Tab, and select Assign Baseline to assign.

  • Assign created Baseline as Primary and Project Baseline.

Step 6:-

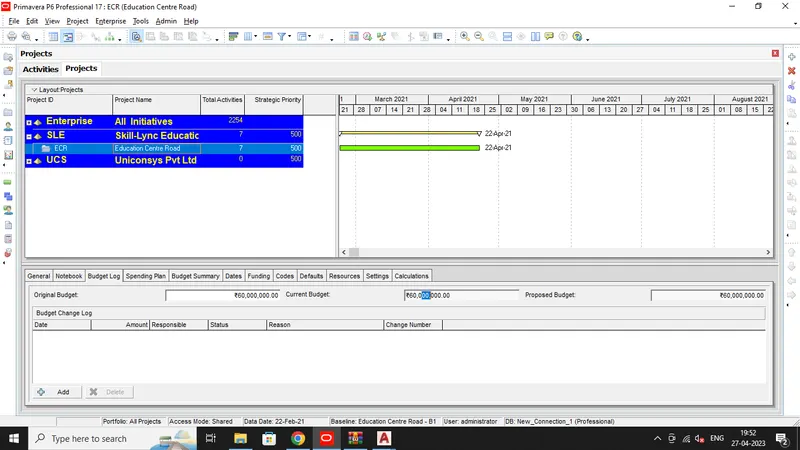

  • Go to Project window and add Project Budget 6 cr. into the Original Budget as shoen below.

  • Now add expense, adding Expenses column.

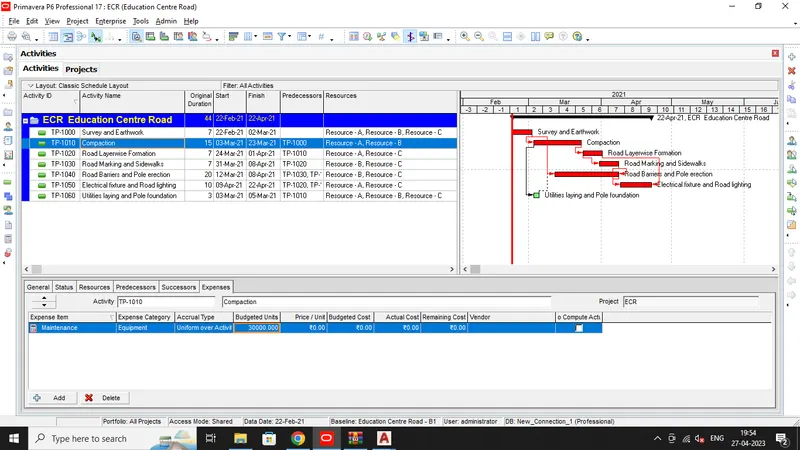

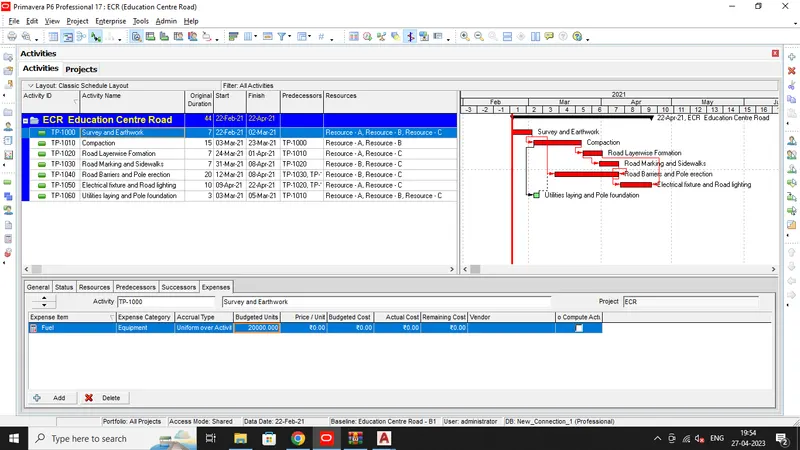

  • Then select the Activity and add expense as shoen below.
  • It includes Expense item, category and budgeted Units.

  • Similary add all expense to the activities.

Step 7:-

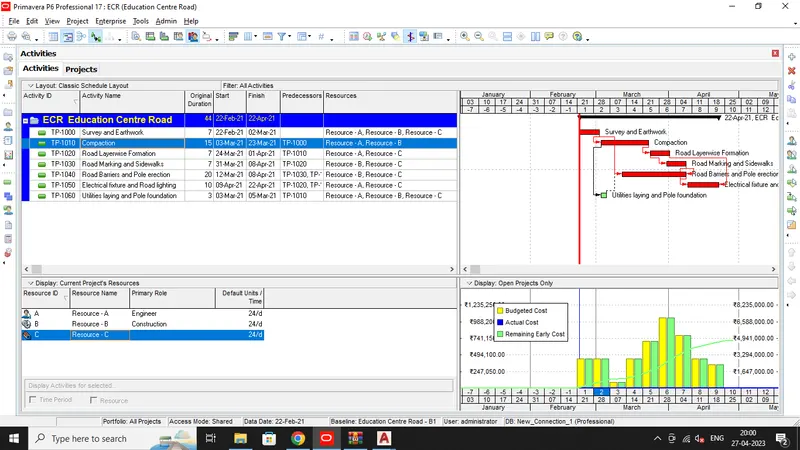

  • To show material resources cost curve, we have open Resource Usage Profile a shoen below.

  • Right click on Curve window and select Resource Usage Profile Option.

  • Choose Cost curve.

  • Now it shows Material Resource cost Curve.

Step 8:-

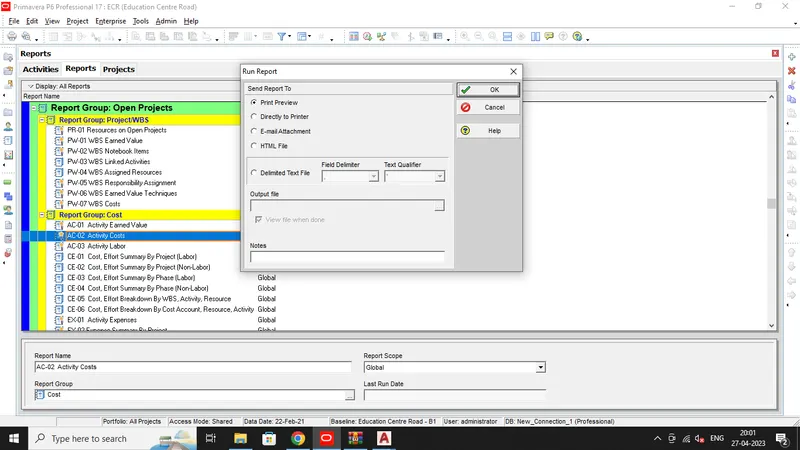

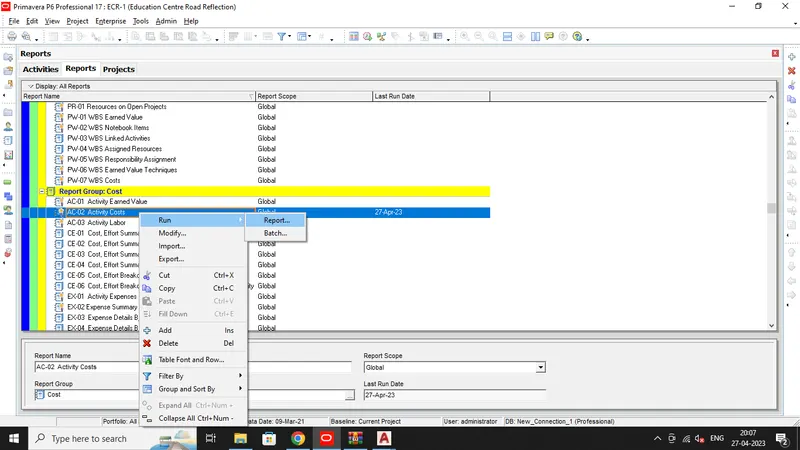

  • Go to Tools Tab, select Report > Reports.

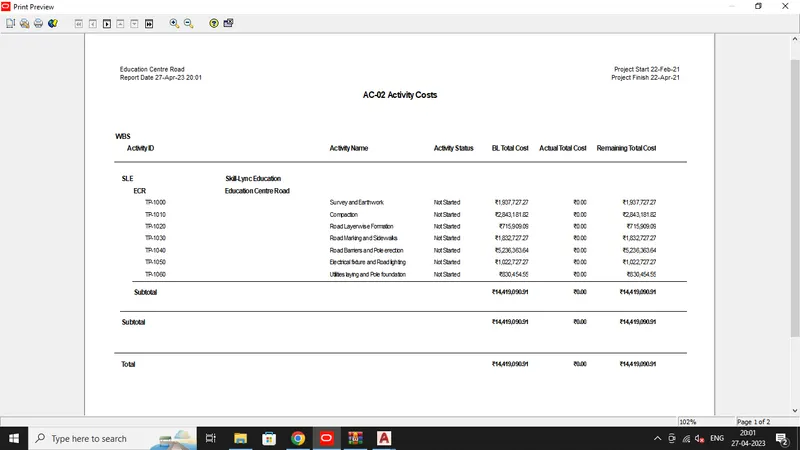

  • Then Actual Costs, and click Run > Report.

  • Report Generated successfully.

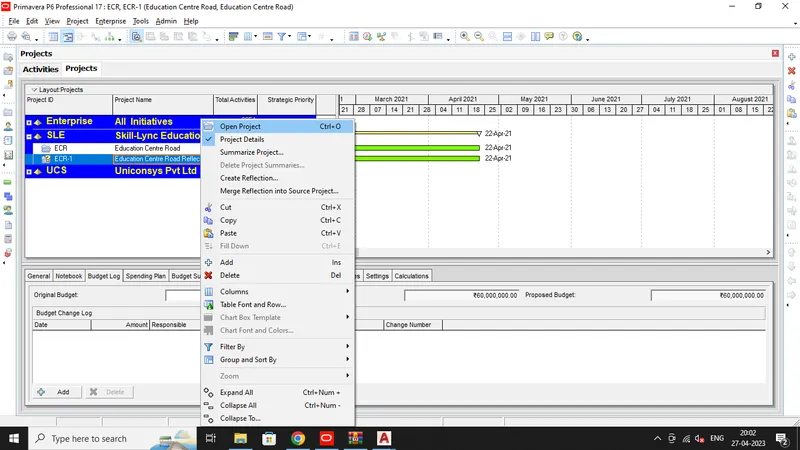

Step 9:-

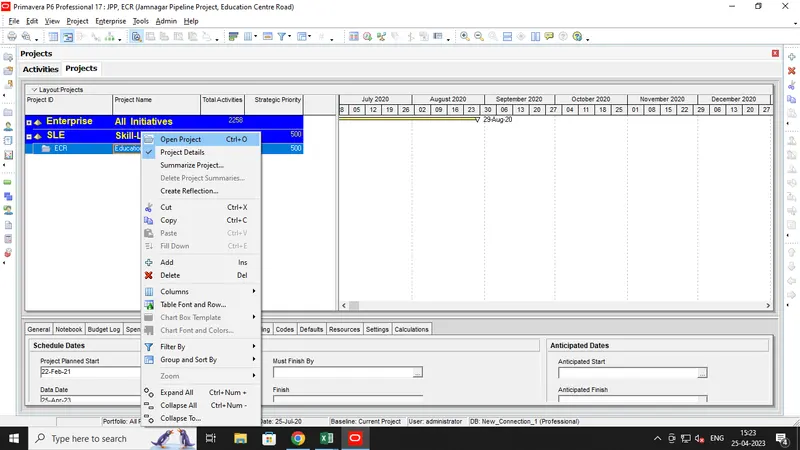

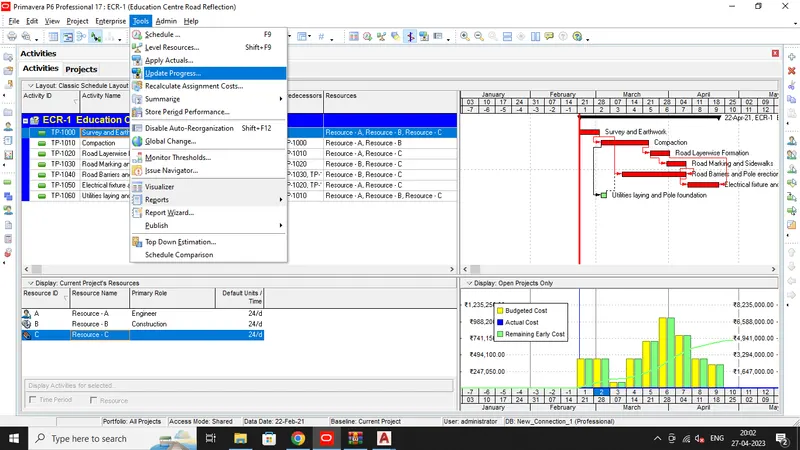

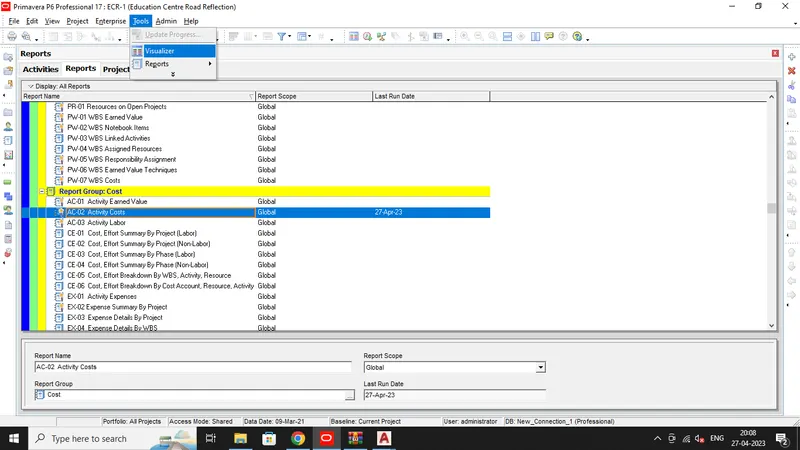

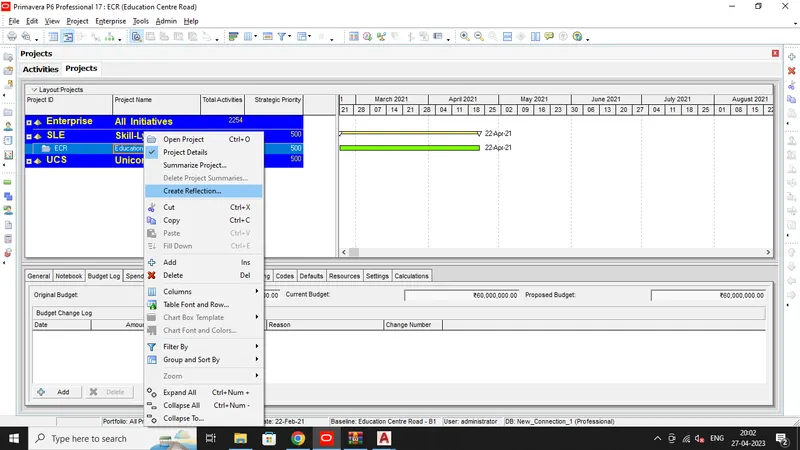

  • To create Reflection of the project, Right click the Project on Projects Window.
  • Click Create Reflection option.

  • Choose Baseline and click Ok.

  • Then Open the Reflected Project.

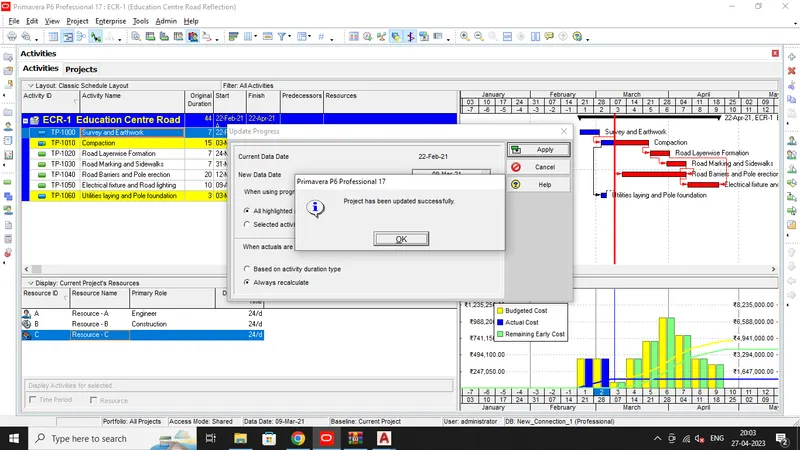

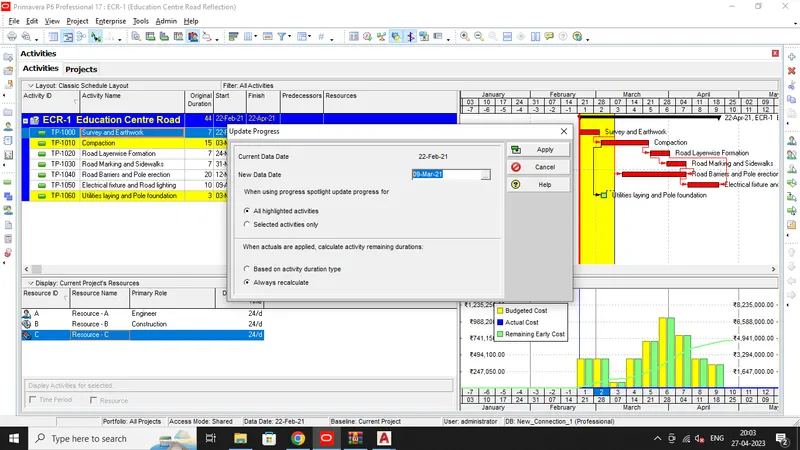

  • Now Click Update Progress from Tools Tab.

  • Choose 15 days from Start Date (09-Mar-21).

  • Now add column to see the Actual Start and Finish date.

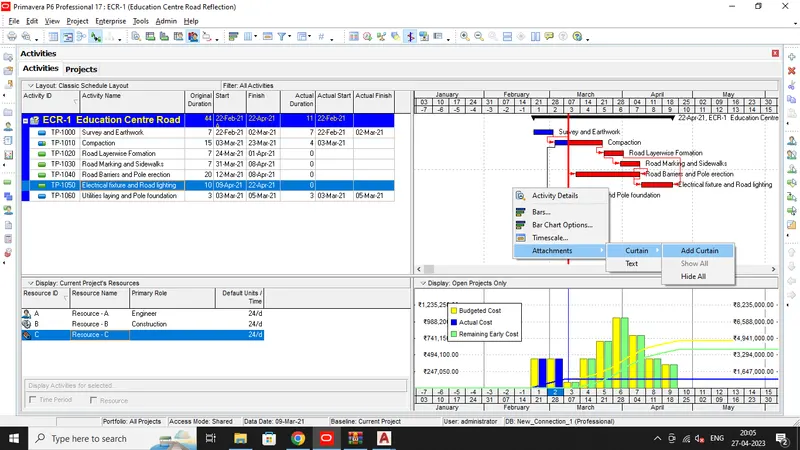

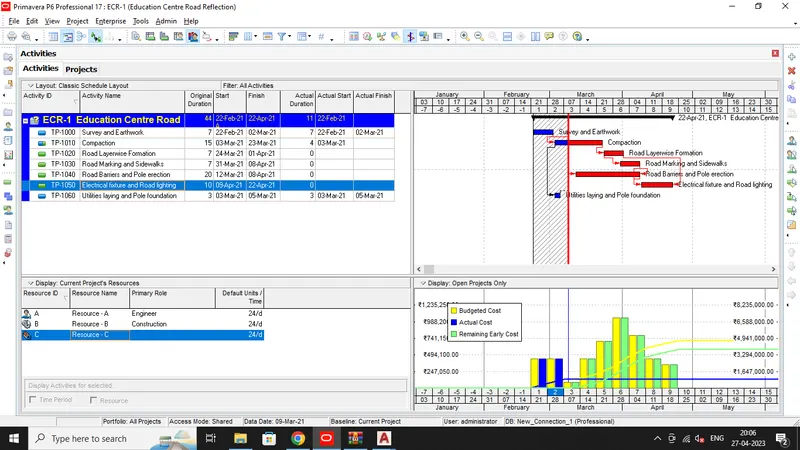

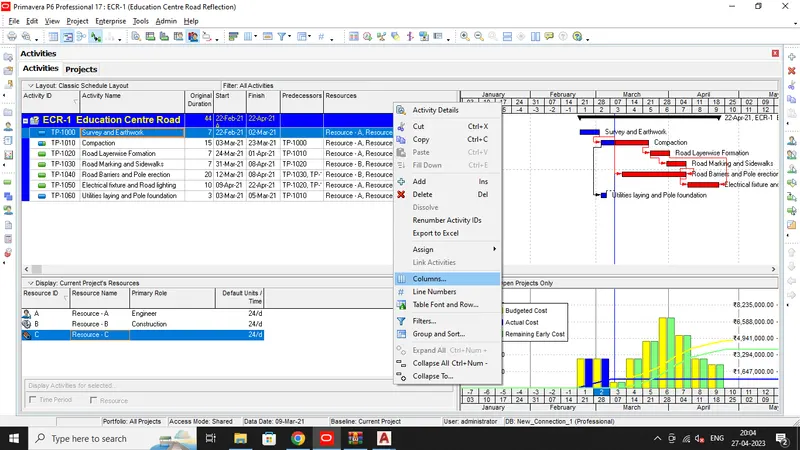

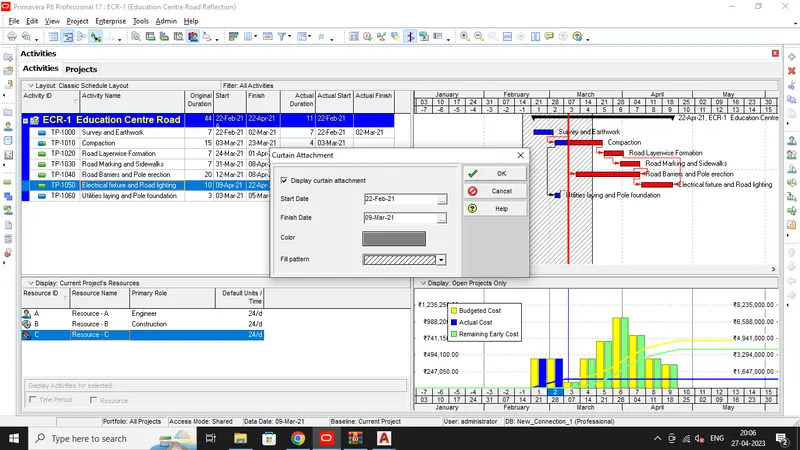

  • Now Curtain for first 15 Days from Attachments as shown below.

  • Curtain added successfully.

  • To see Actual Cost report for Updated schedule, again go to Tools tab and Reports > Reports.

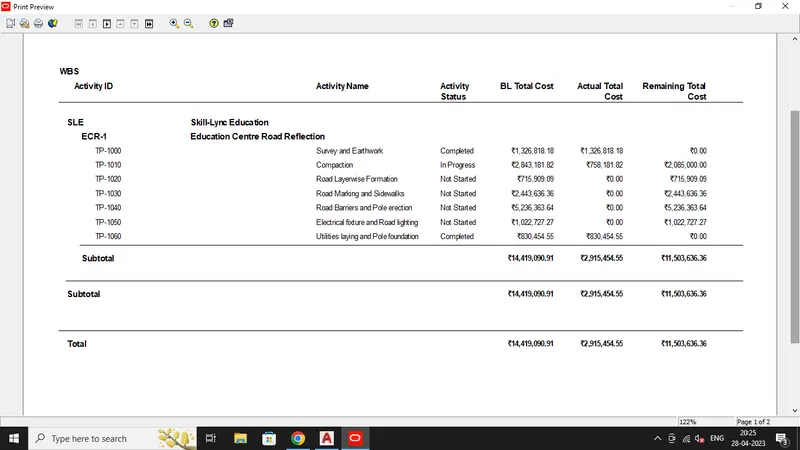

  • Then Actual Cost and Click Run > Report.

Step 10:-

  • Go to Tools Menu and select Visualizer.

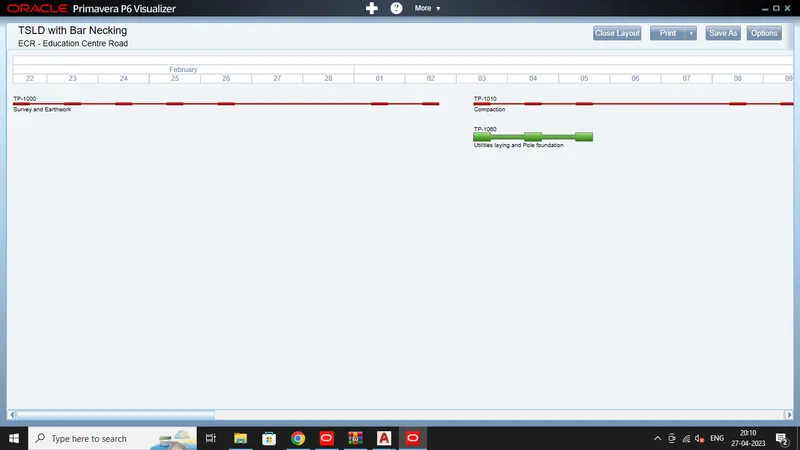

  • P6 Visualizer opens, in that select TSLD layout.

  • Select the Project, choose TSLD Bar Necking and draw the Layout.

  • Layout generated successfully.

Result:-

  • The Project Schedule was developed for the Skill-Lync Education Centre Road as per the all given inputs.
