Project 2
AIM:
A 100 m WBM road needs to be constructed inside the Skill Lync Education center premises to allow access to the center for students and faculties.
Create the following Project (under same EPS/OBS as project-1) and Resource :
Project Name - Education Centre Road
Assume - Calendar as 6 x 24 and start date on 22nd Feb 2021
Procedure :
*Open the previous project in P6

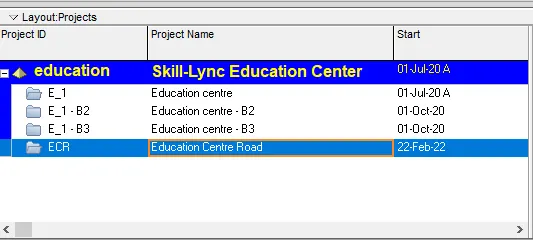

*Go to projects page > new project

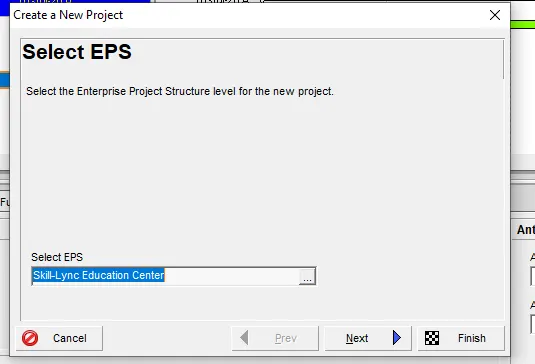

*Choose eps as previous " Skill-Lync education "

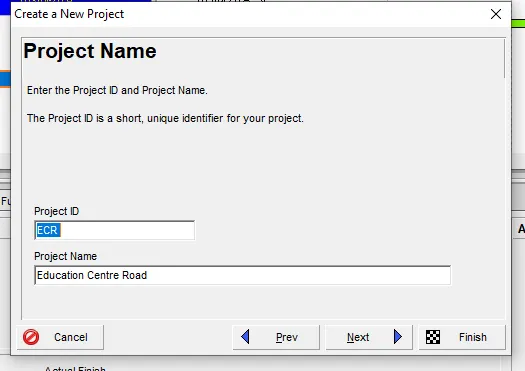

*name the project as Education Centre Road

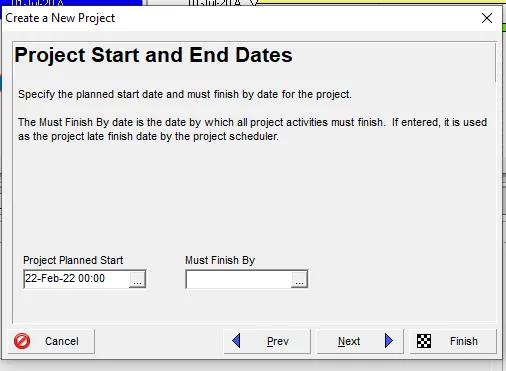

*Mention the start date as 22nd Feb 2021

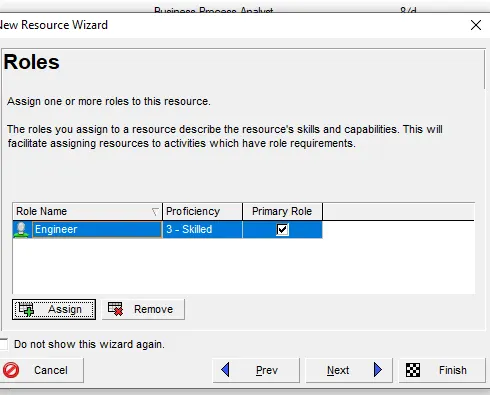

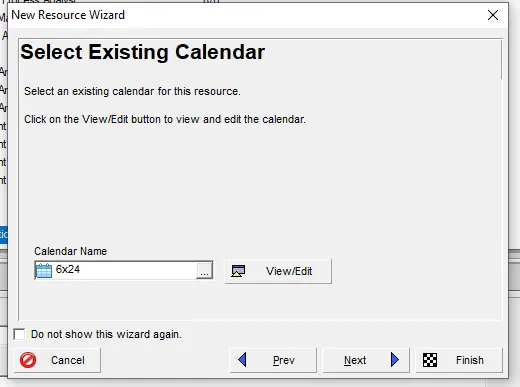

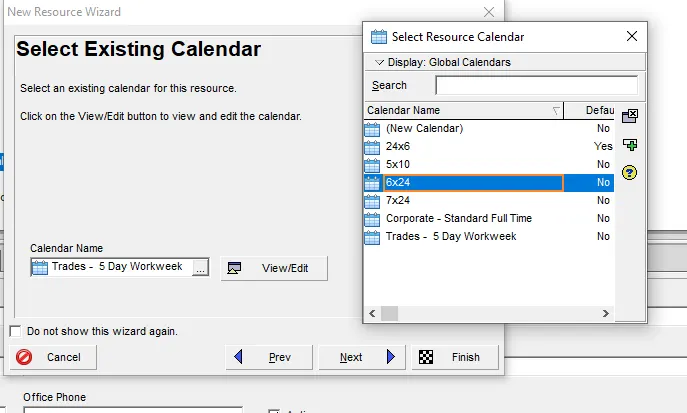

*Calendar as 6X24, and choose the responsible manager

*Go to enterprise tab >resources option
*Click +

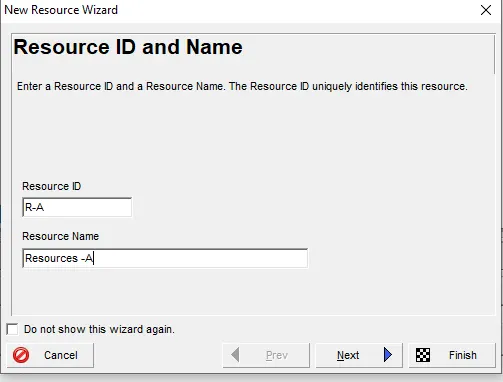

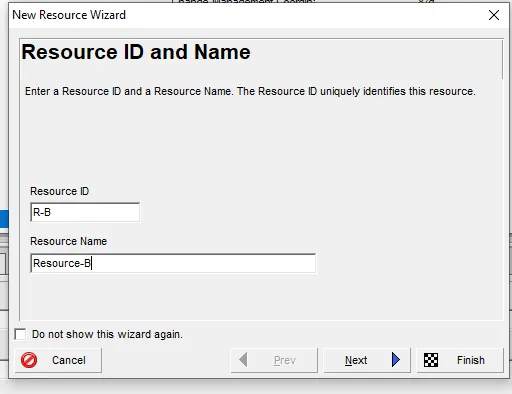

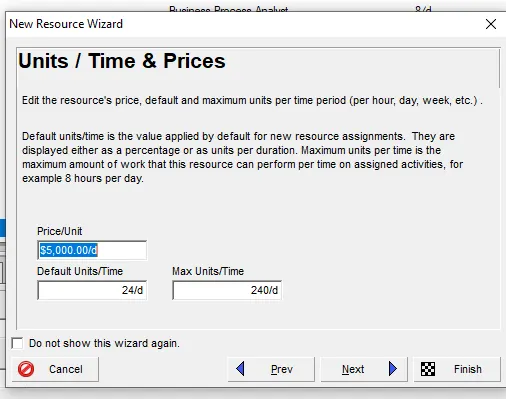

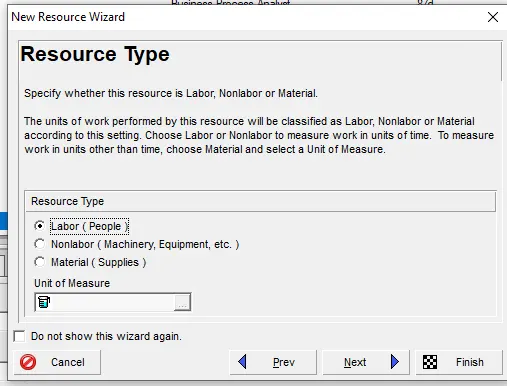

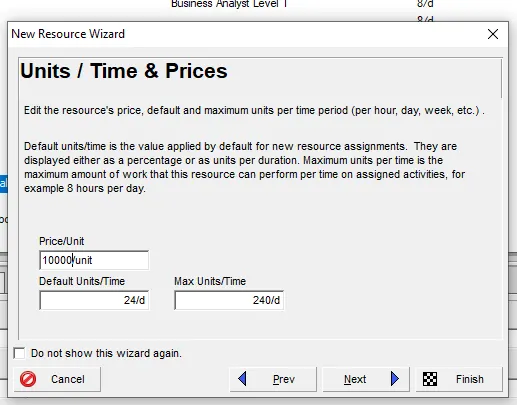

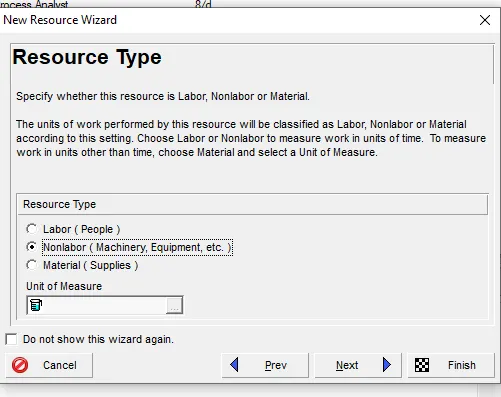

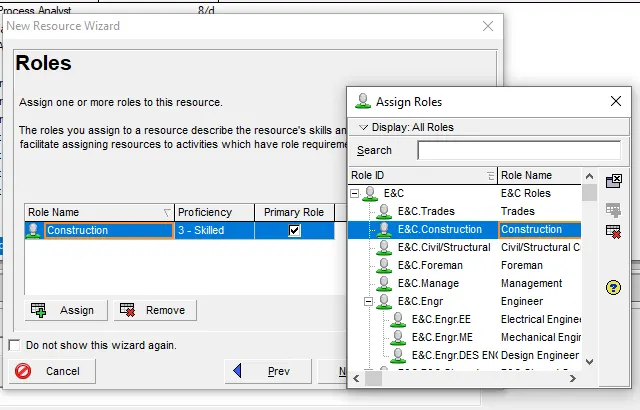

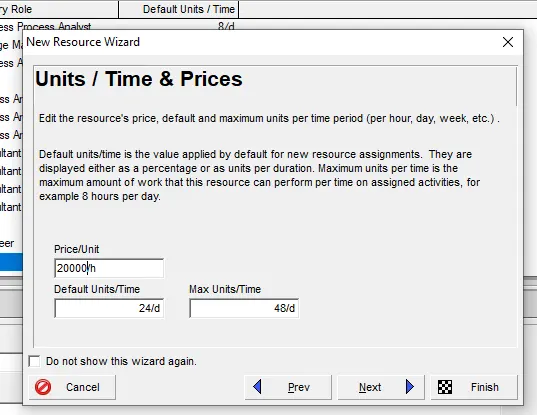

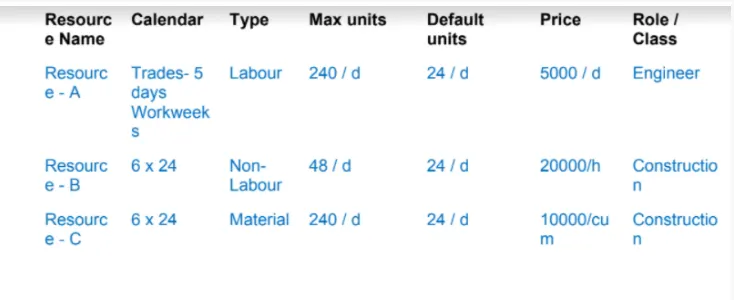

*Name the resources accordingly as given in the question

The same is done for the rest 2

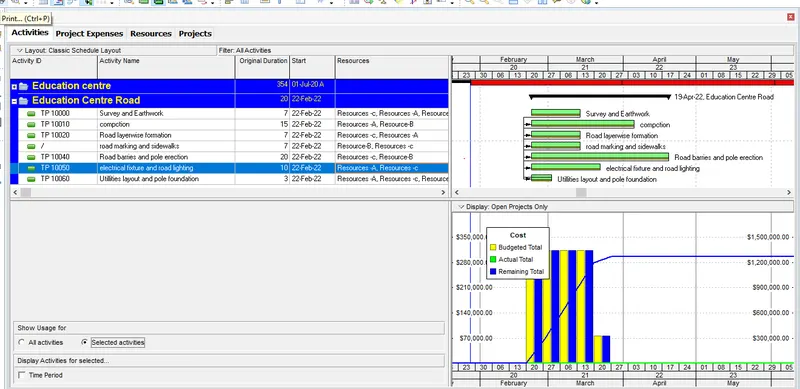

*Adding activities > go-to activities select ECR project
*Click +

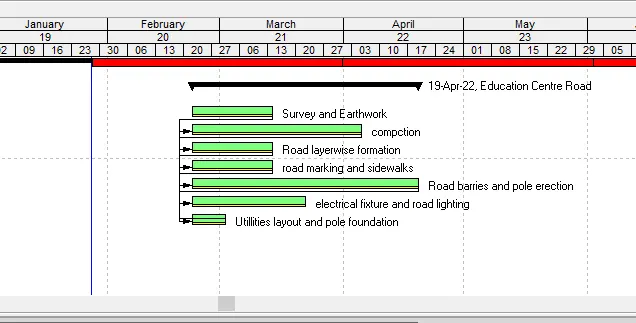

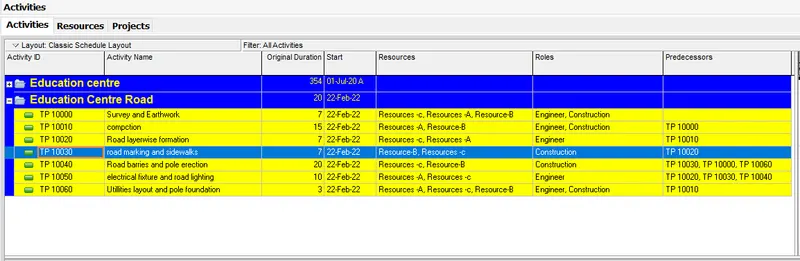

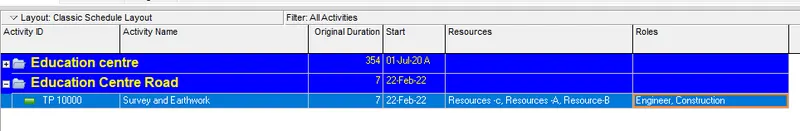

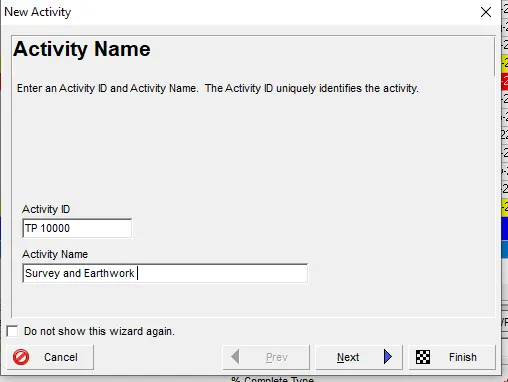

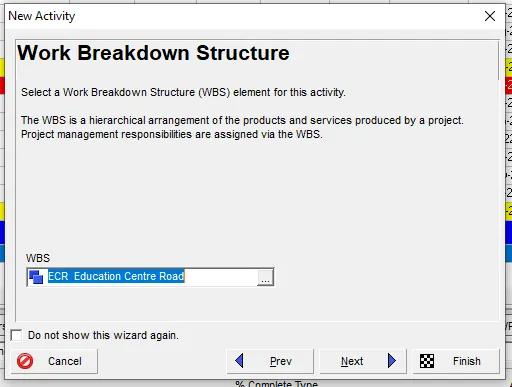

*add the activities according to the question

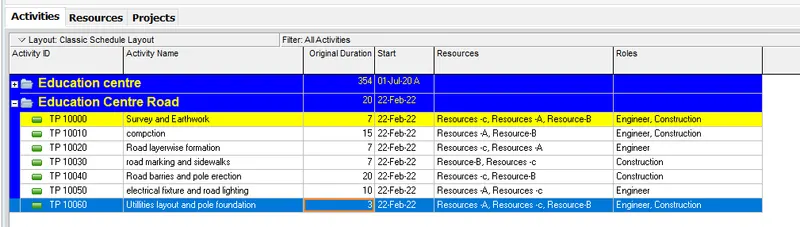

*duration is added

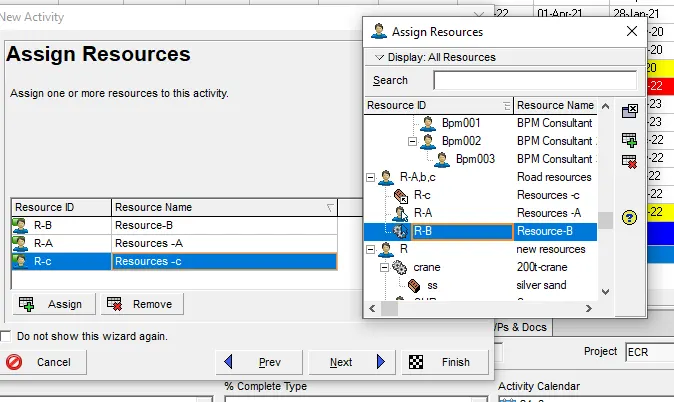

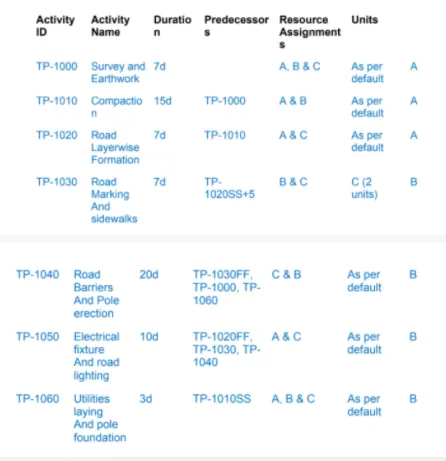

*now the predecessors are added

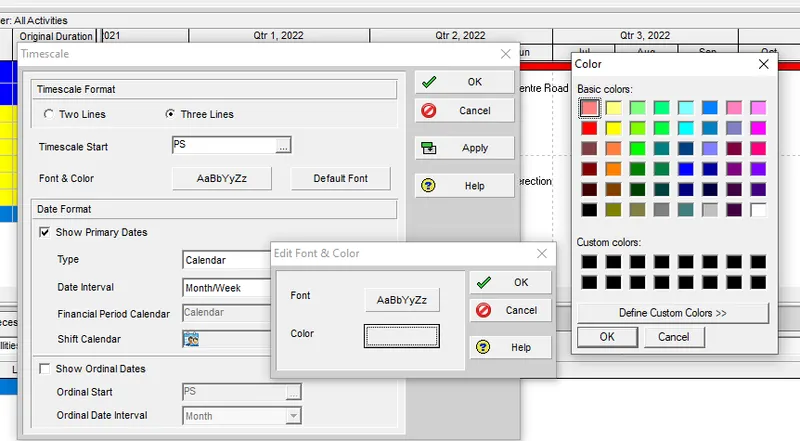

2. Use 3-Tier timescale with Year / Month / Weeks

4. Add a budget to your project - INR 6 cr.

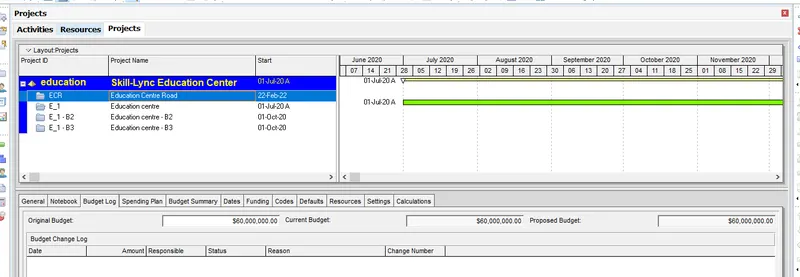

*Go to budget log and add in the details

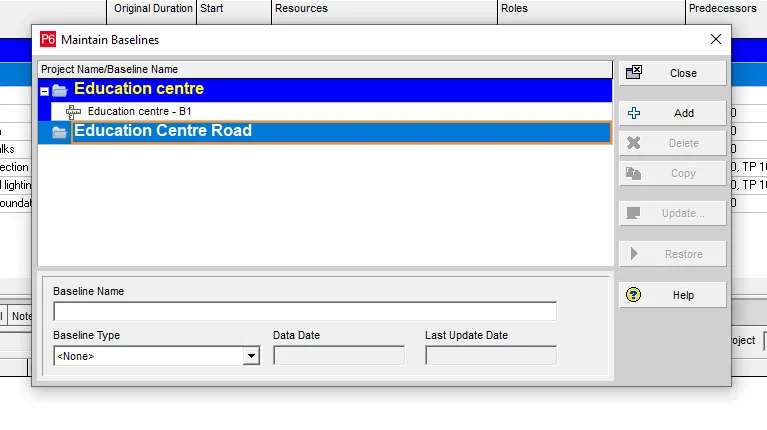

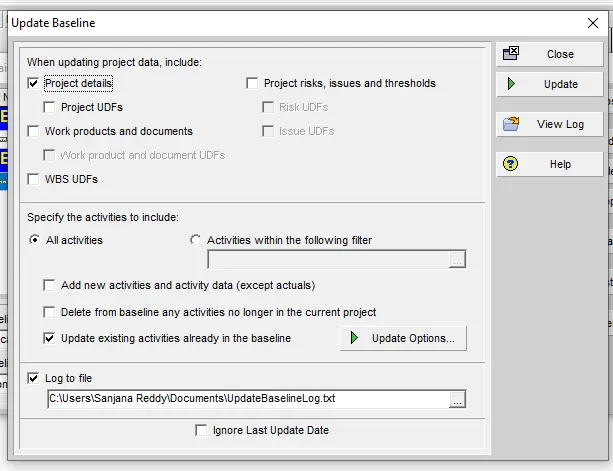

5. Assign a baseline to the project

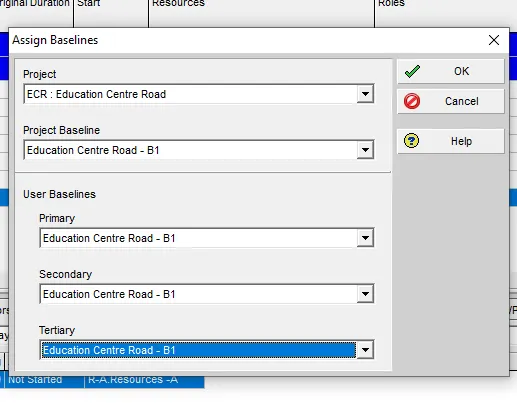

Go to project>maintain baseline
Again go to project >assign baseline

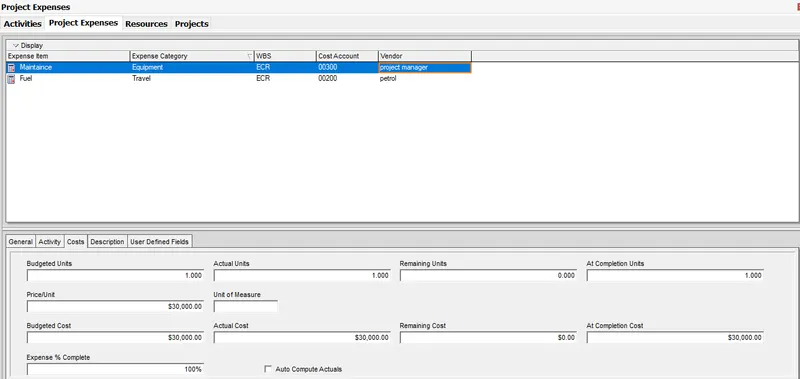

6. Add following expense:
Task - 1 - Rs 20,000/- (Item - Fuel)
Task - 2 - Rs 30,000 /- (Item - Maintenance)

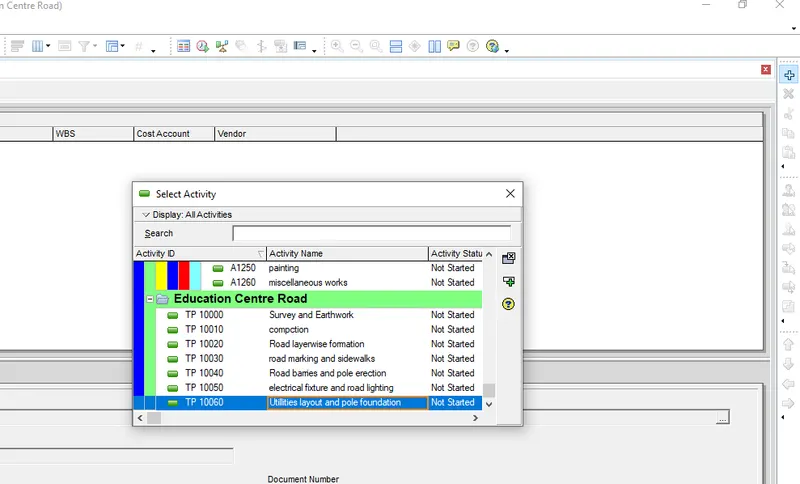

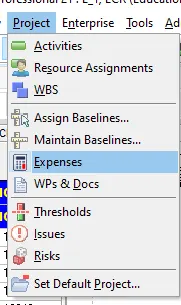

*project >enpense option
*Click +
*select the activity and add the details accordingly to the question

7. Generate material resource costs curve

8. Generate an activity-wise cost report

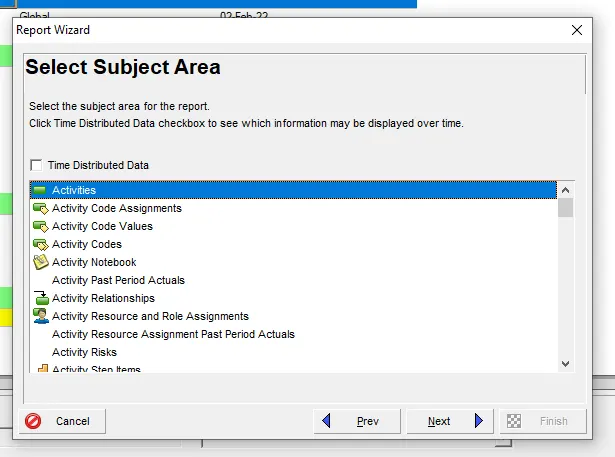

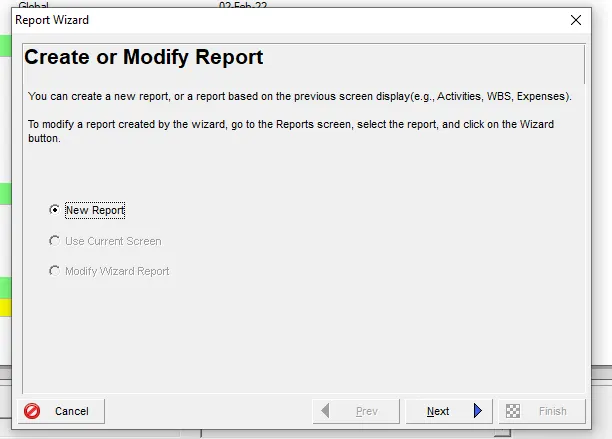

*Report >+
*New report >activities >relative subjects

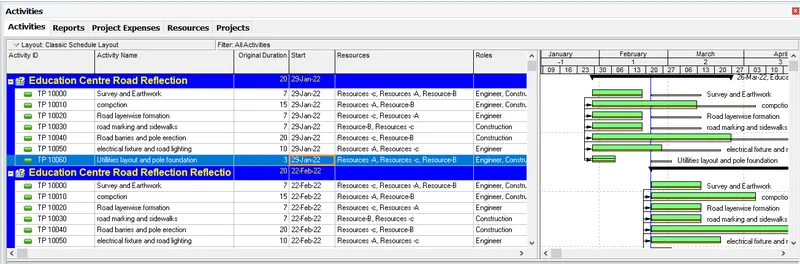

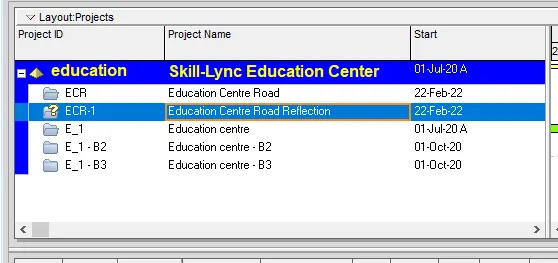

9. Create a reflection

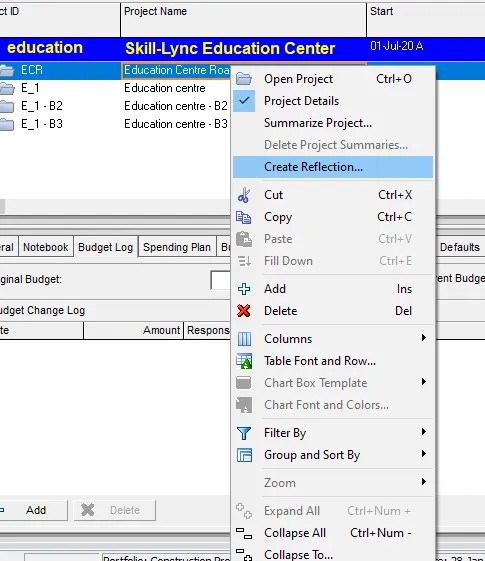

Go to project page > right -click >select reflection

10. In the reflection, auto update the project at 15 days from start
*right click the reflection project
*open project

*Change date to 15 days ahead the current project

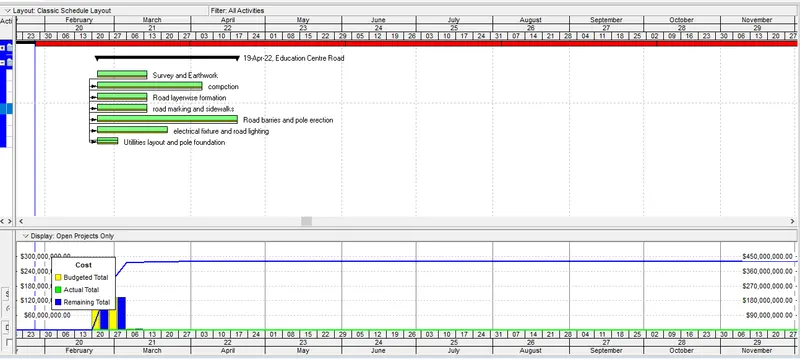

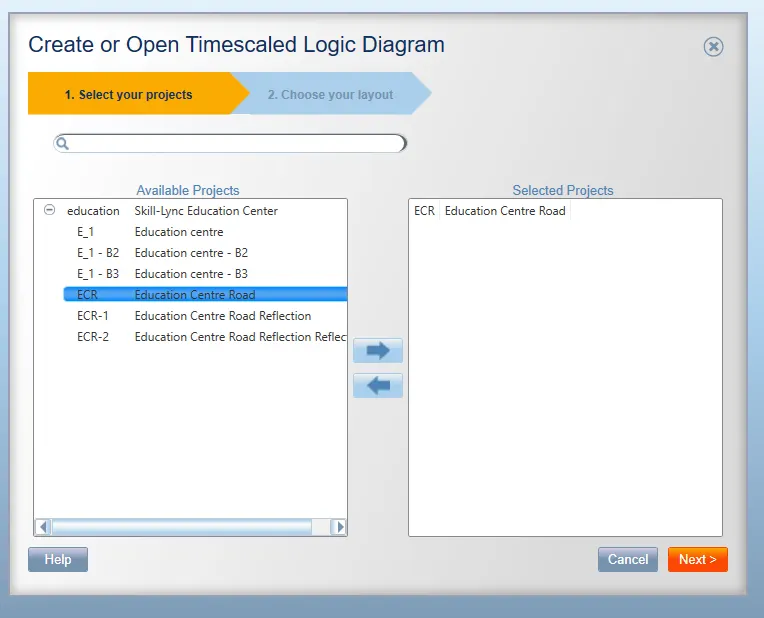

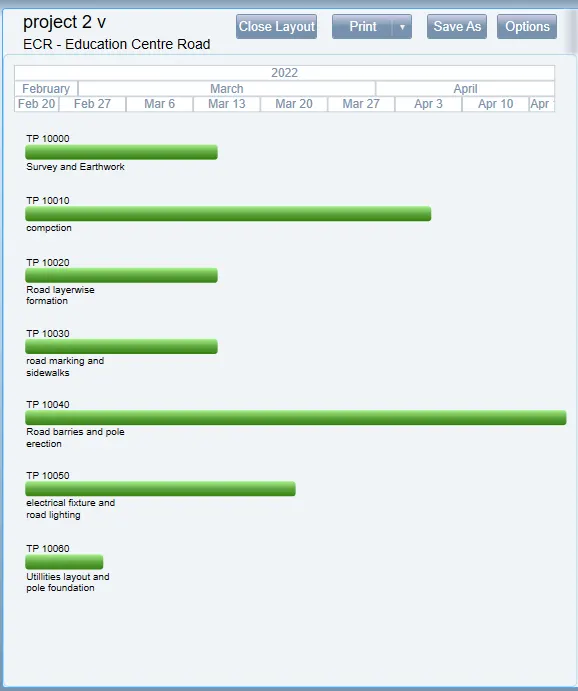

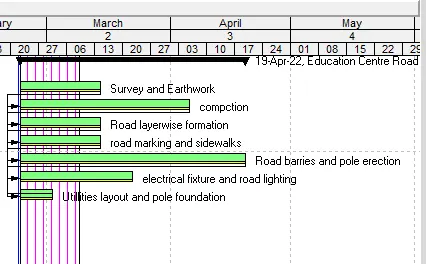

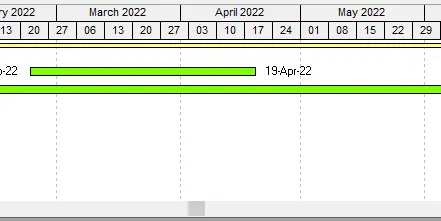

11. Open a TSLD view of the project in Visualizer
*Tools >Visualizer option

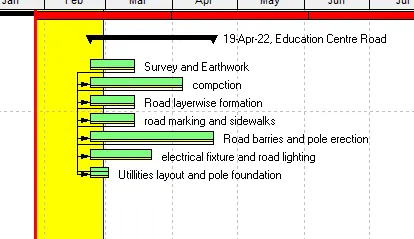

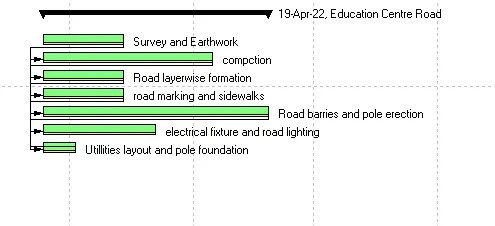

*Click + > TSLD > ECR project >okay

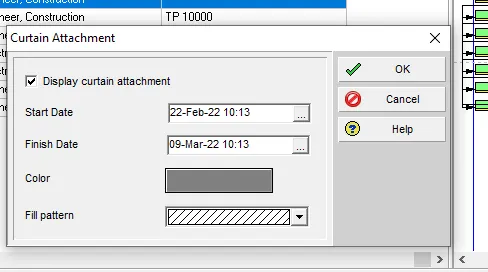

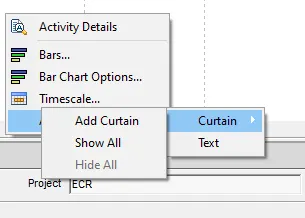

12. Add curtains up-to first 15 days of the project.
*Right -click on the left side project page >attachments >curtains

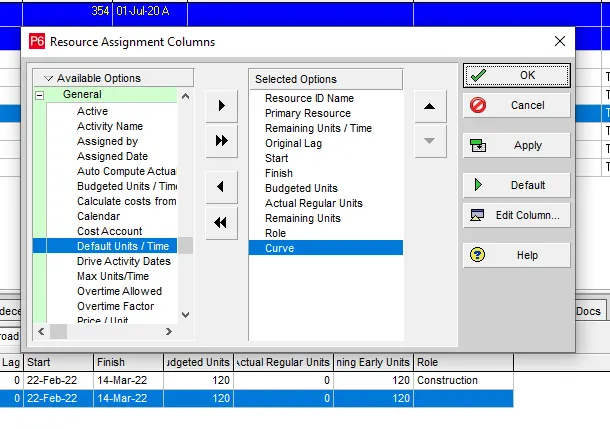

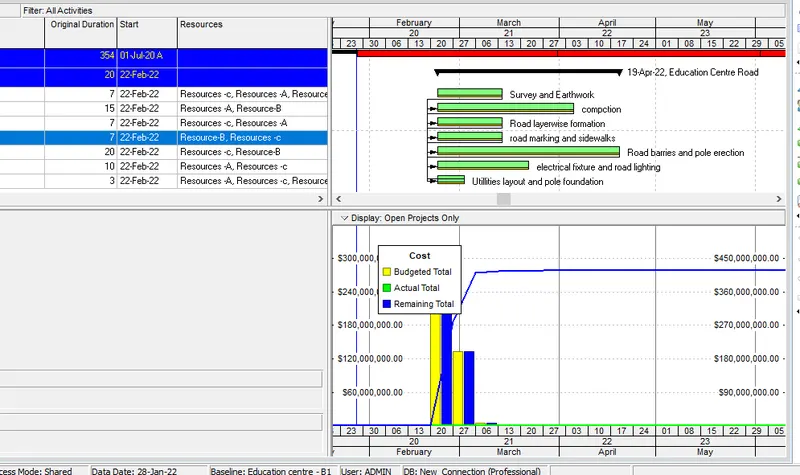

3. Find out the actual cost for labour, non-labour and material cost of the updated schedule

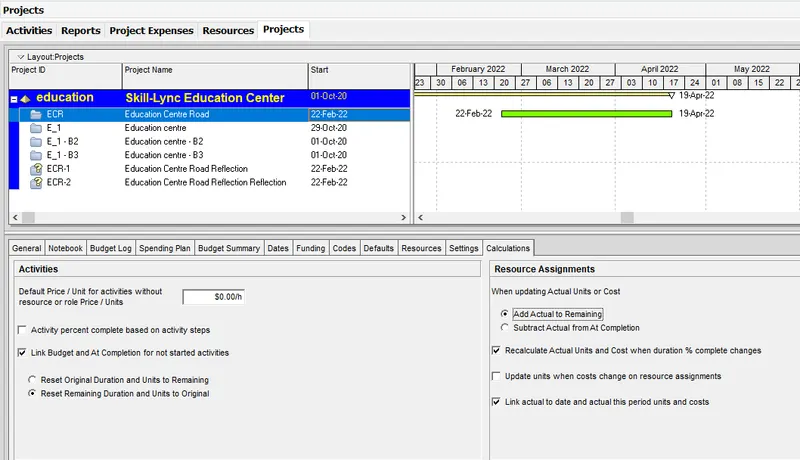

*Go to project page > calculation tab
*select actual to Remaining
*Select resources to find the value
