Challenge

Project 2

Aim : A 100 m WBM road needs to be constructed inside the Skill Lync Education center premises to allow access to the centre for students and faculties.
Create the following Project (under same EPS/OBS as project-1) and Resource :
Project Name - Education Centre Road
Assume - Calendar as 6 x 24 and start date on 22nd feb 2021

Procedure

(a) create project -

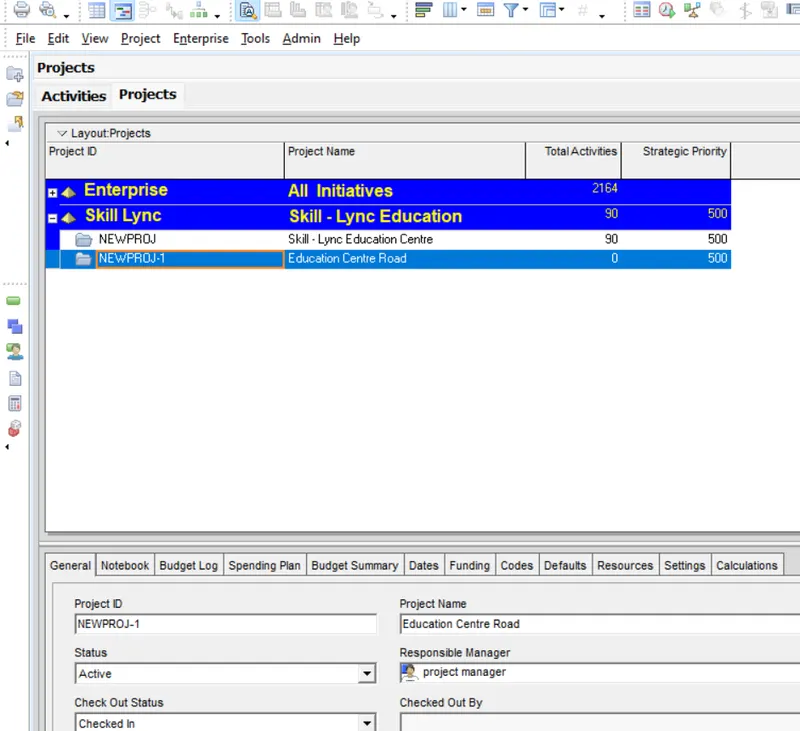

EPS - skill lync education

OBS - project manager

go to enterprise > project > select skill lync education >add ( as EPS and OBS is already created)

(b) calender

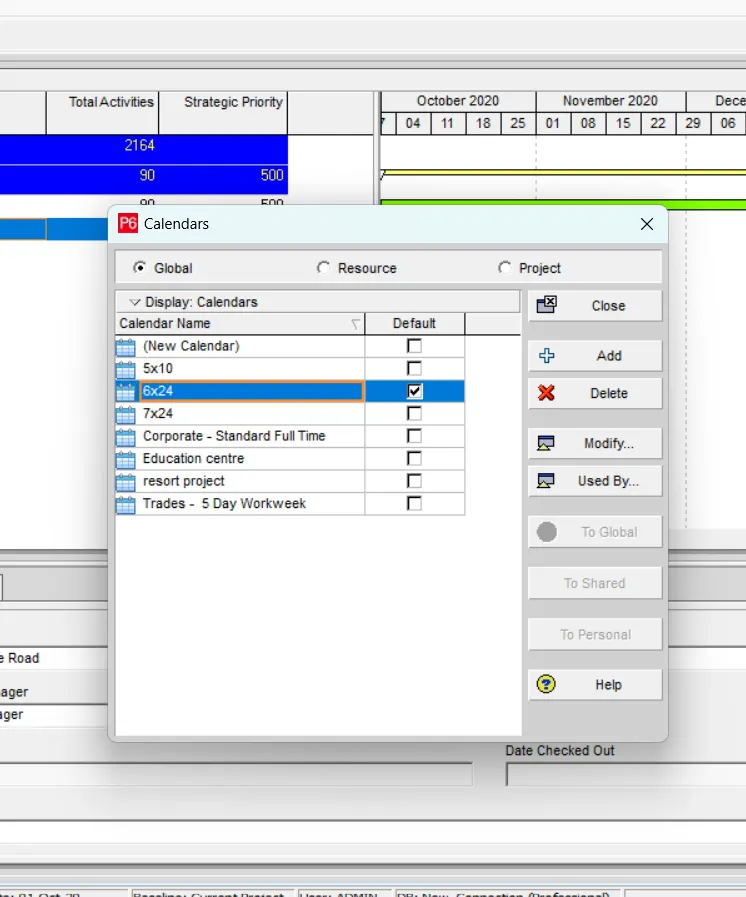

go to enterprise >select calendar

(c) add activities with durations

(d) use a 3-tier time scale year/month/days

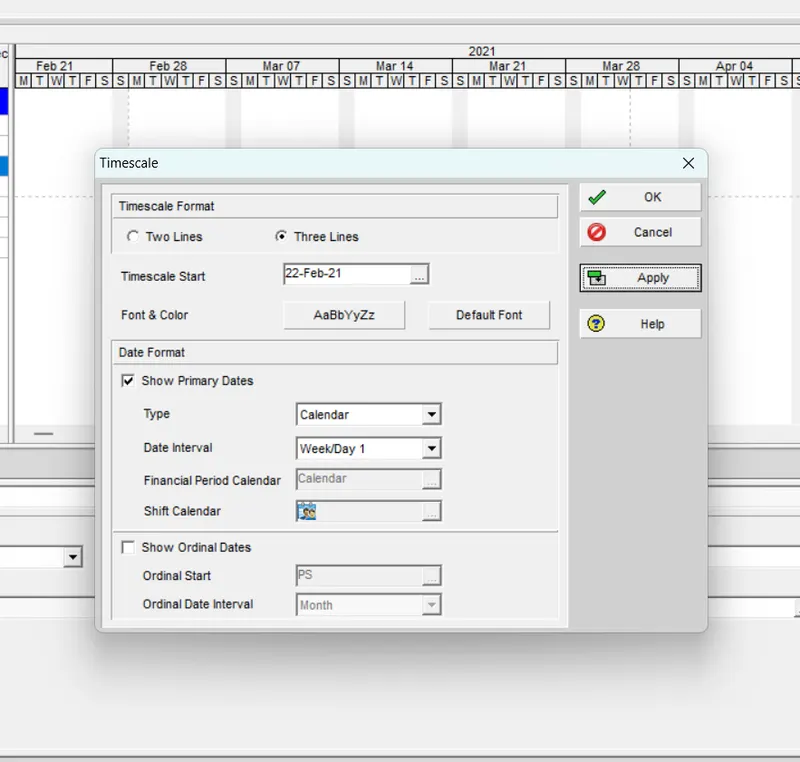

go to gantt chart >( right click ) select timescale > 3 lines > apply

(e) add resources as mentioned

go to enterprise > resource > add new resource ( with unit/roles/price)

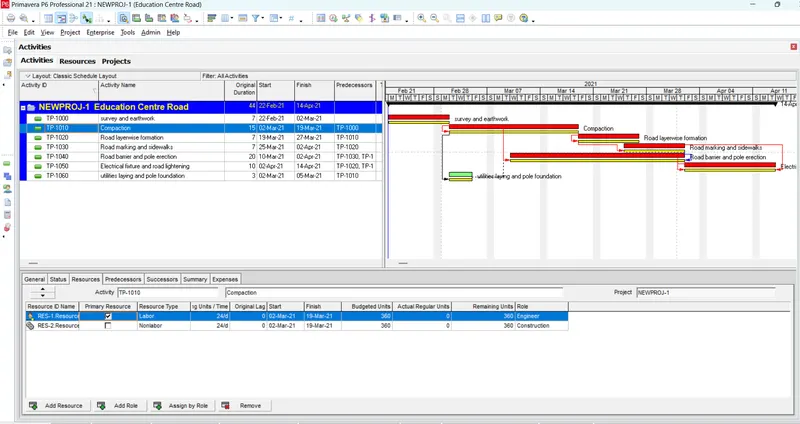

(f) assign the created resource to the activity

select activity > go to resource in detail window > assign resources

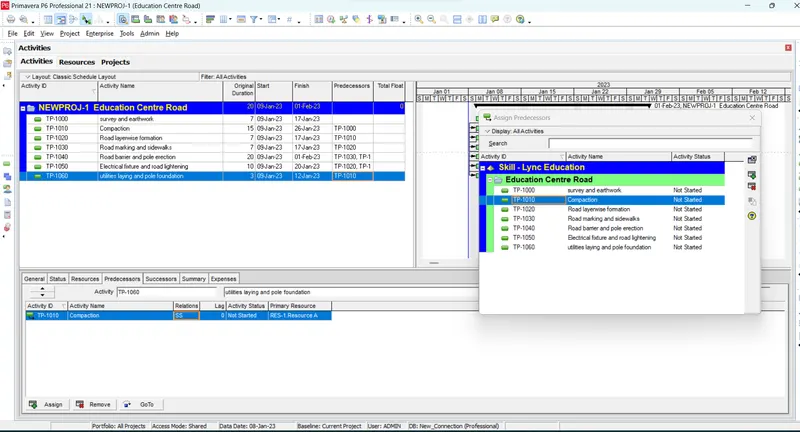

(g) give the predecessors

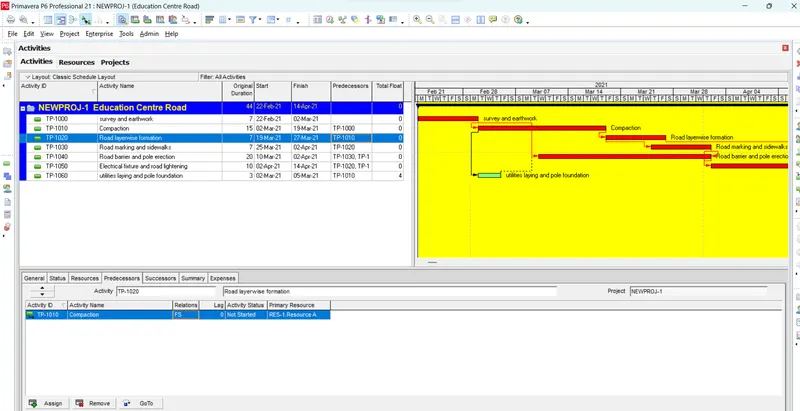

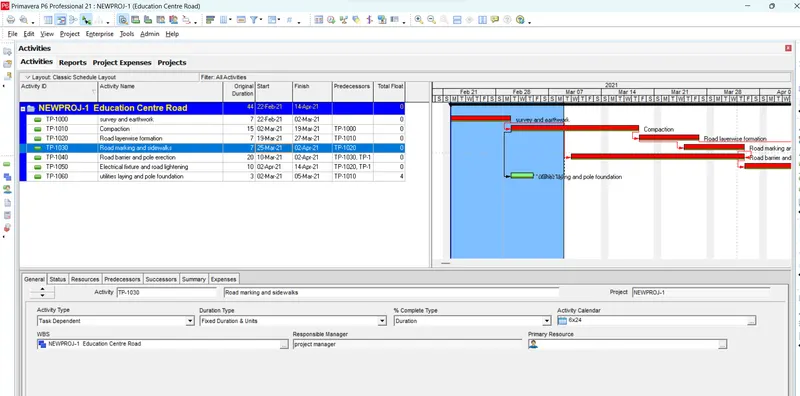

select activity > add predecessors

after giving the predecessors then schedule it

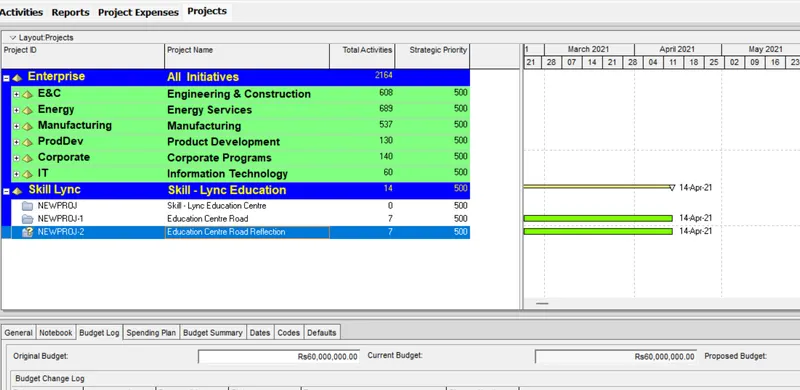

(h) add a budget - INR 6 Cr

  • select project
  • go to budget log

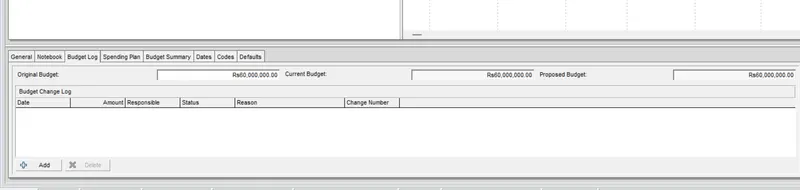

  • add the original budget - 6cr

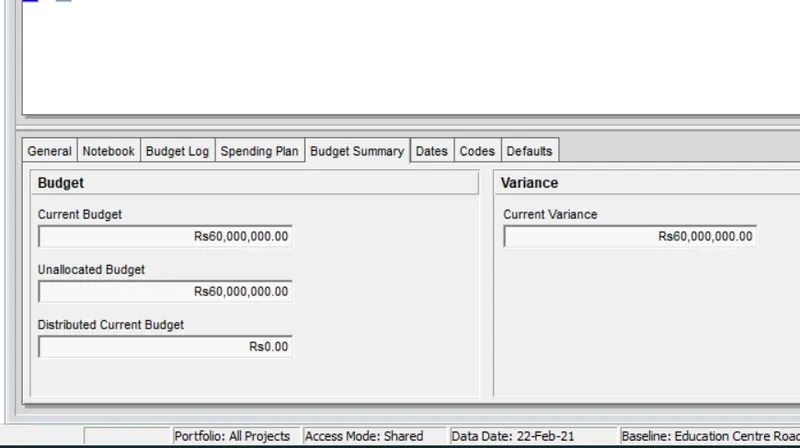

  • then go to budget summary and check

(i) assign a baseline

go to project > maintain baseline > add new > give type

go to project > assign baseline > select baseline/primary baseline/secondary baseline > apply

(j) expenses

fuel - 20000/-

maintenance - 30000/-

  • go to project
  • expences
  • add the expences fuel and maintenance with details
  • go to activity details
  • assign the expences

(k) generate material resource cost curve

  • go to activity details
  • select resource
  • add curve in resource column ( right click in resource bar and customize)
  • then define the type of curve

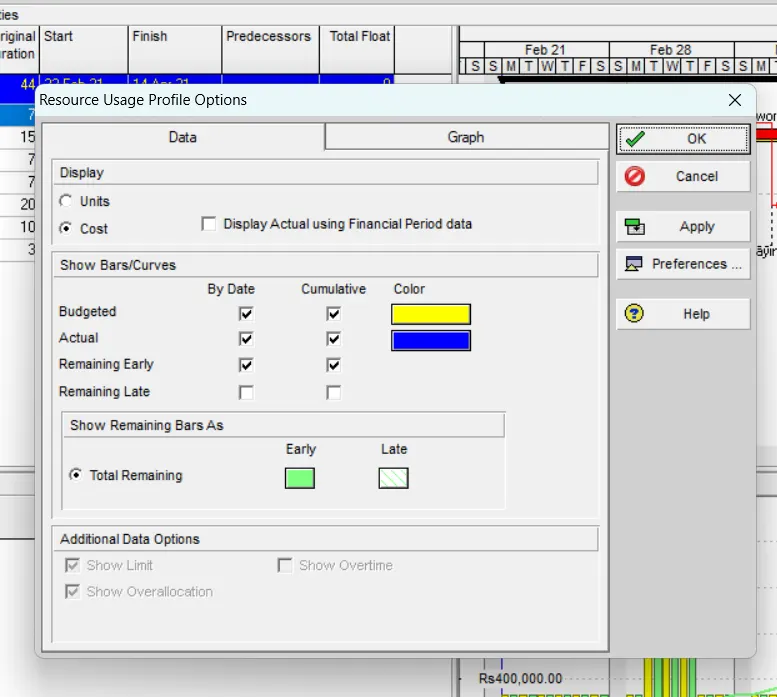

  • select resource usage profile from tool bar
  • after the curve shown right click and select resource usage profile and select cost
  • then the resource cost curve will shown

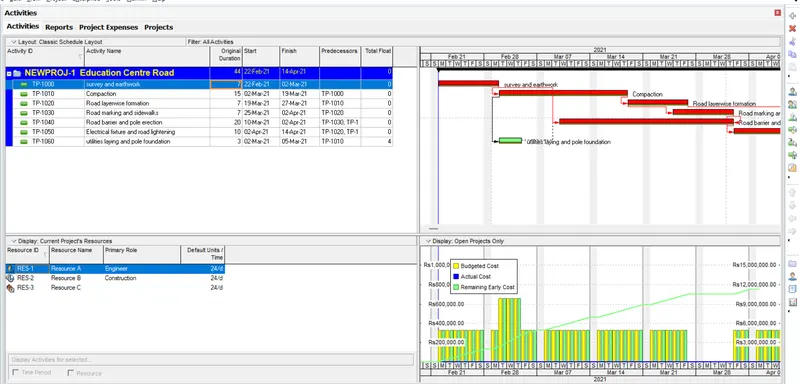

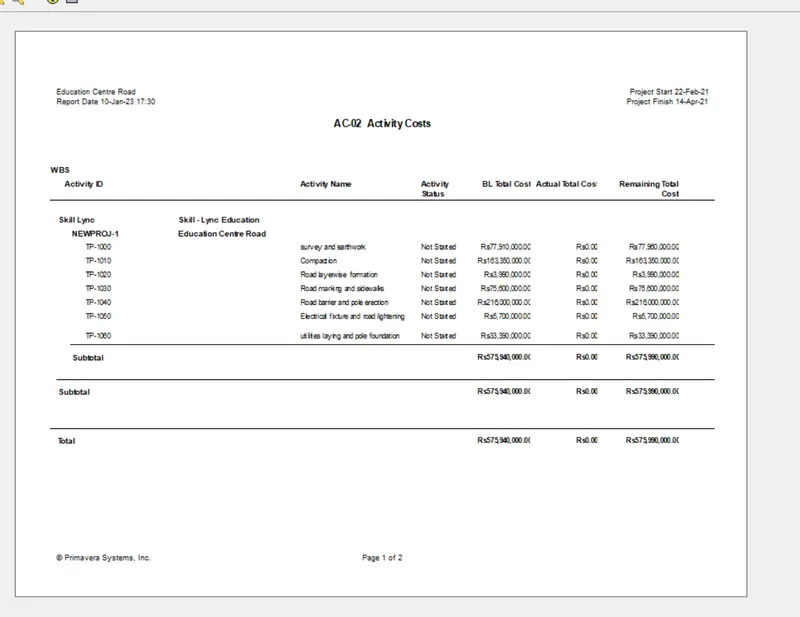

(l) generate activity wise cost report

  • go to tools
  • select report
  • reports
  • select activity cost report
  • run reports

(m) create reflection

go to project > select project > (right click) create reflection > copy baseline

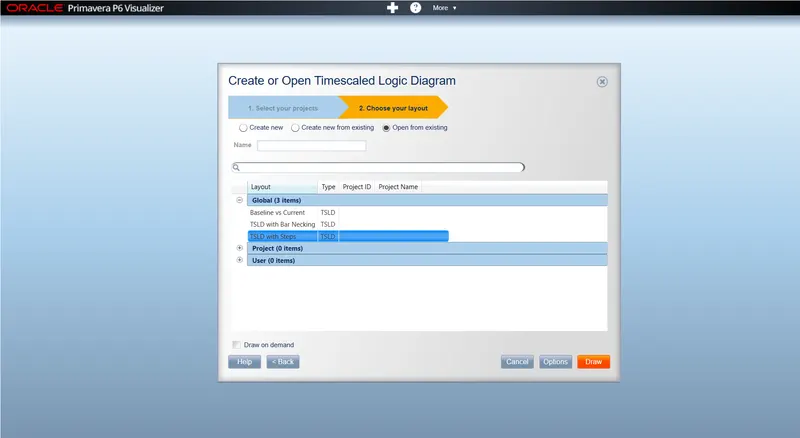

(n) open TSLD view in visualizer

go to tool > select visualizer > select TSLD > select project > TSLD with activity

(o) add curtain up to first 15 days of the project

go to view > attachment > curtain > add curtain > select date

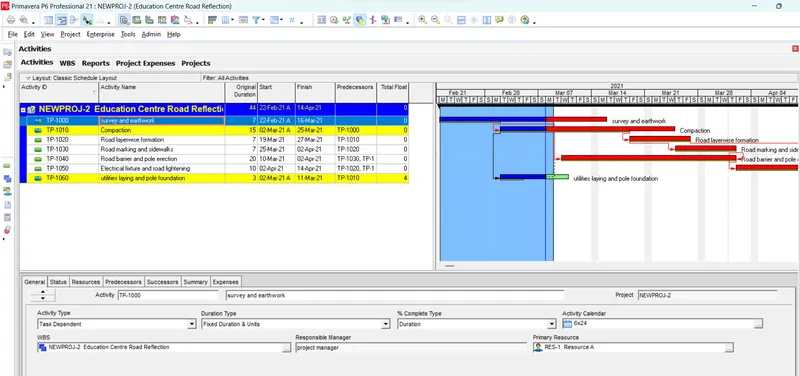

In reflection auto update the project at 15days from start

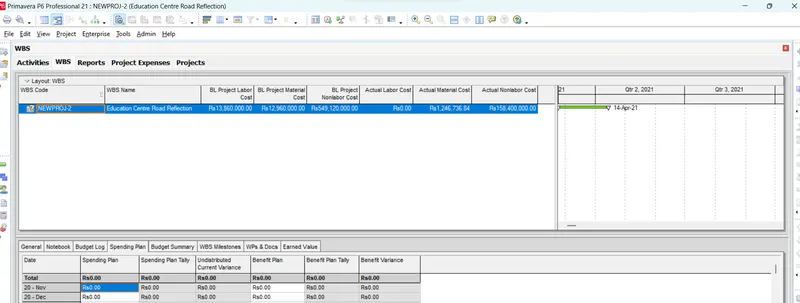

open the reflection project > tools > update progress > (change the date)

the actual cost for labour,non labour and material cost of the updated schedule
