Challenge

Project 2

First Ready For EPS, OBS, Calender Sheets.

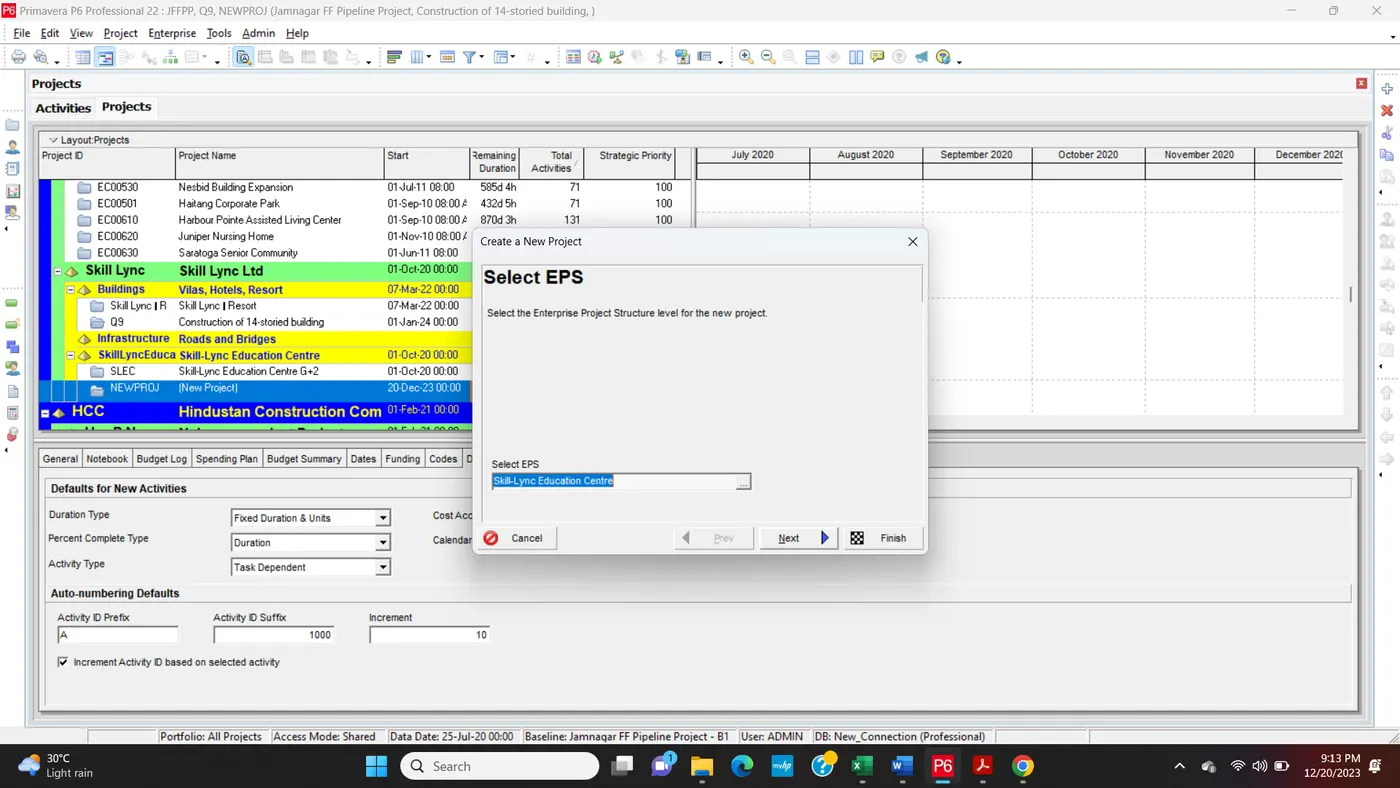

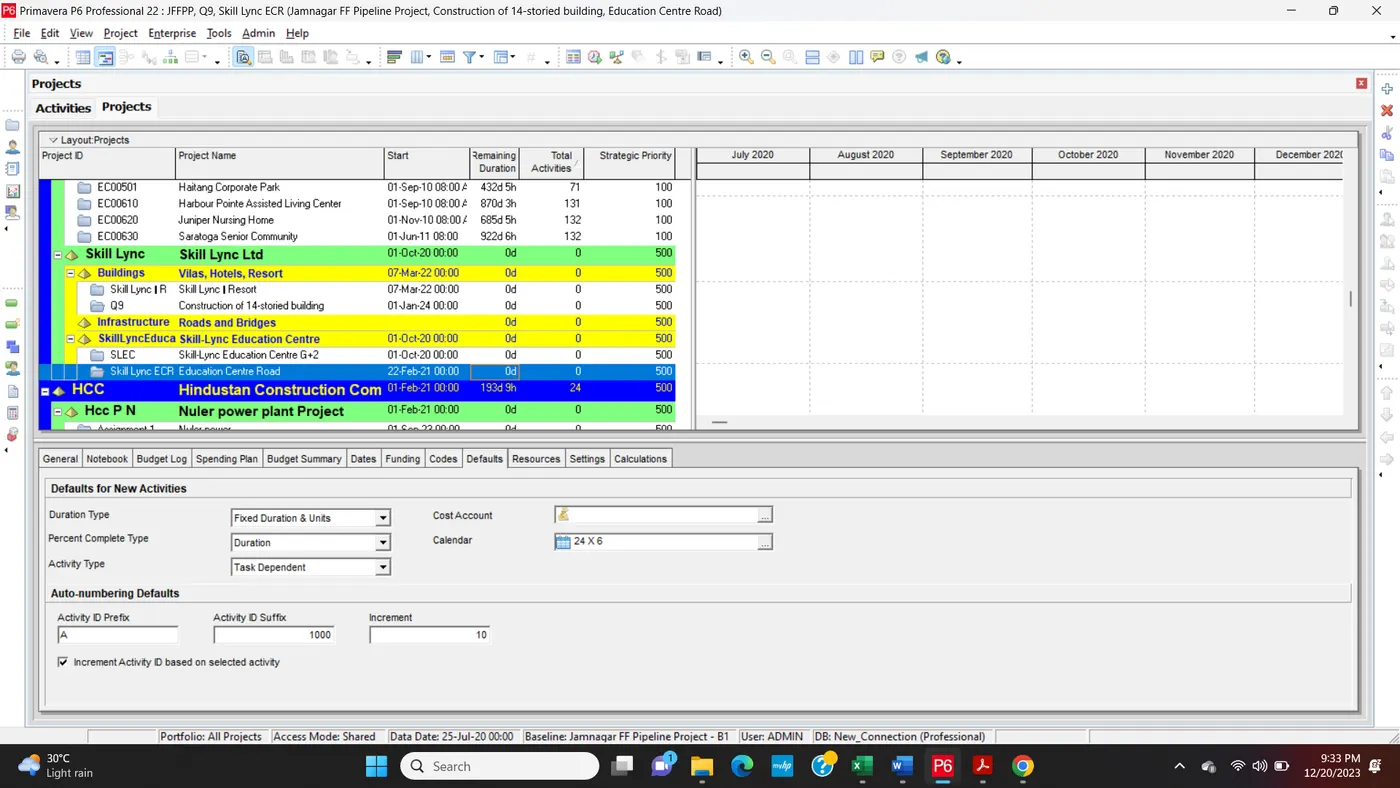

Step1: Select EPS

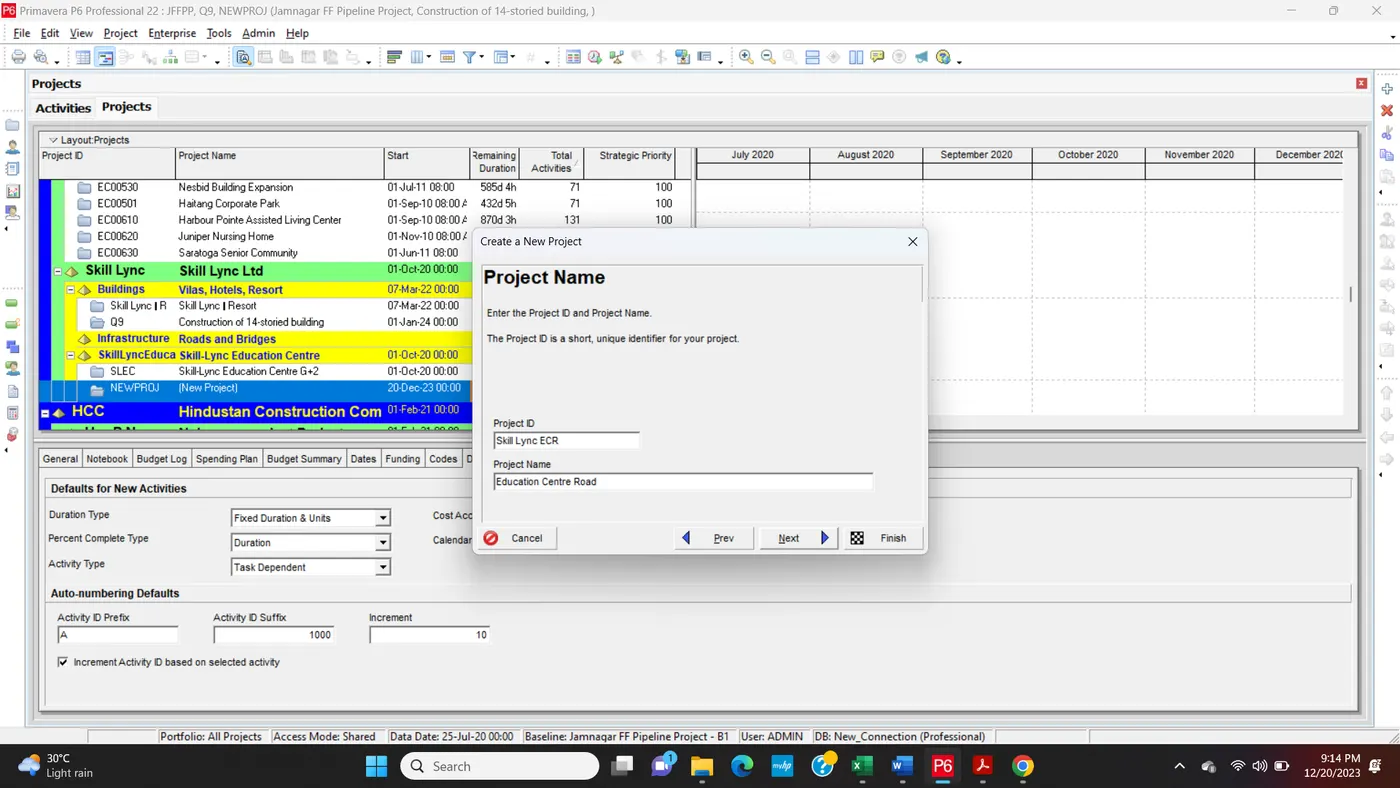

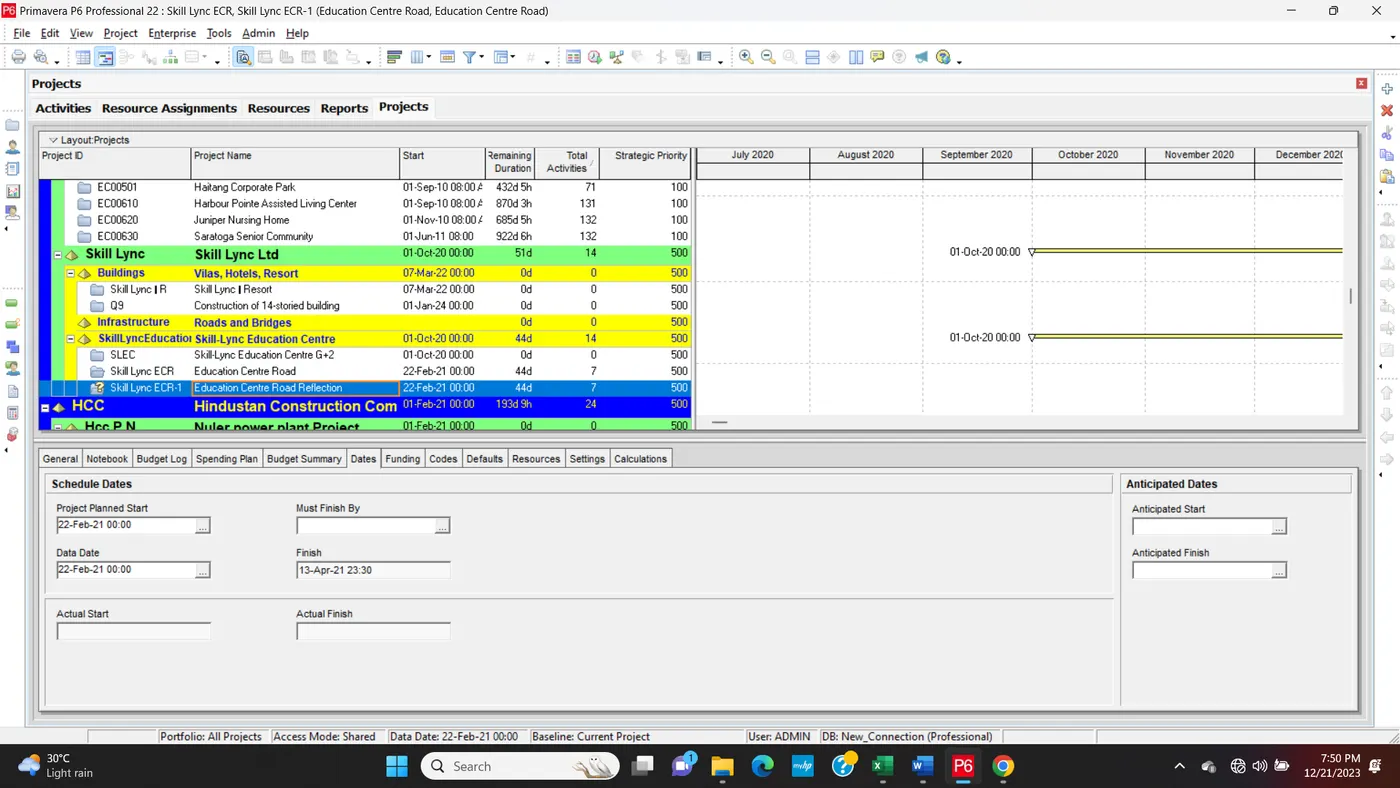

Step2: Create a Project Name and Project ID

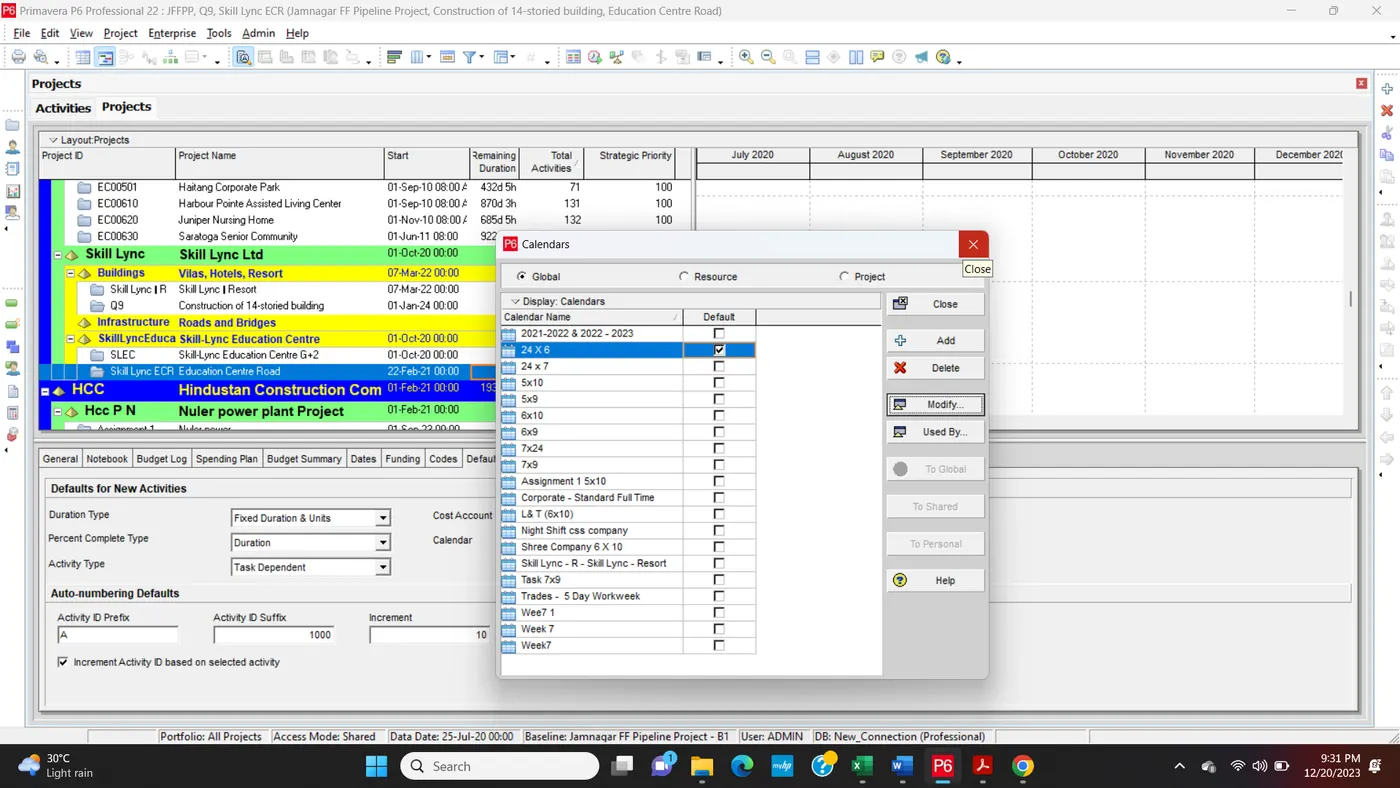

Step3: Create a Calendar 24x6

Step4:

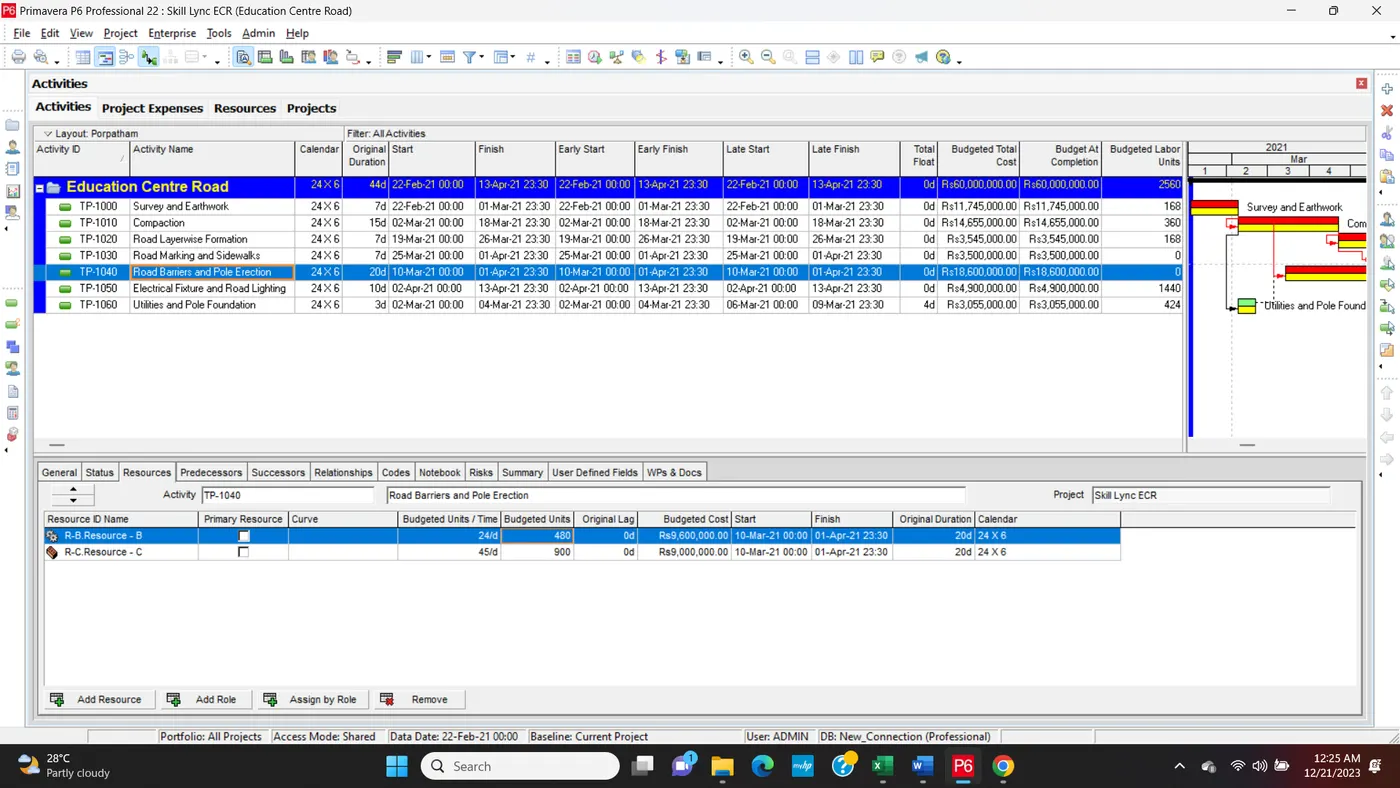

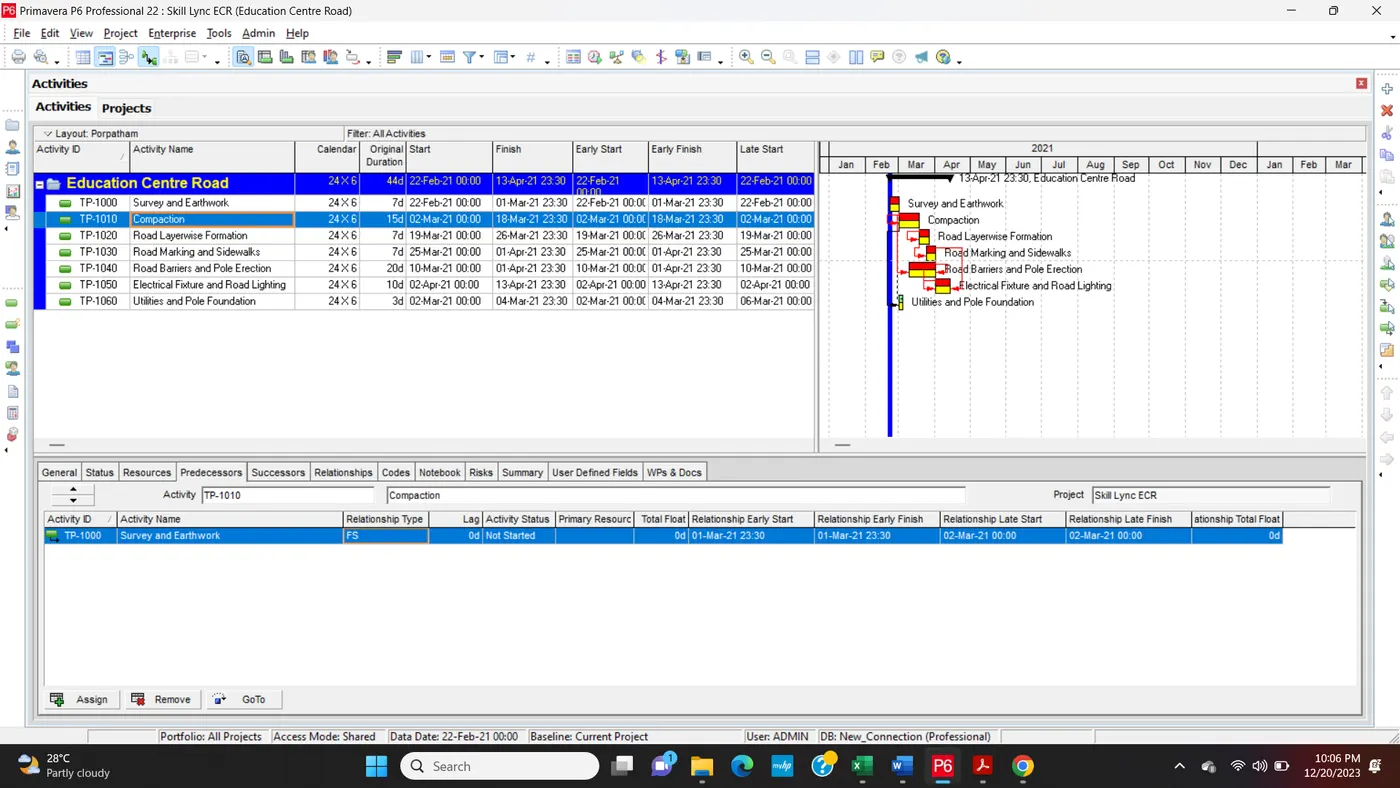

Q1. Develop the project schedule as per the criteria above

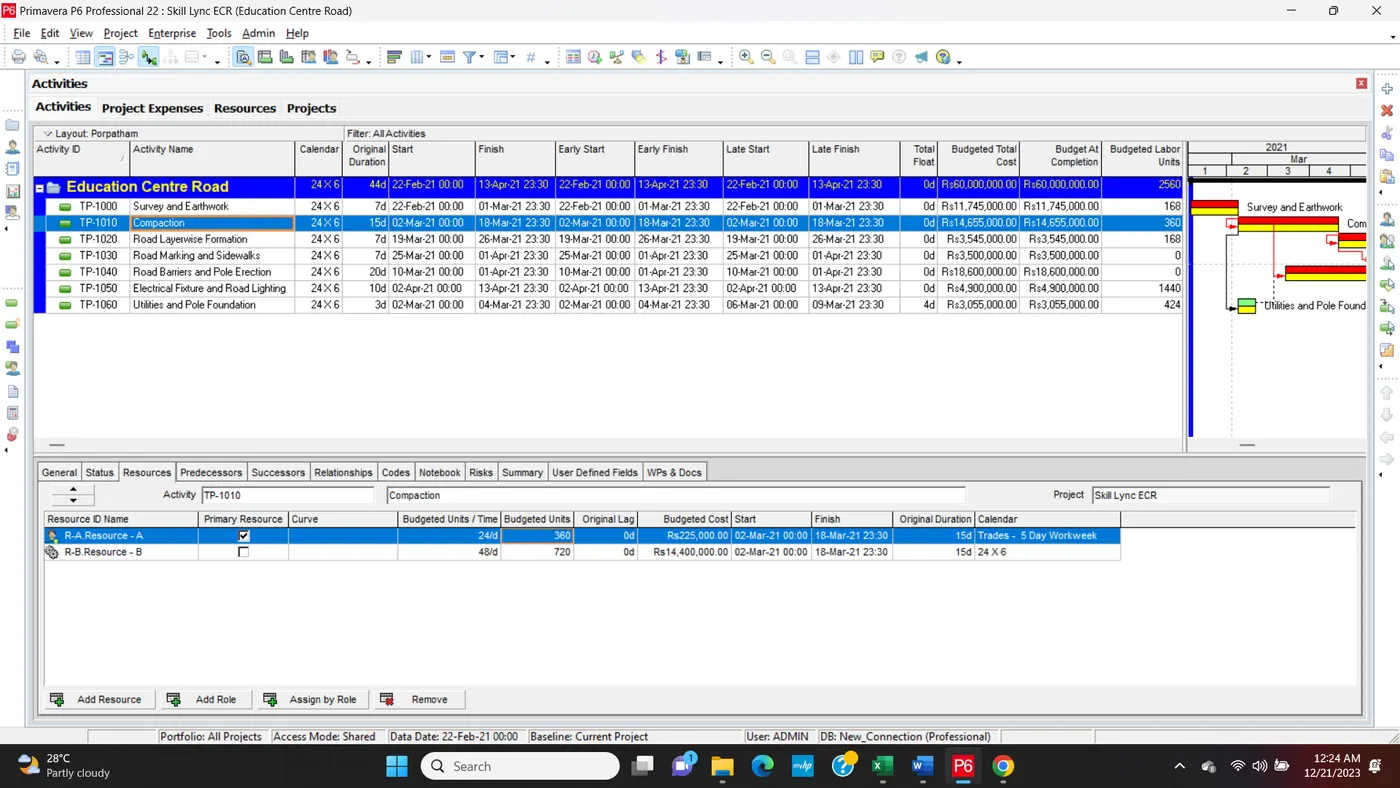

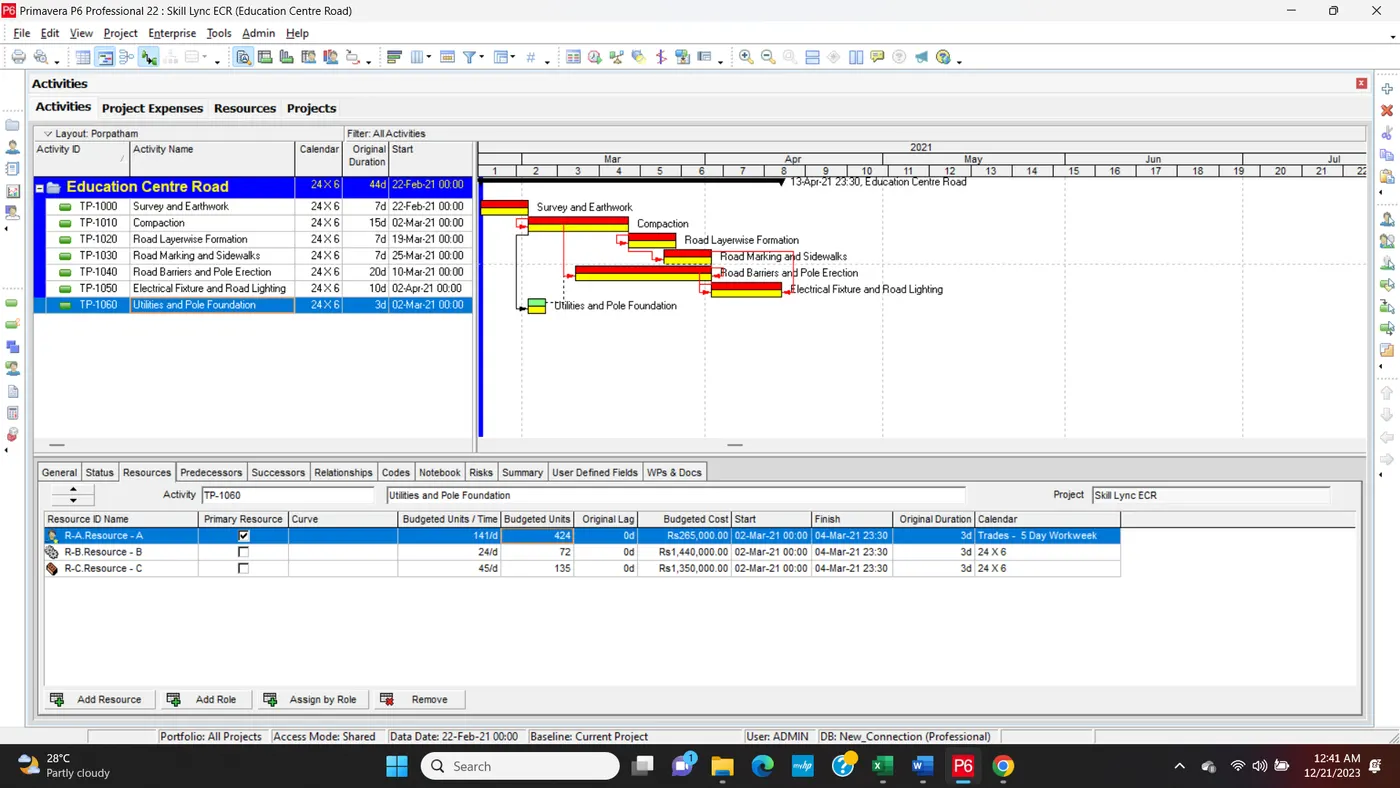

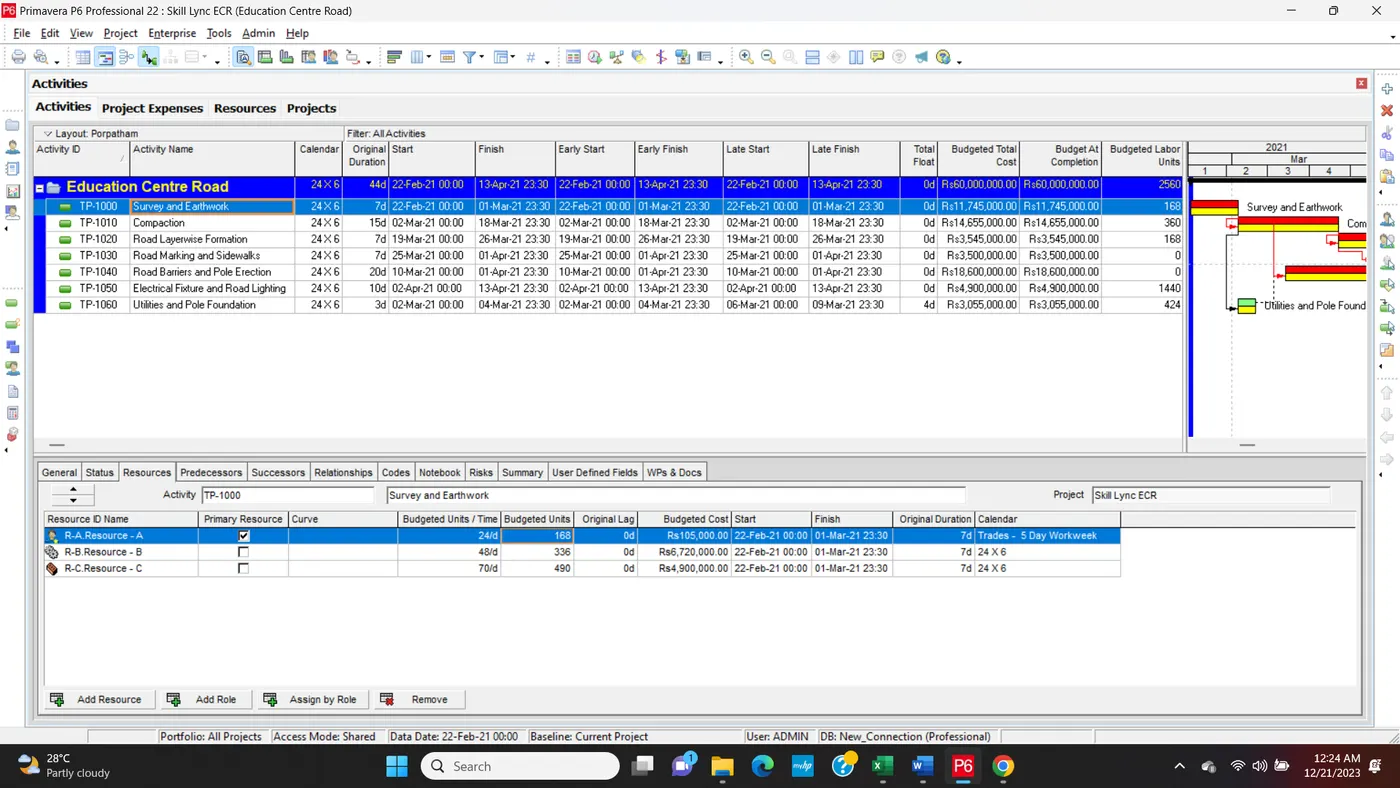

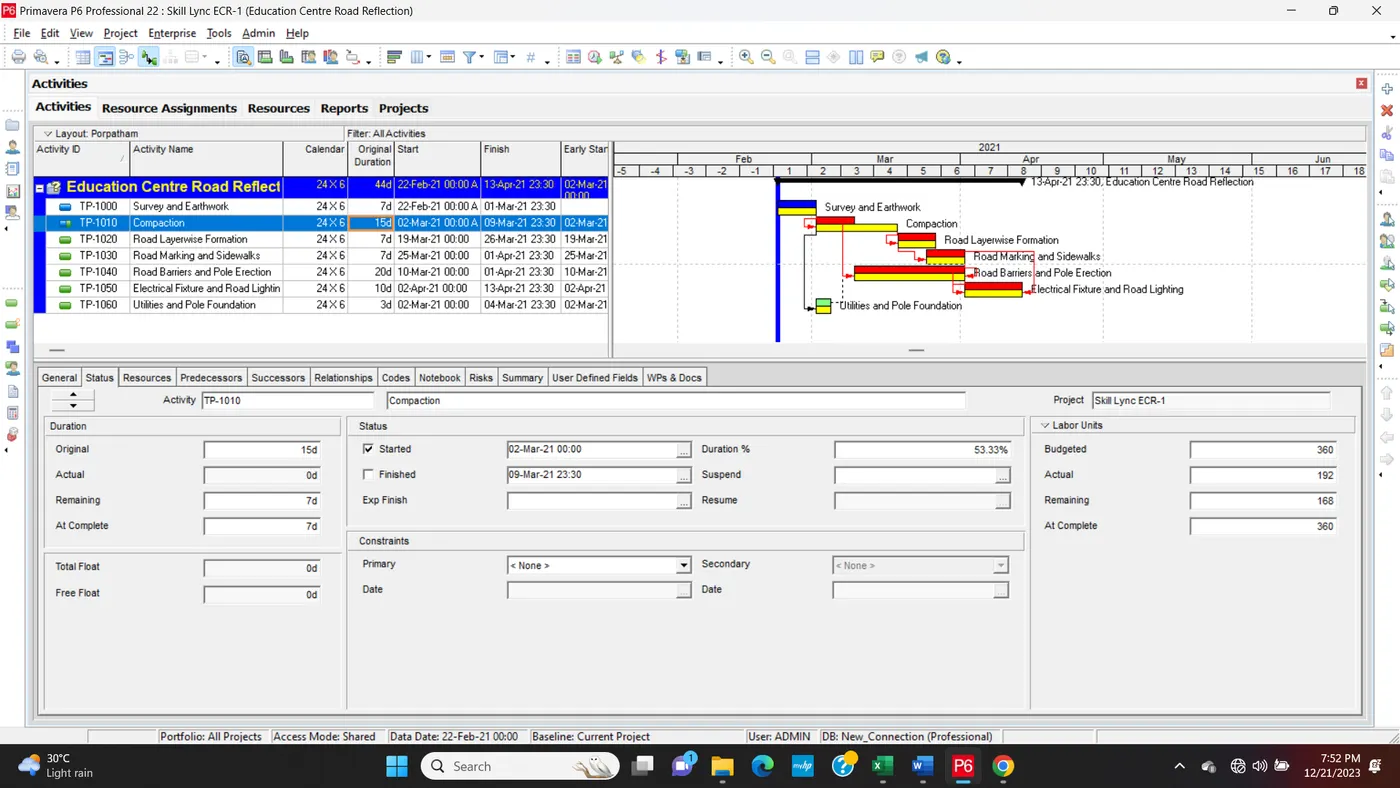

Step: Add a Activity name and Activity ID

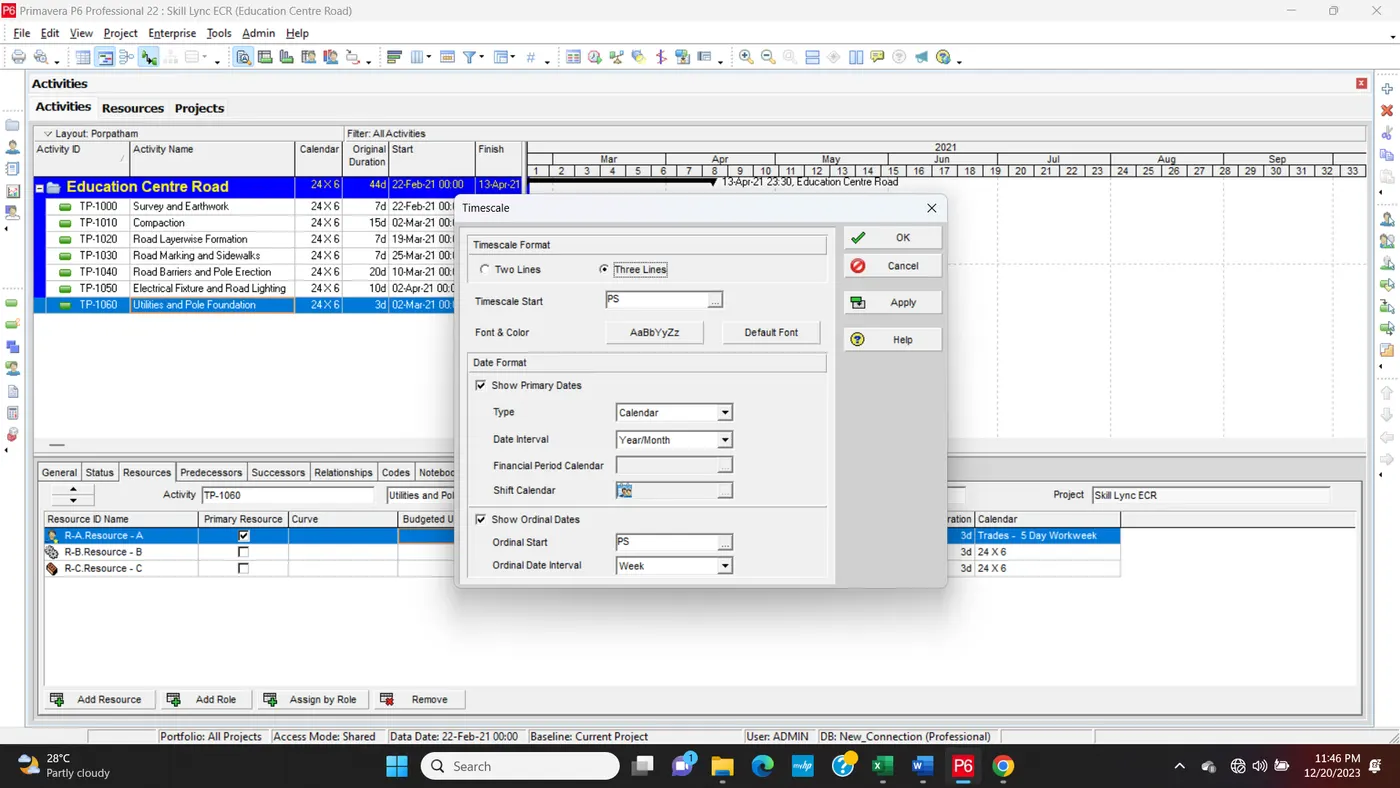

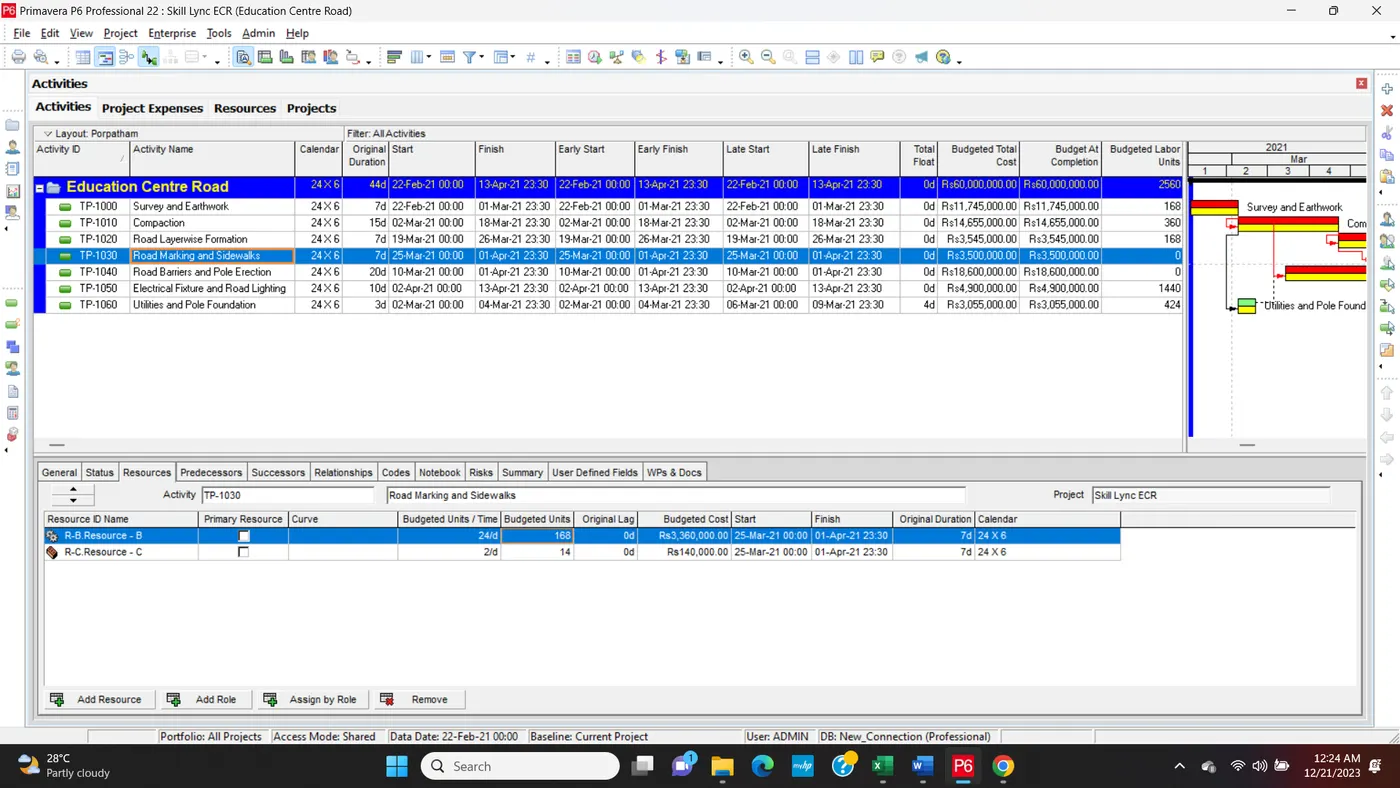

Q2. Use 3-Tier timescale with Year / Month / Weeks

Step1:

Step2:

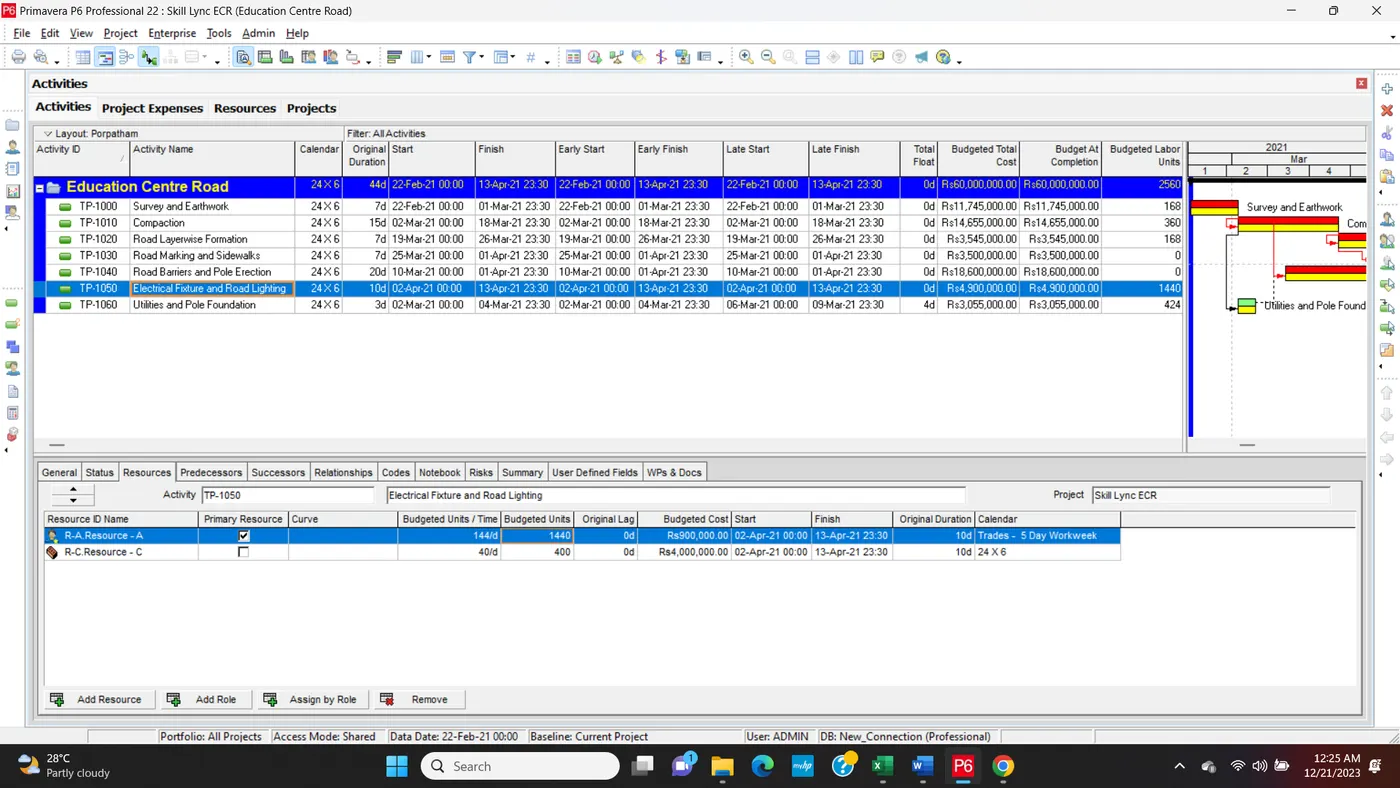

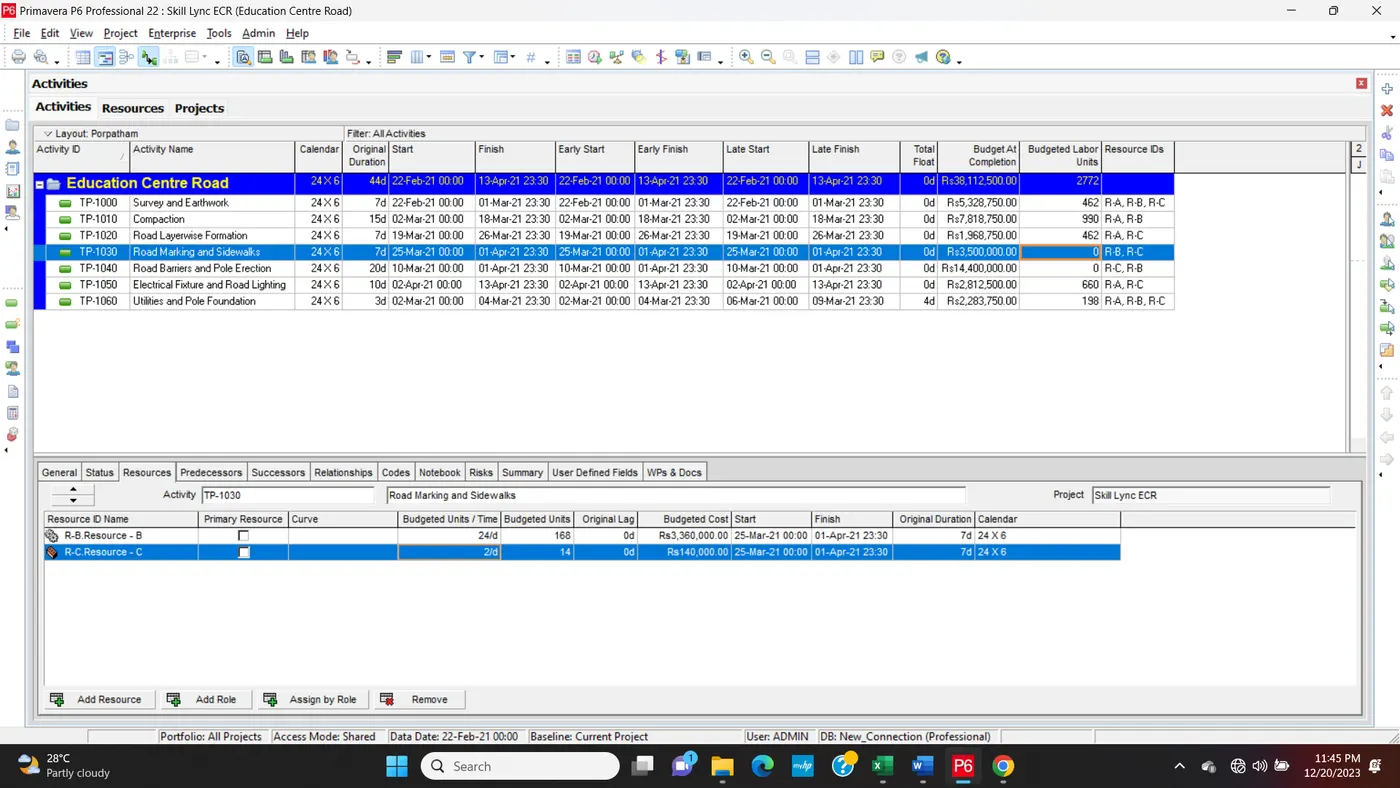

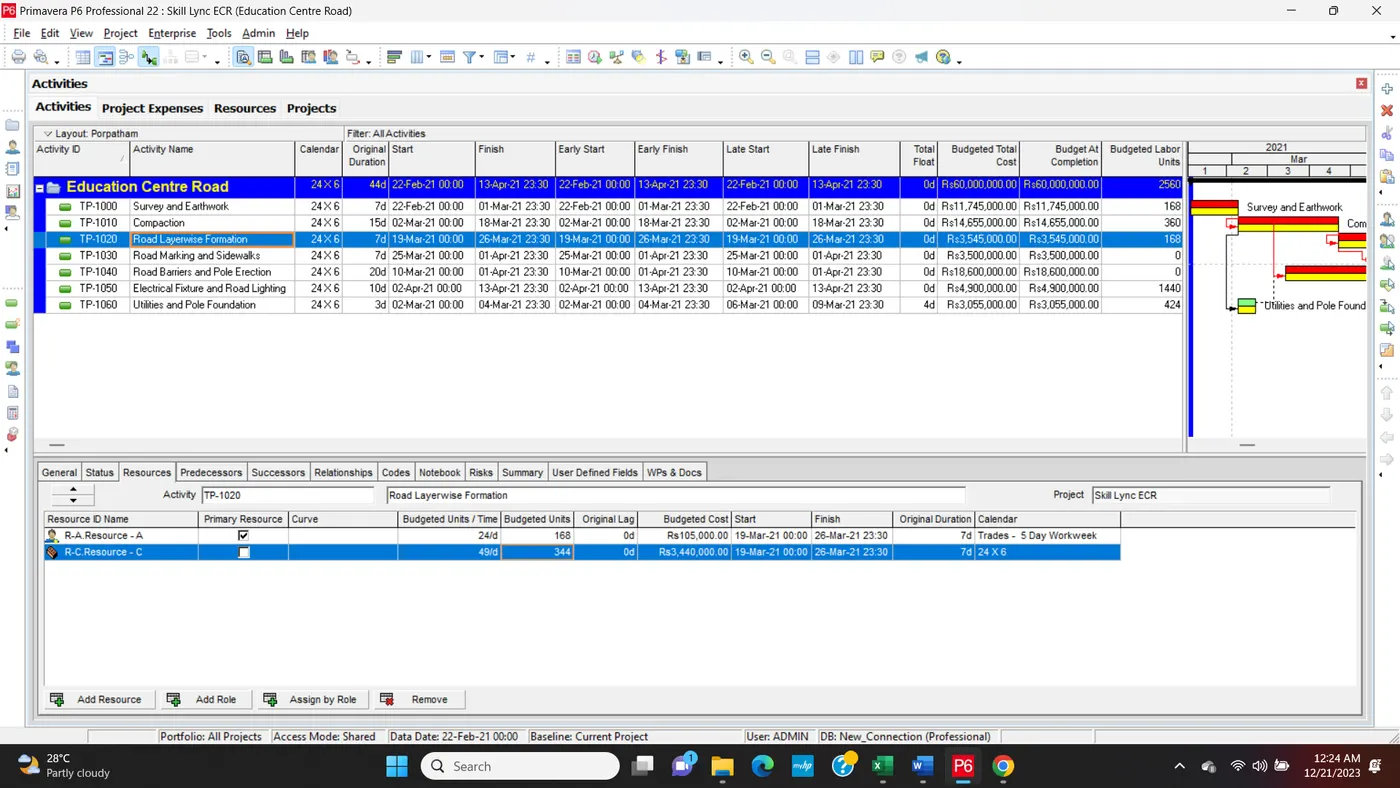

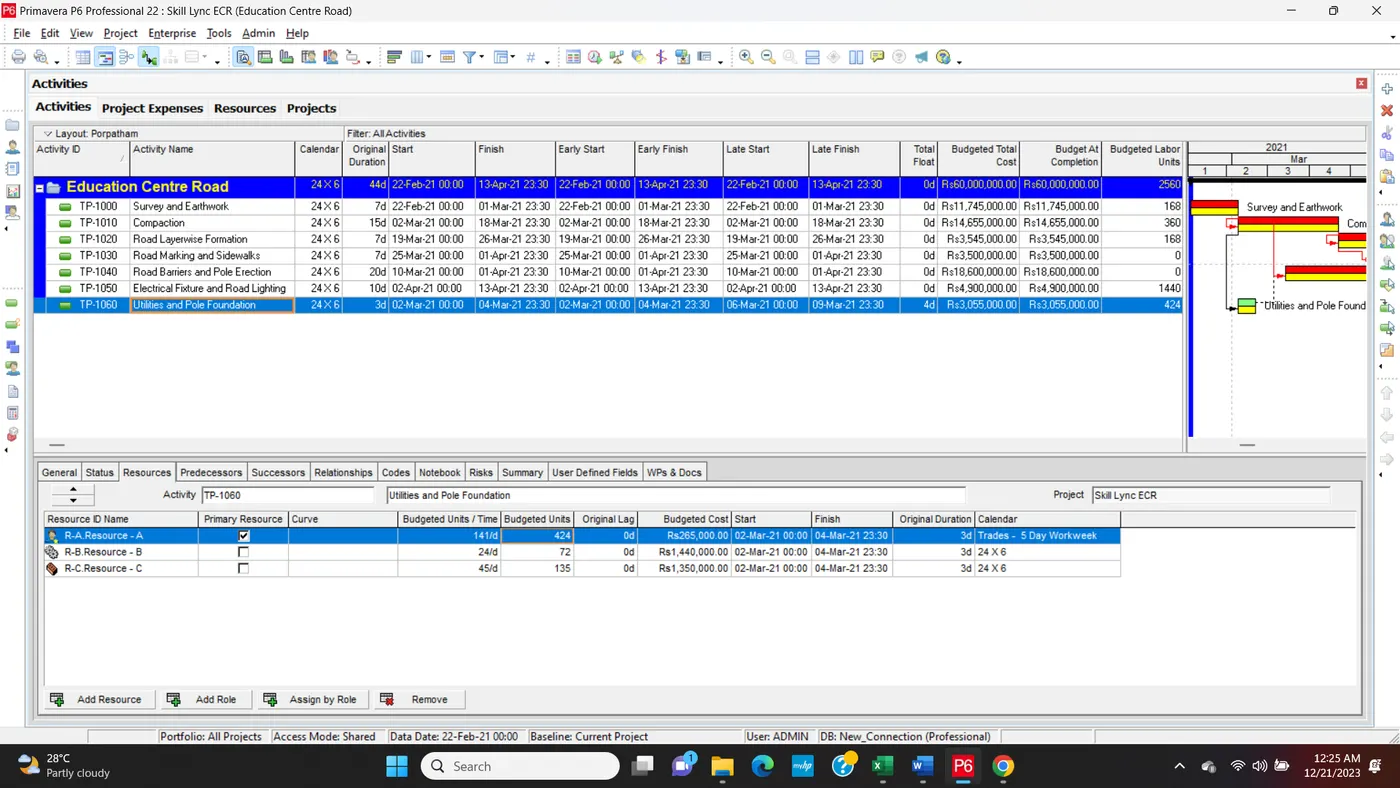

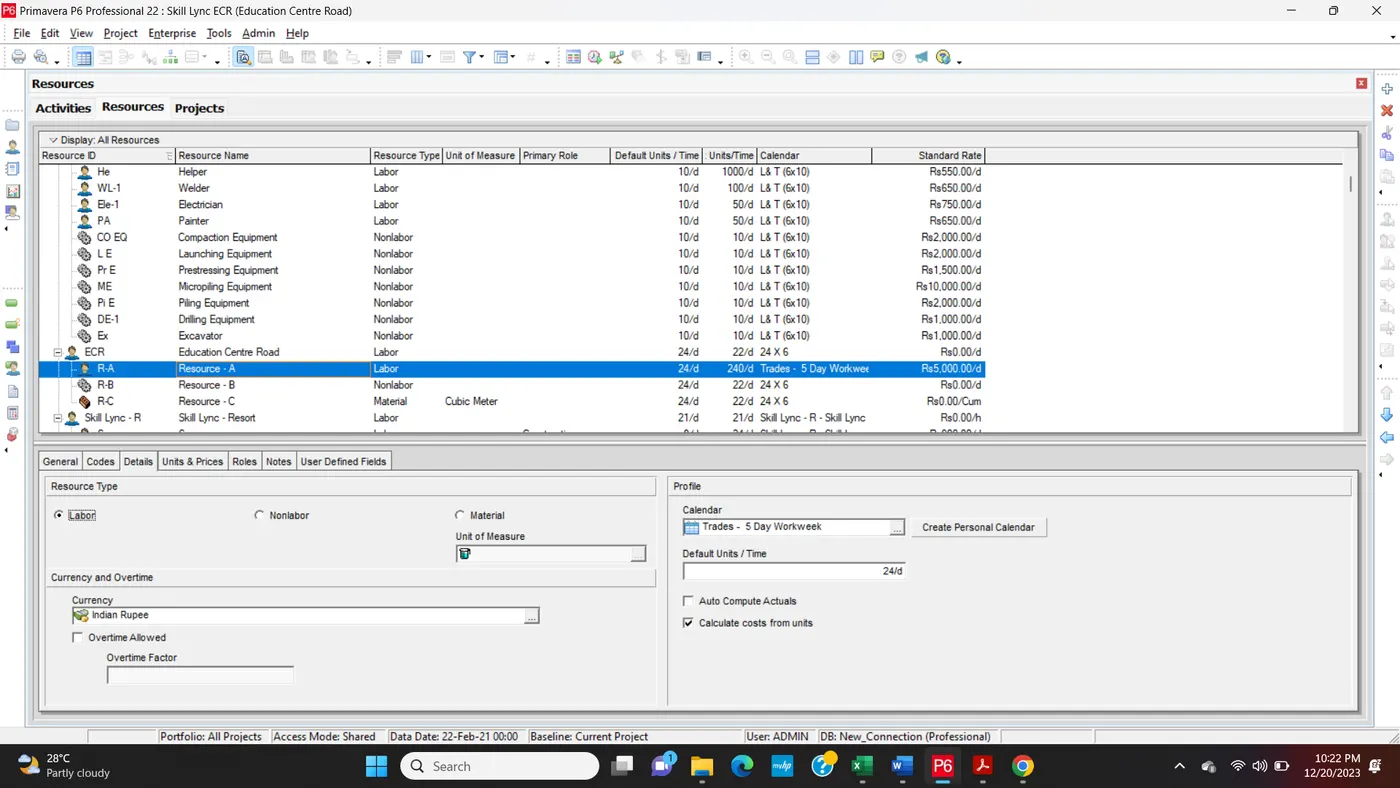

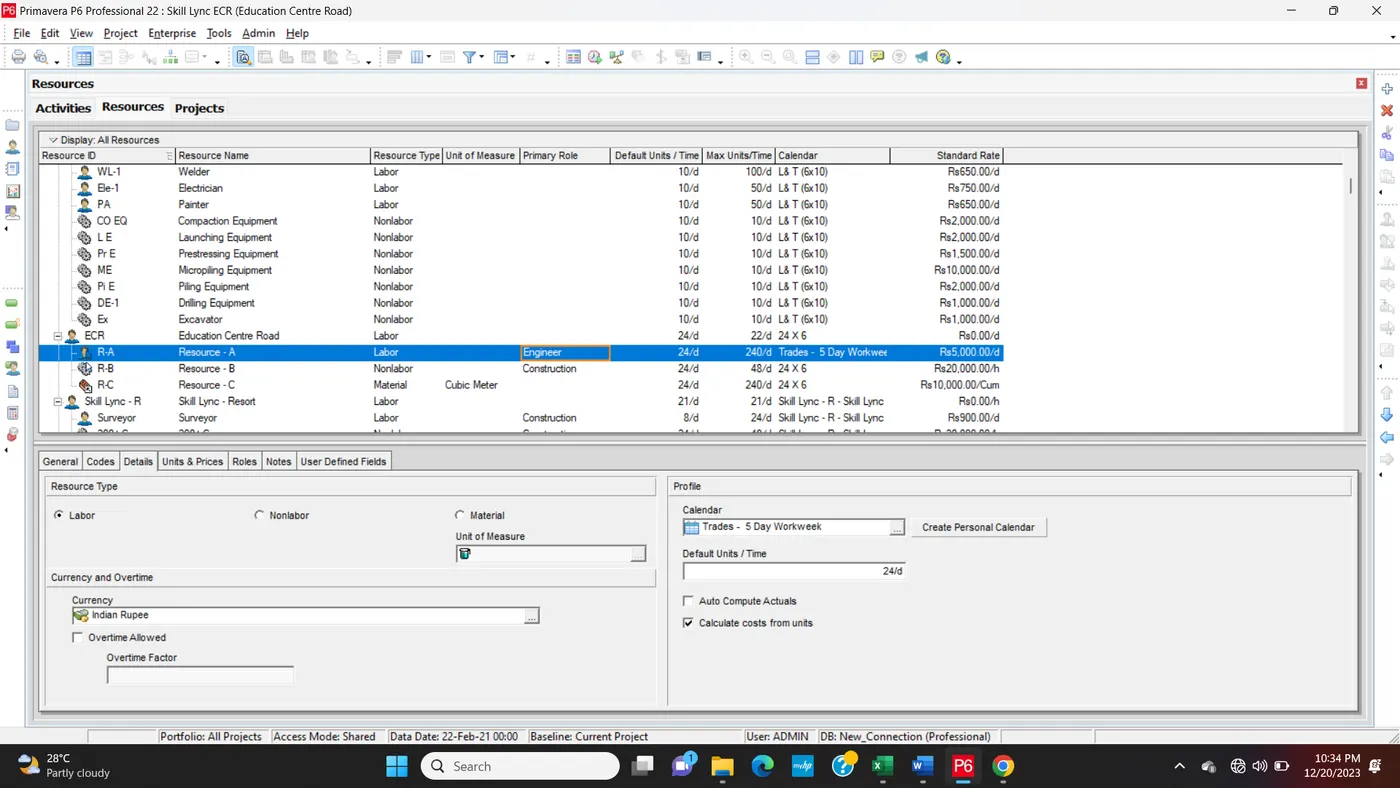

Q3. Define and Add resources

Step1: Add Resource Details, Max Budget unit, Standard Rate

Step2: Assign Role

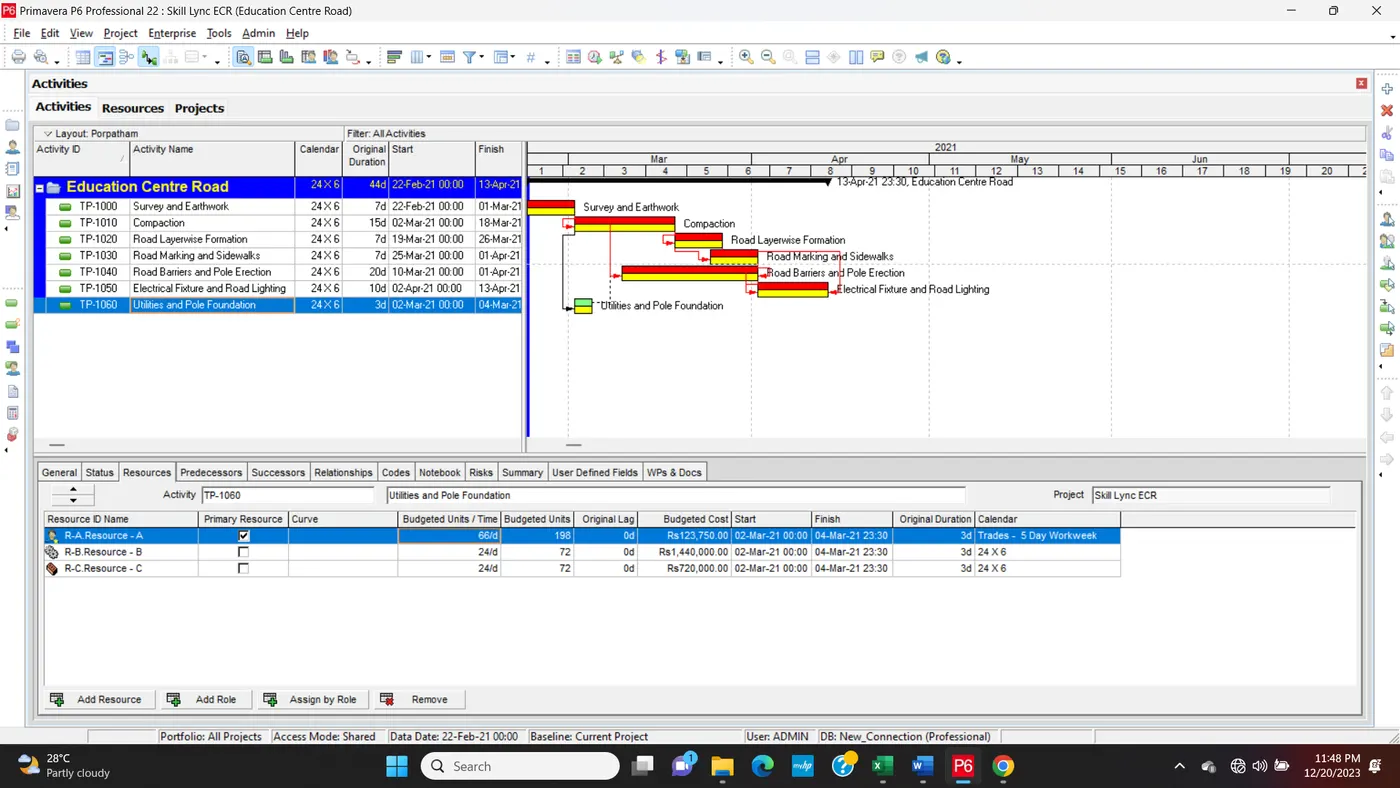

Q4. Add a budget to your project - INR 6 cr.

Step1:

Step2:

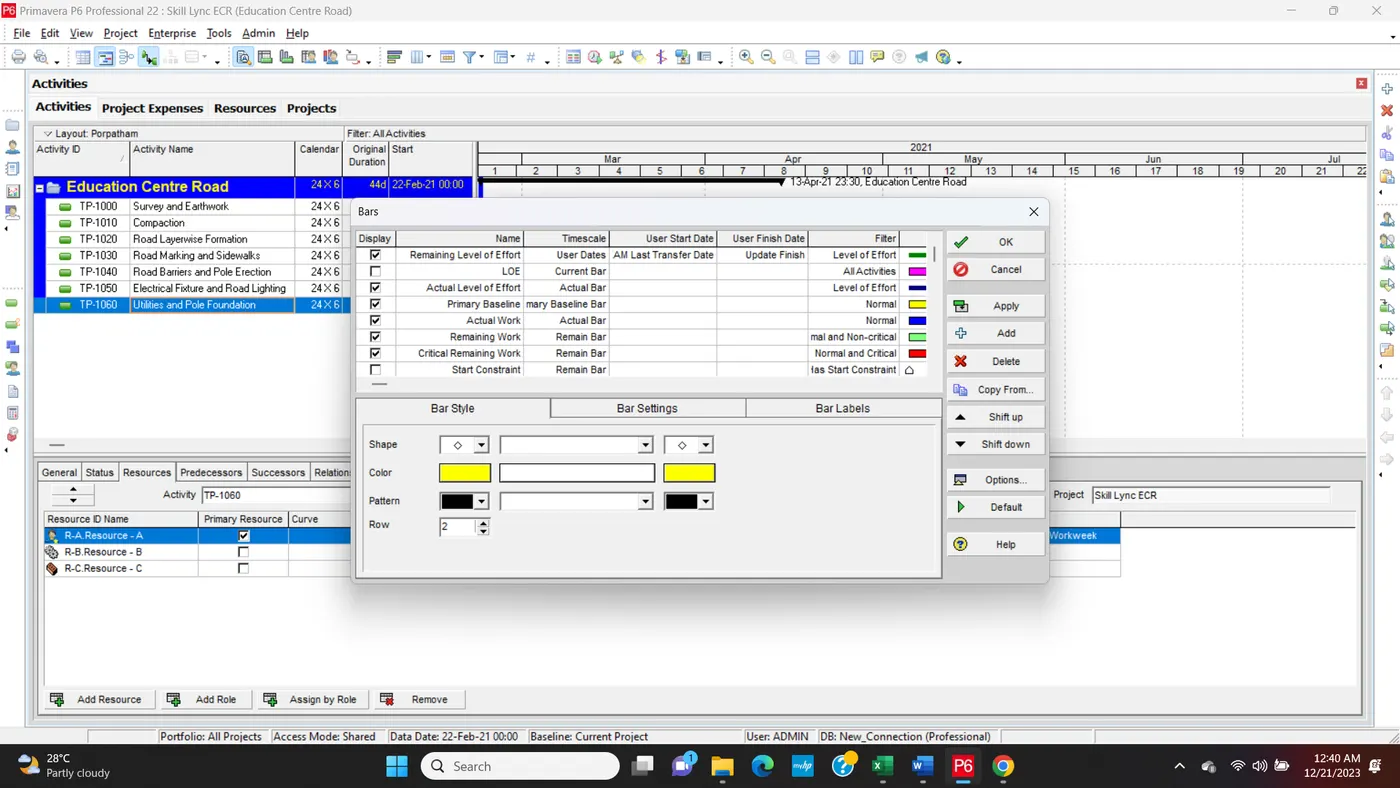

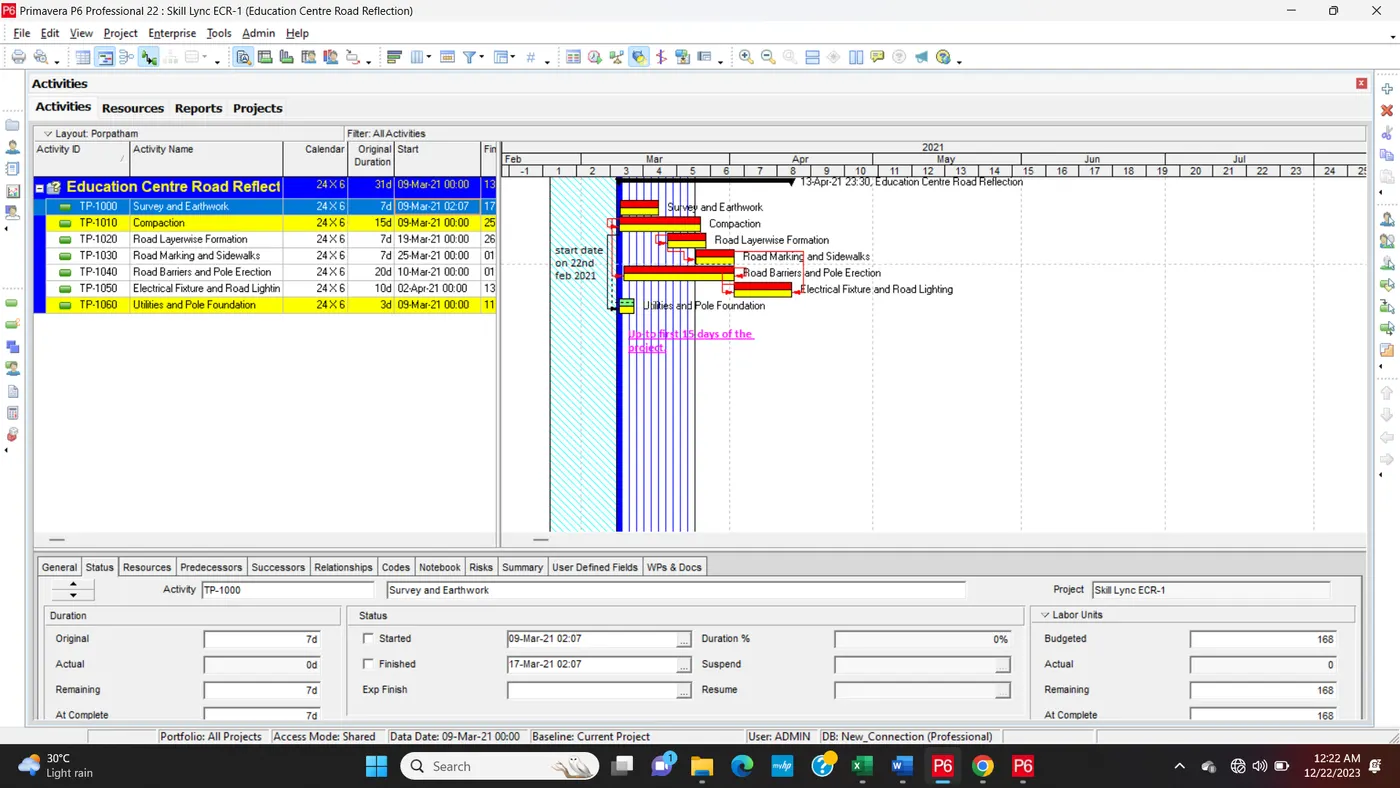

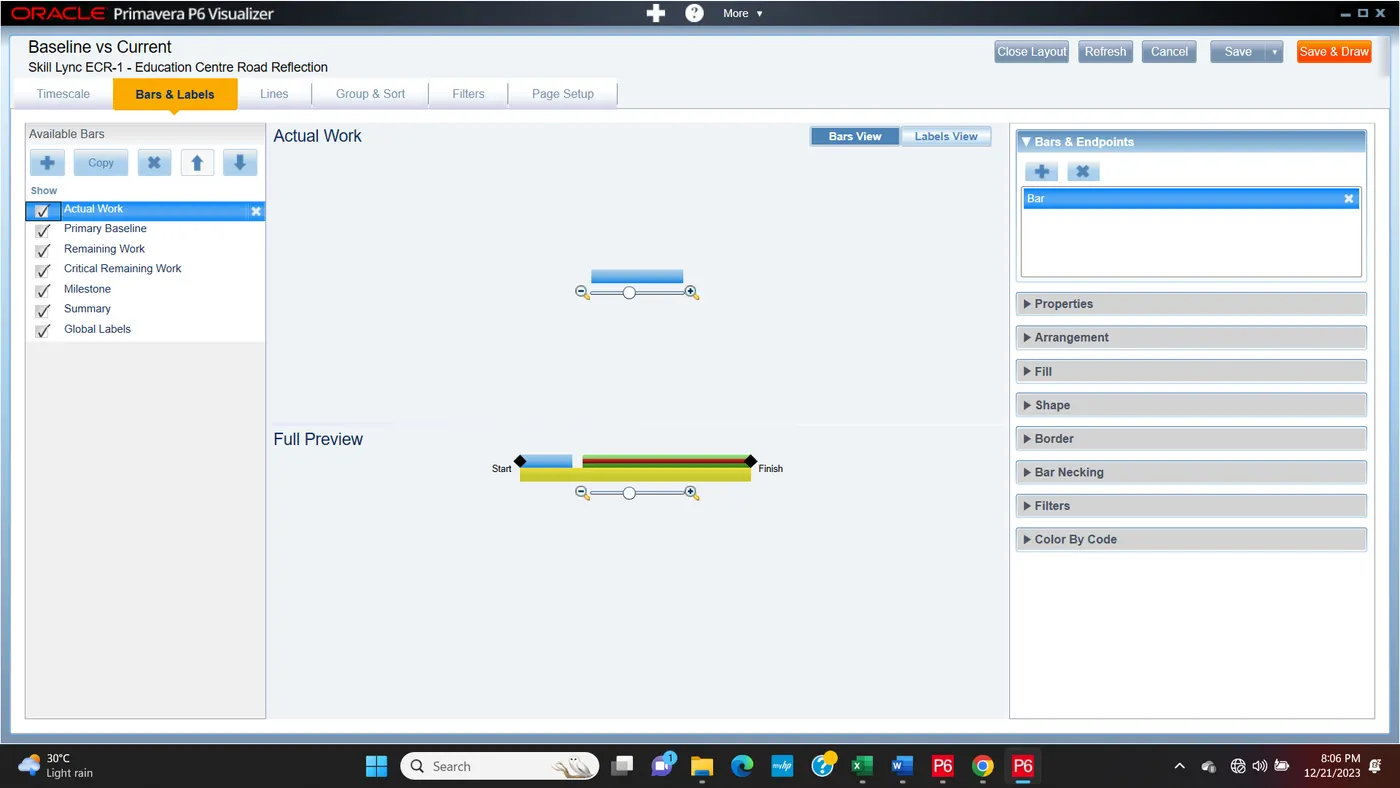

Q5. Assign a baseline to the project

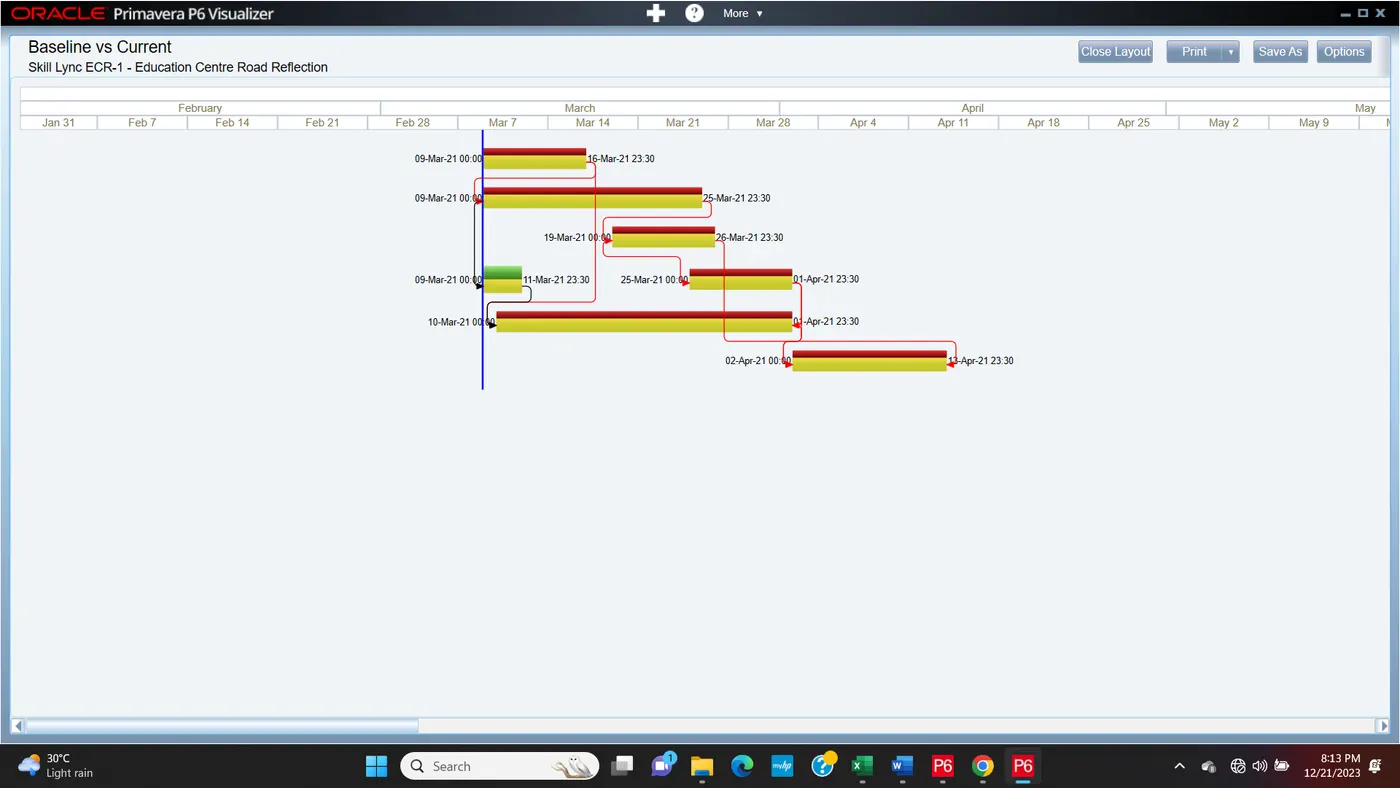

Step 1: Gantt Chart Right-click the Select Bar option.

Step2: Final Result Show in Gantt Chart Baseline Bar

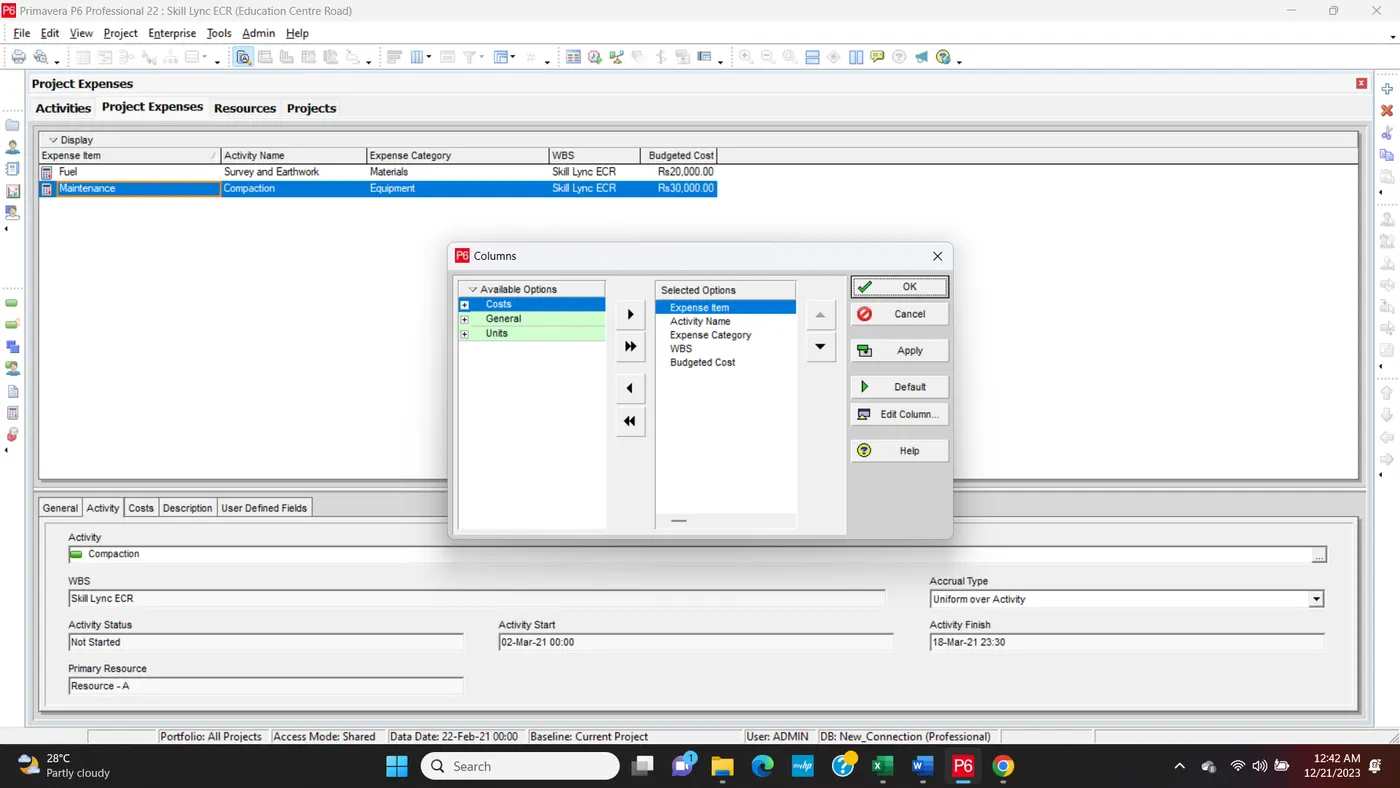

Q6. Add the following expense:

Task - 1 - Rs 20,000/- (Item - Fuel)

Task - 2 - Rs 30,000 /- (Item - Maintenance)

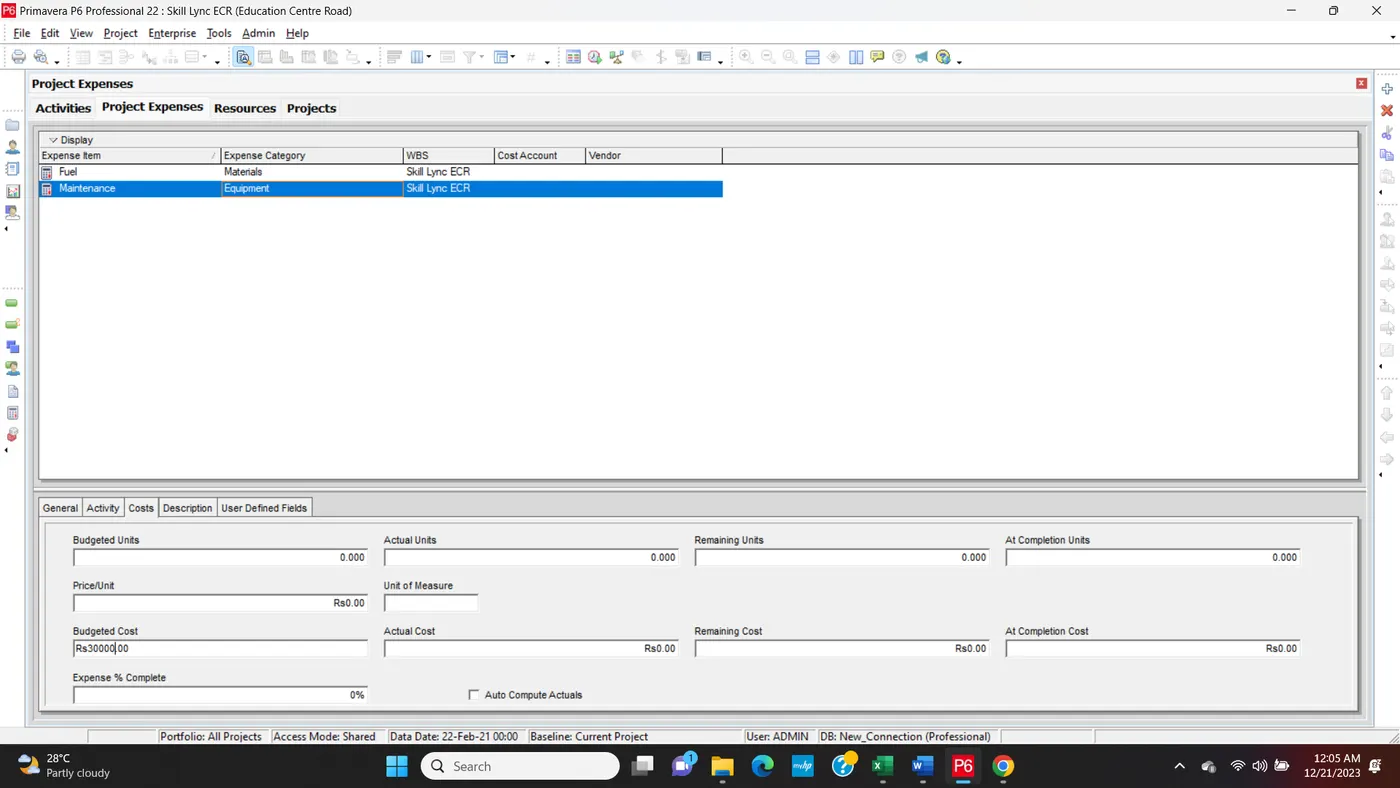

Step1: Go Project > Expense > + add Items

Step2: Final add Expense Cost

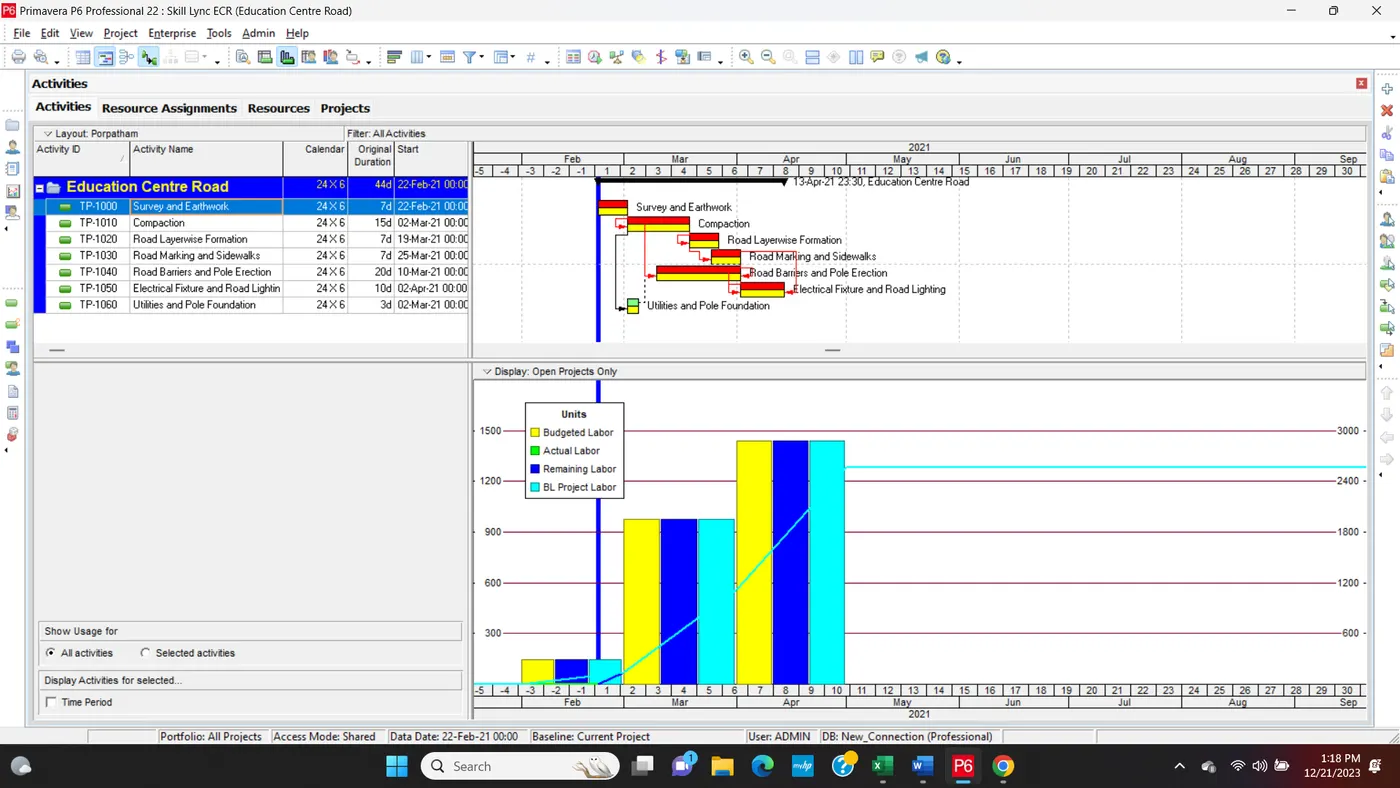

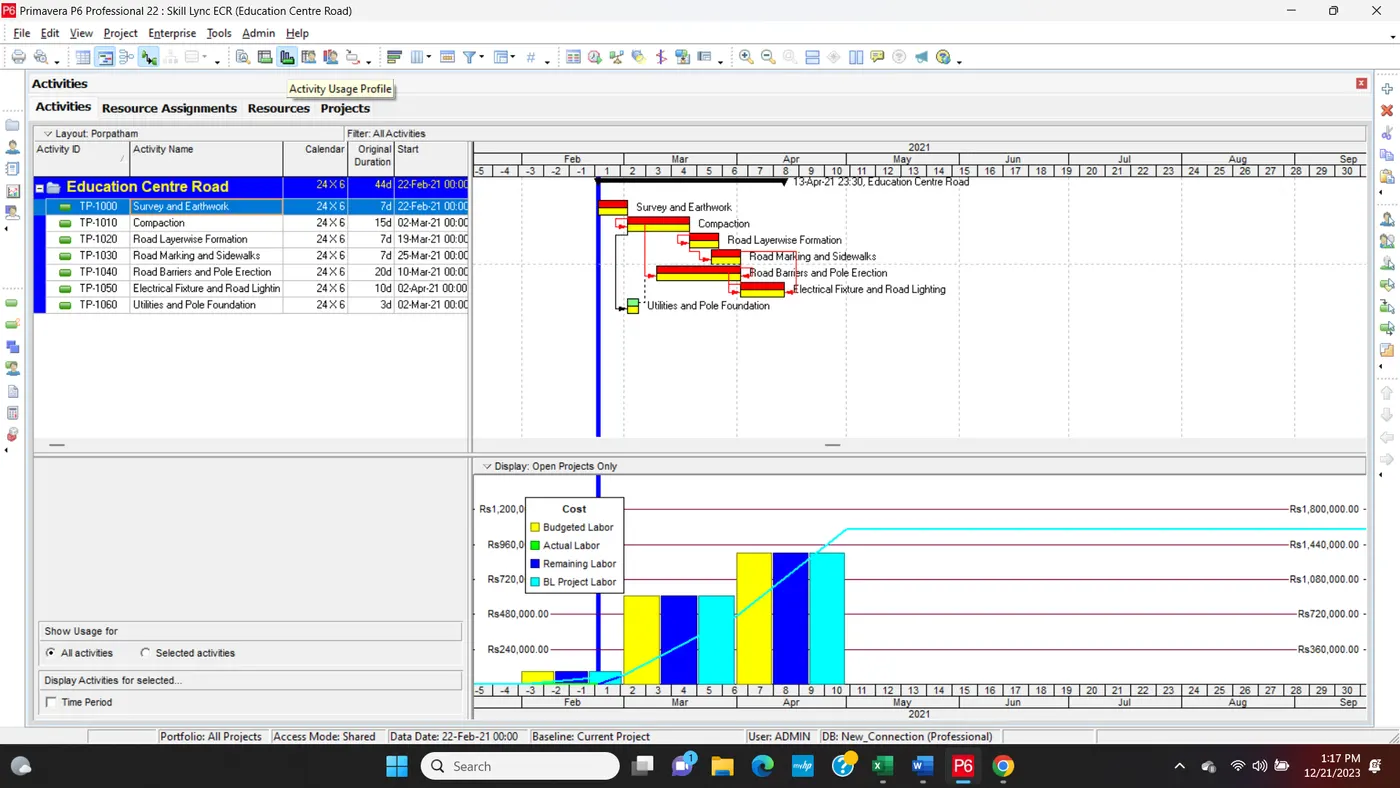

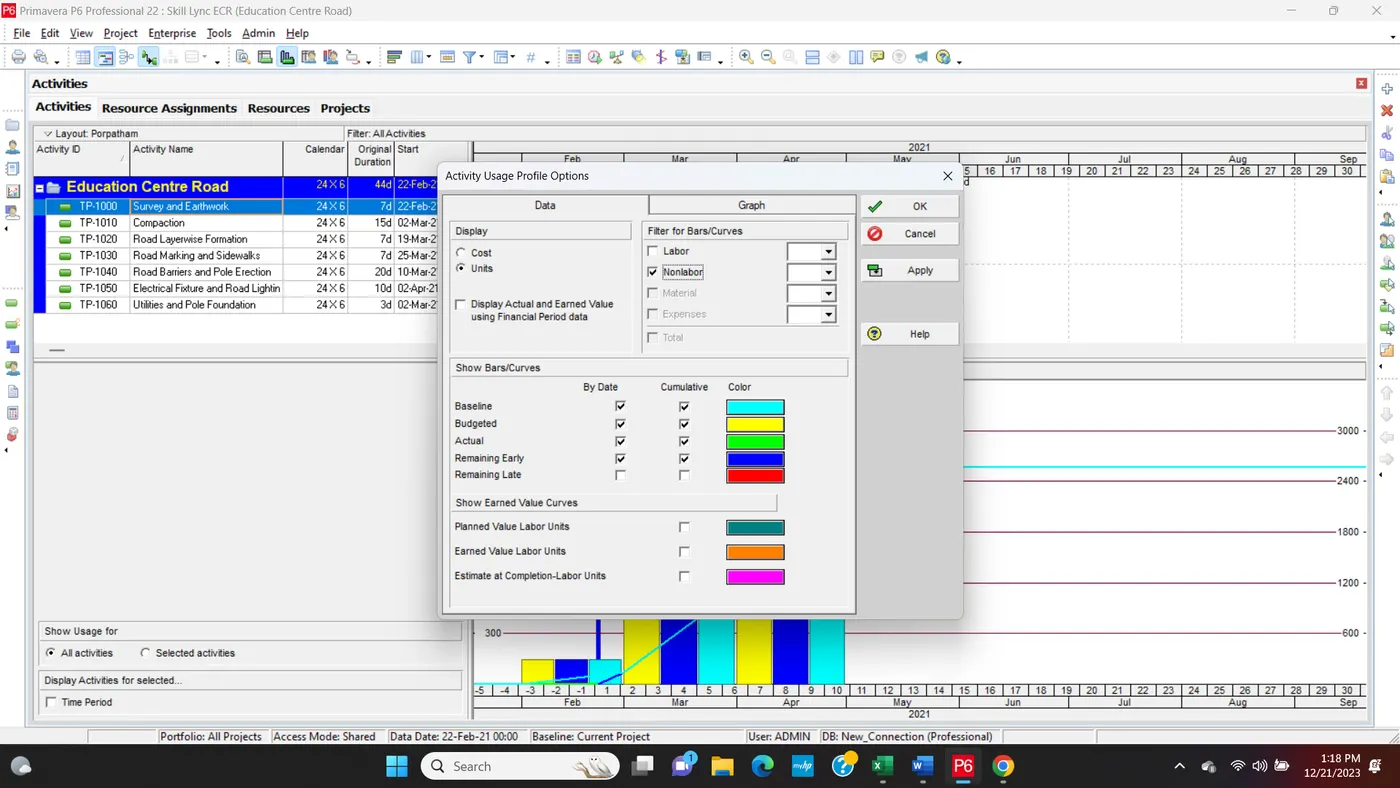

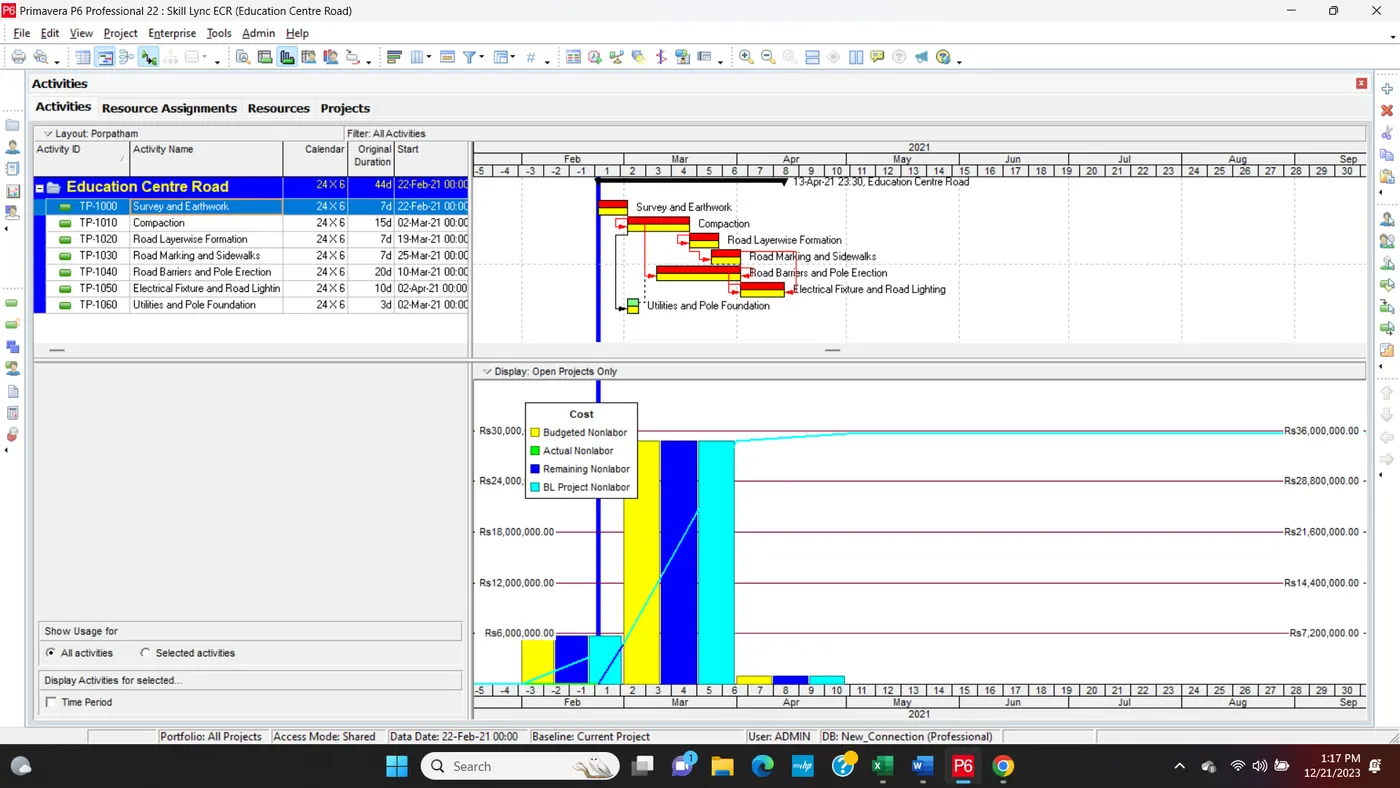

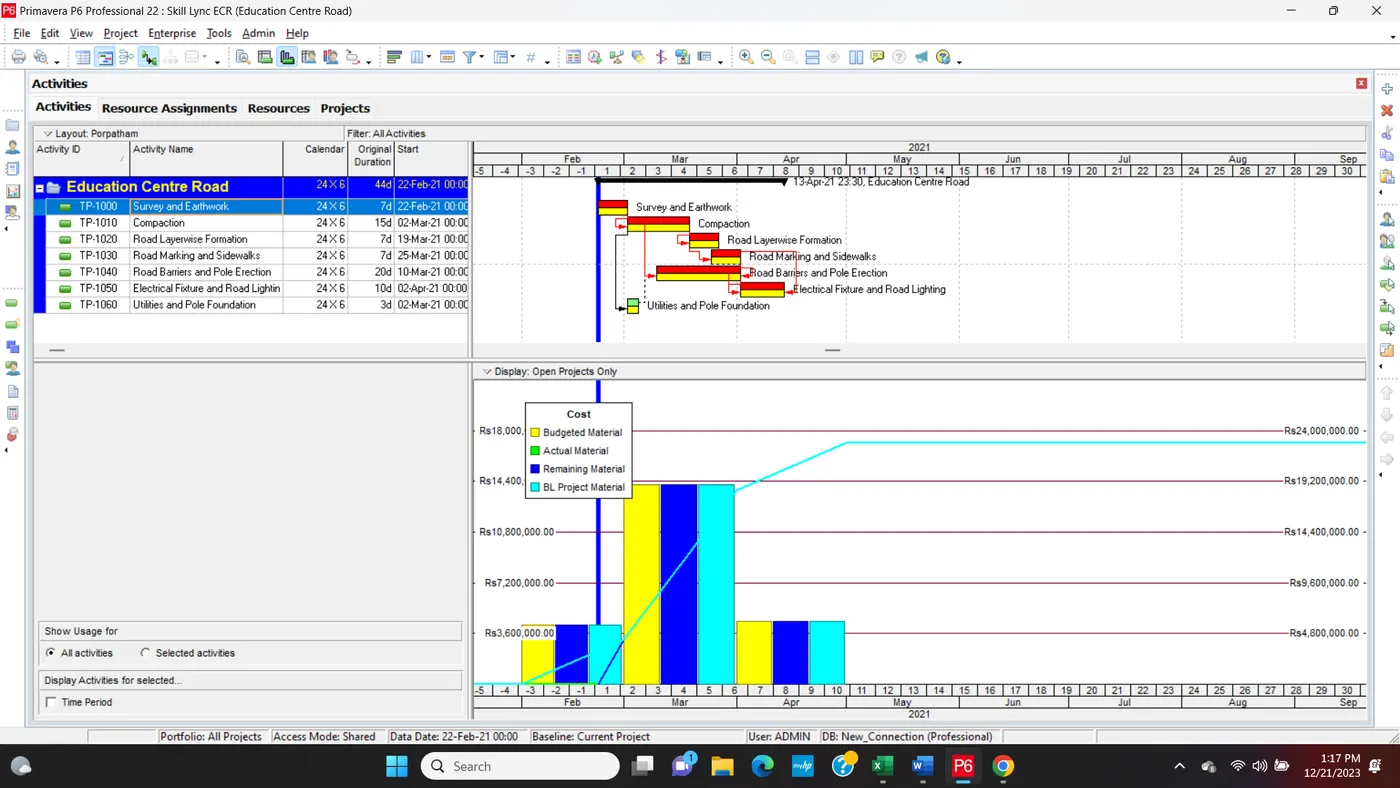

Q7. Generate material resource cost curve

Step1: Go to View > Show Bottom > Activity Usage Profile Click

Labor Cost

Material Cost Curve

Non Labor Cost Curve

Labour Units

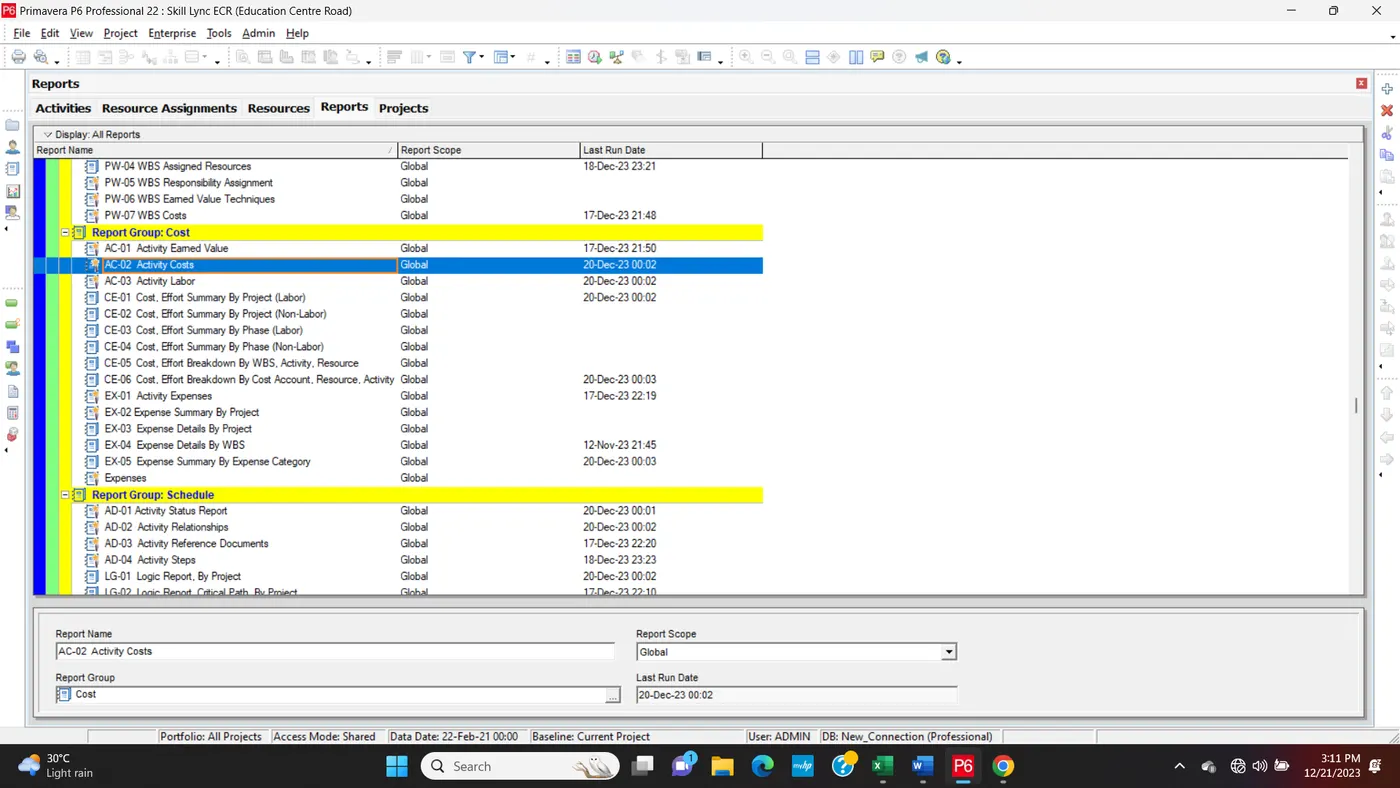

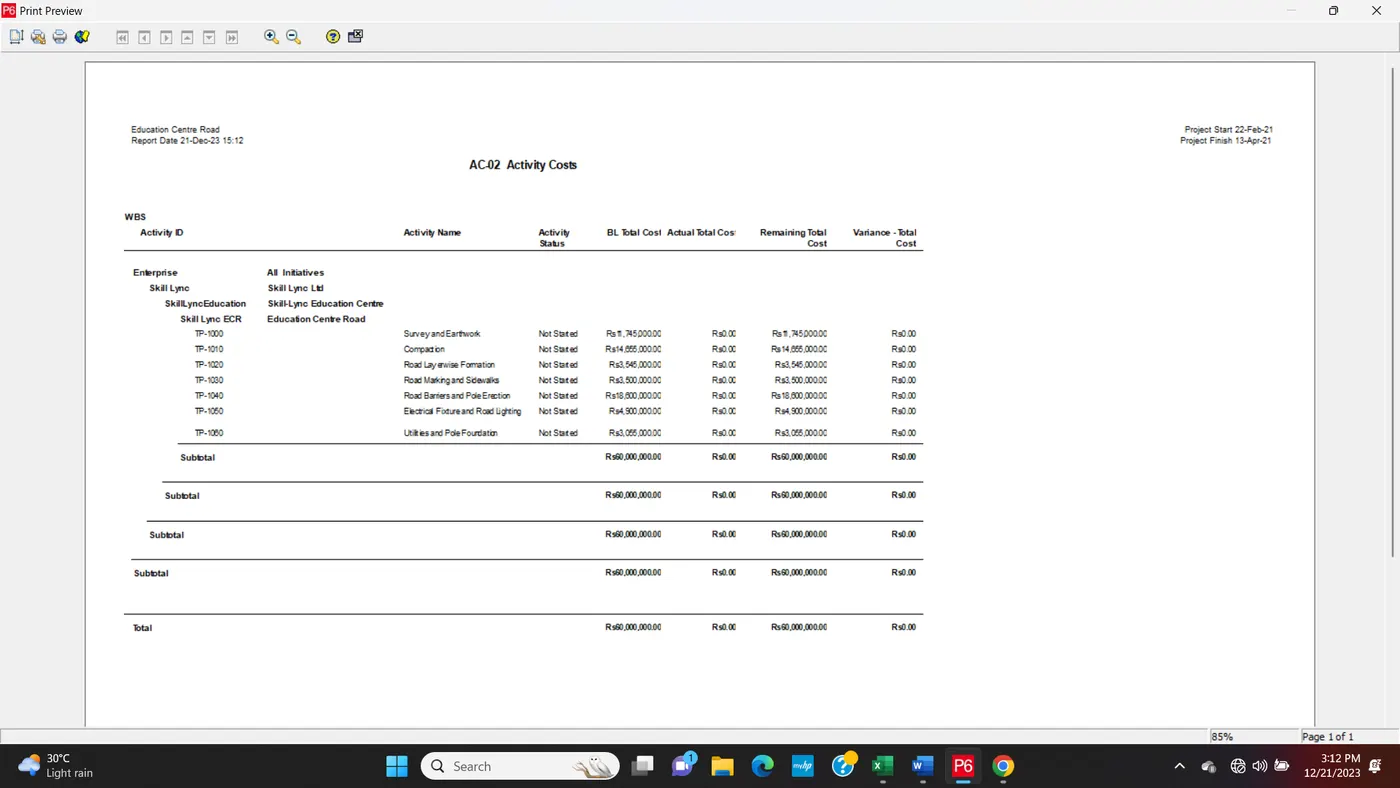

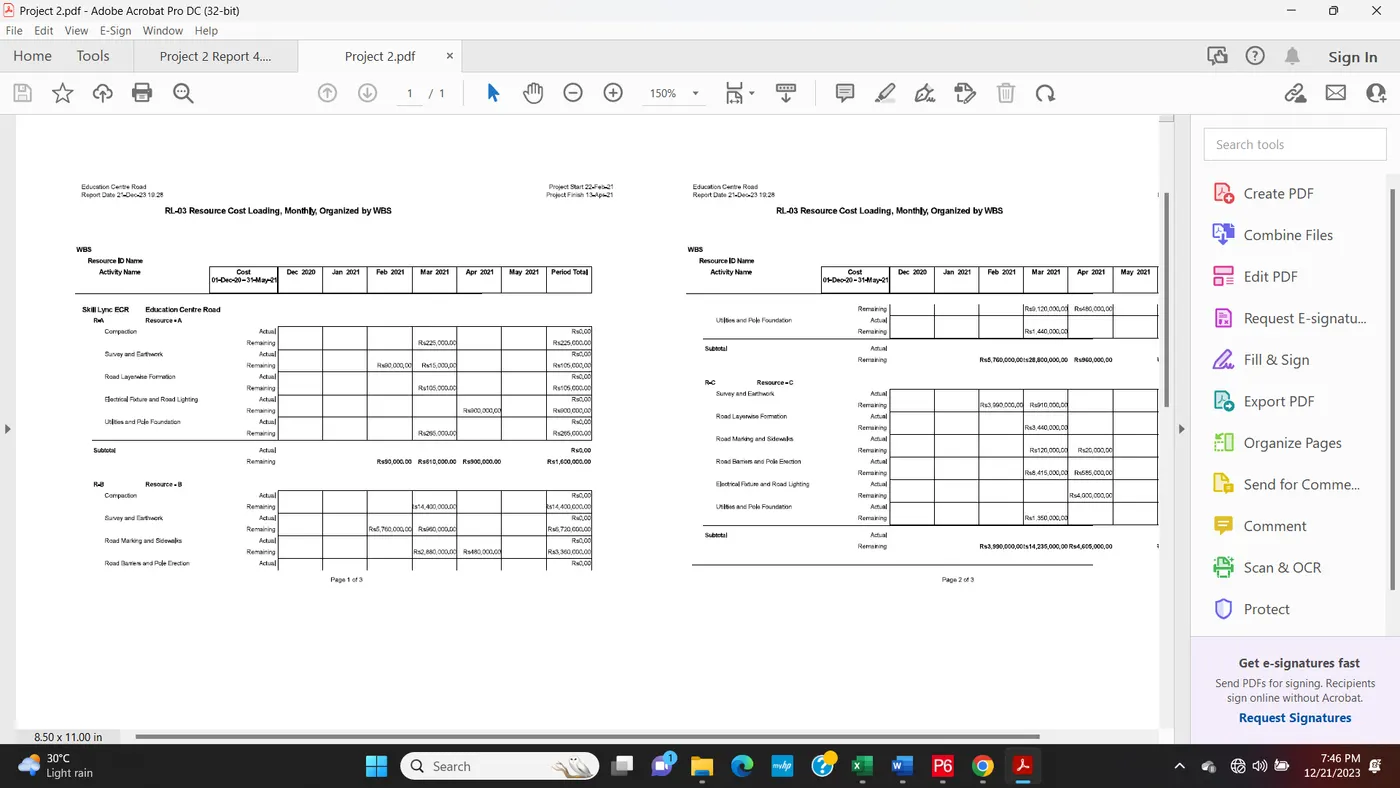

Q8. Generate an activity-wise cost report

Step1:

Step2:

Step3:

Step4:

Q9. Create a reflection

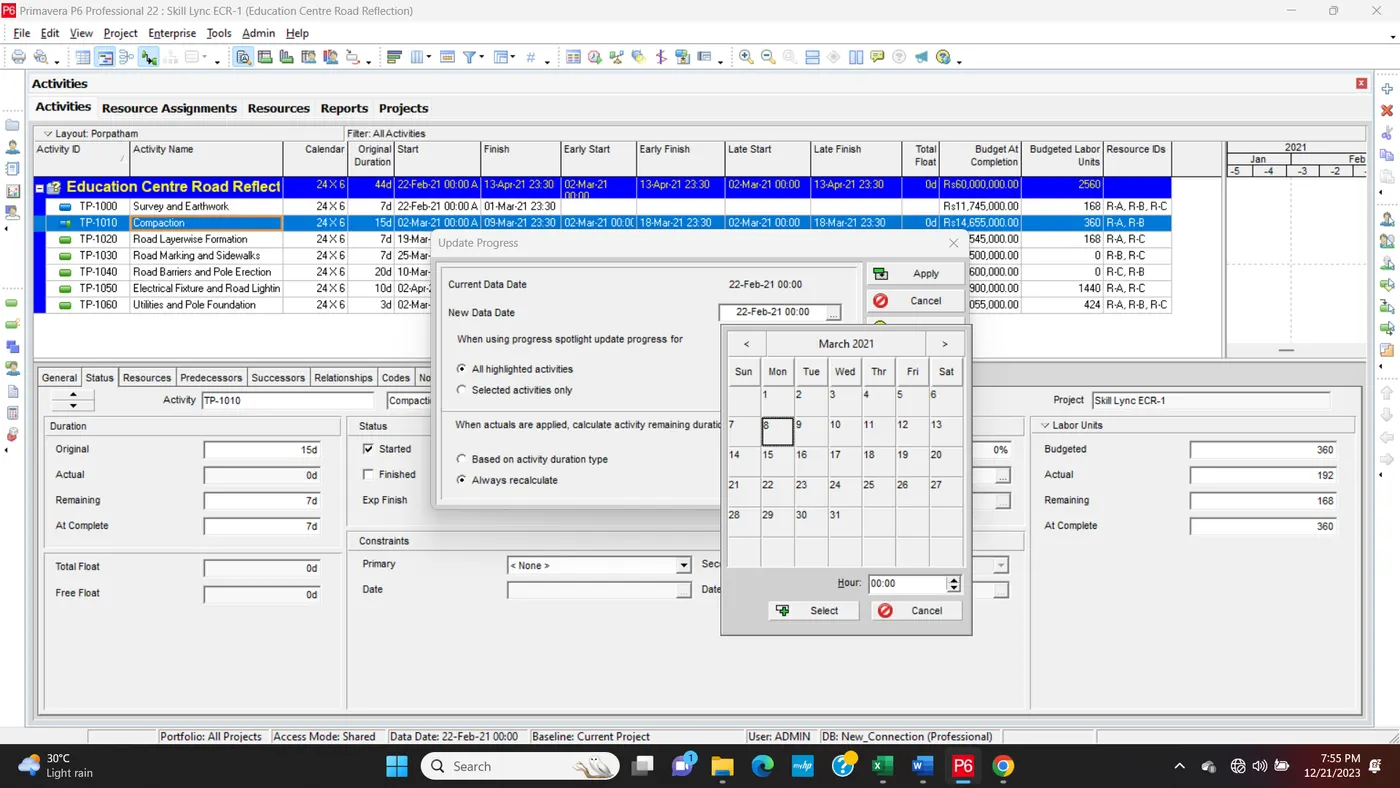

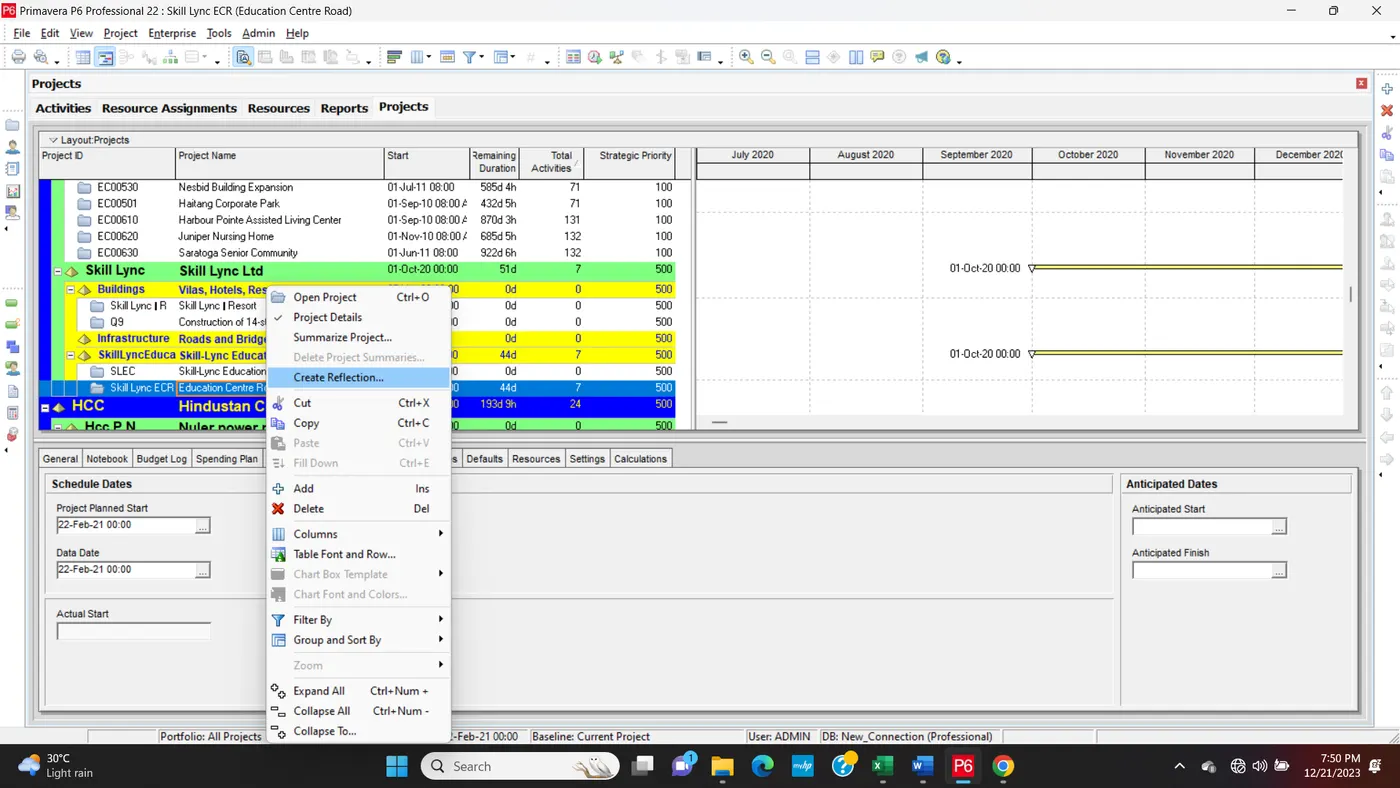

Step1: Goto Enterprise > Select Project > Select Project Name > Right Click > Craete Reflection

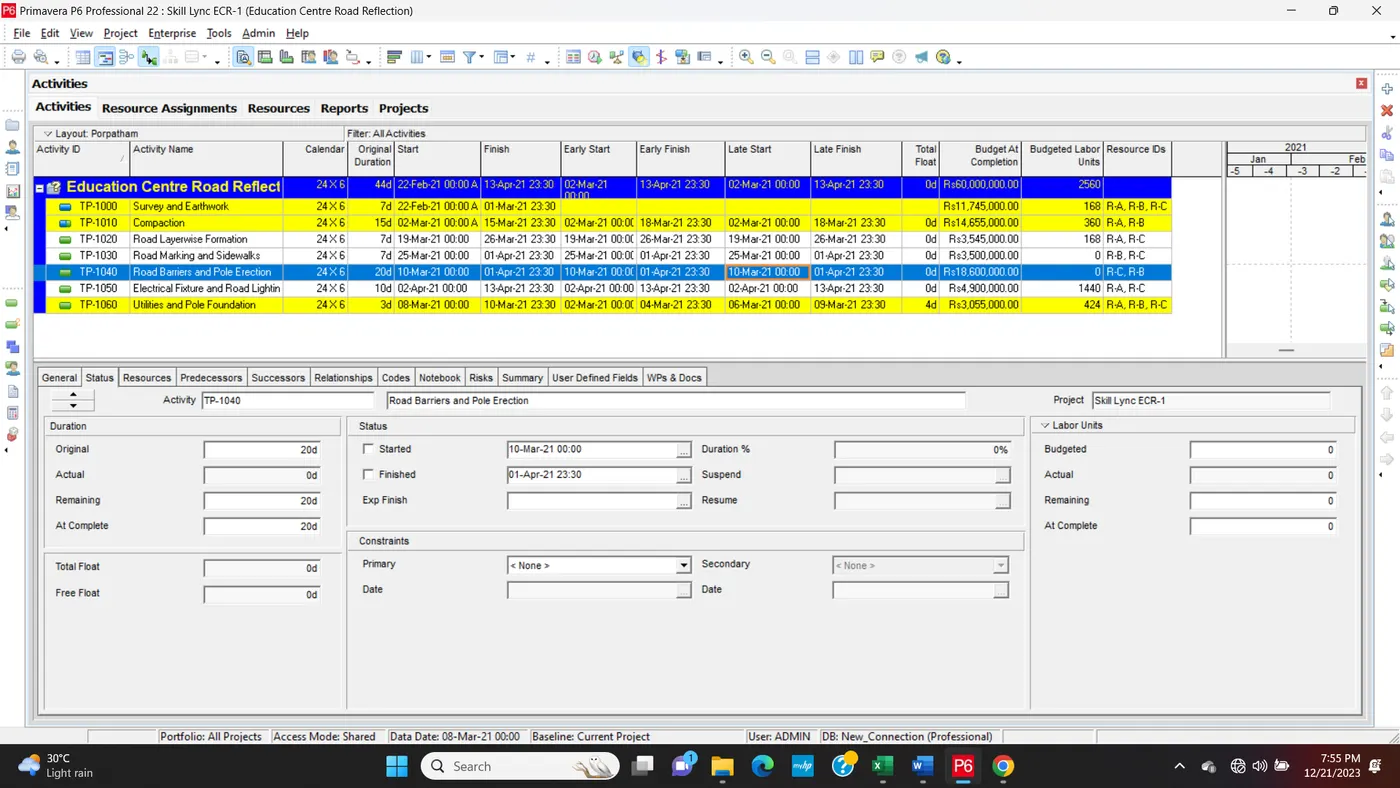

Q10. In the reflection, auto update the project at 15 days from start

Step1:

Q11. Open a TSLD view of the project in Visualizer

Step1: Goto Tools > Visualizer

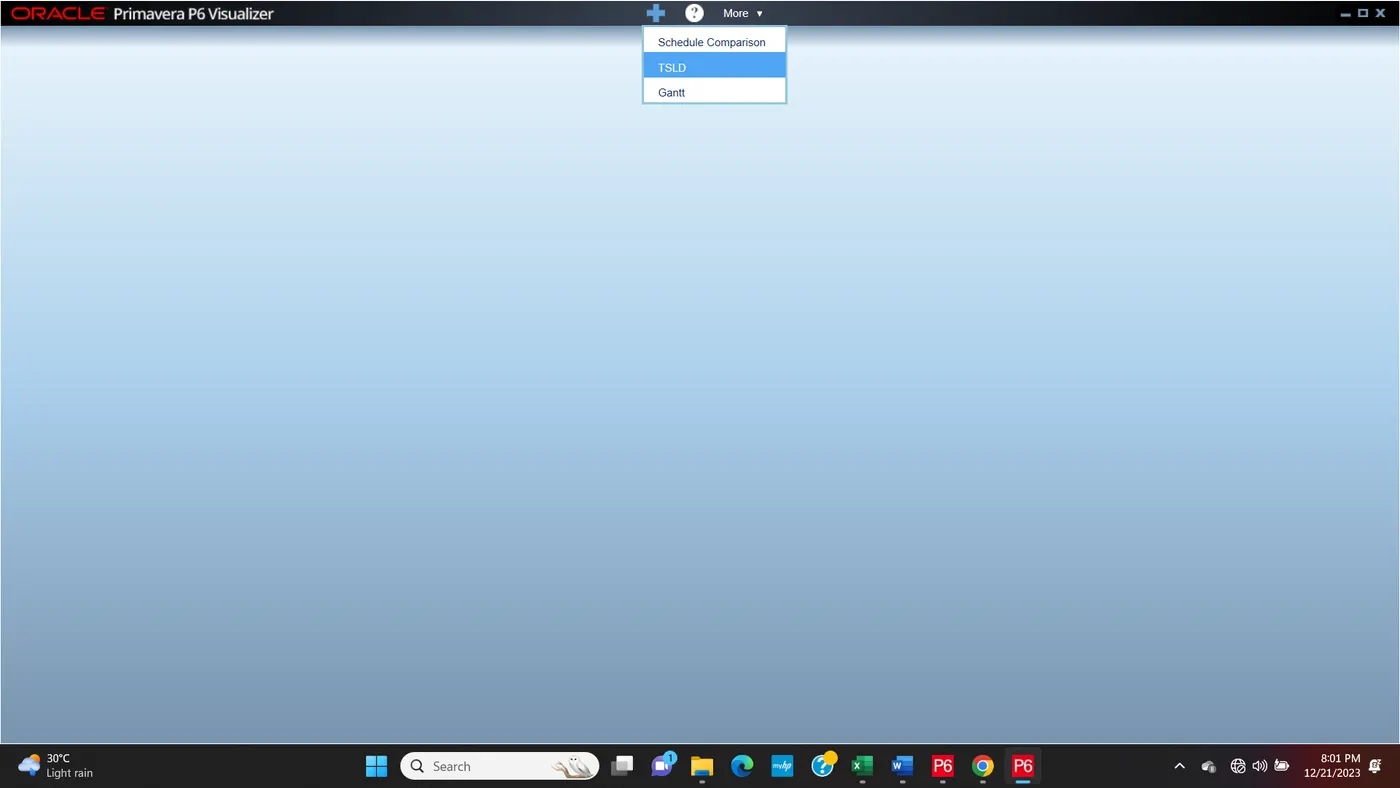

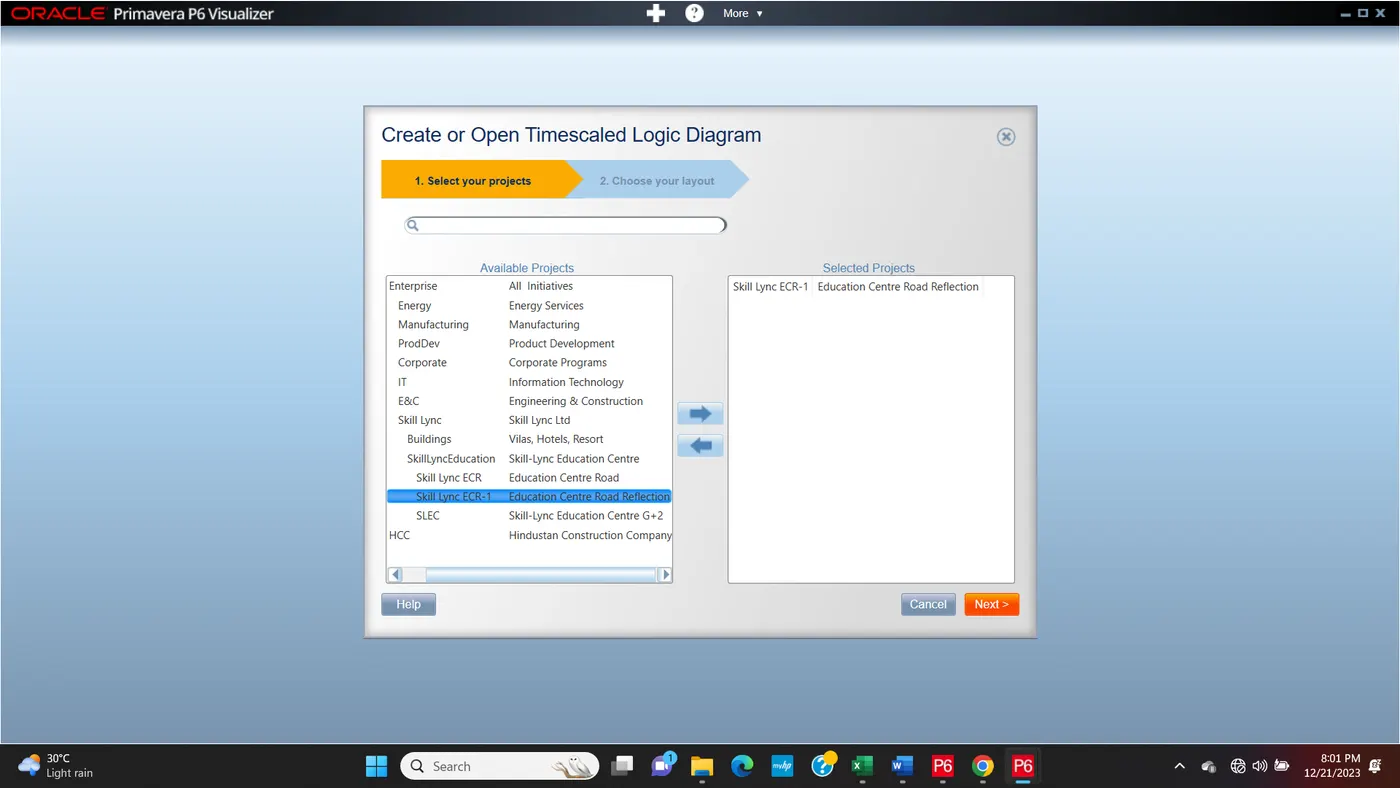

Step2: Visualizer > Select TSLD >

Step3: After Click TSLD > Select Current Project > Choose layout

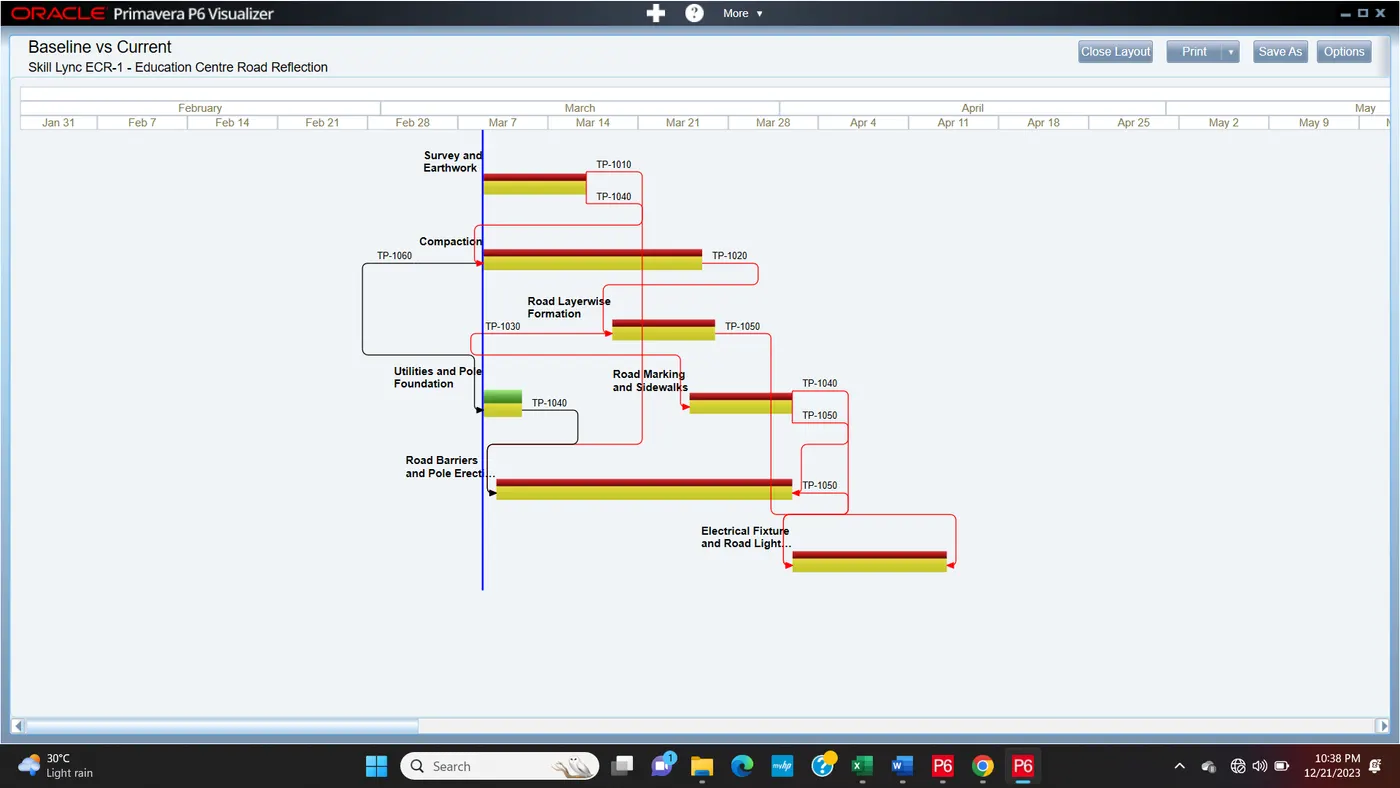

Step4: Final of TSLD project

Activity Network Diagram

.

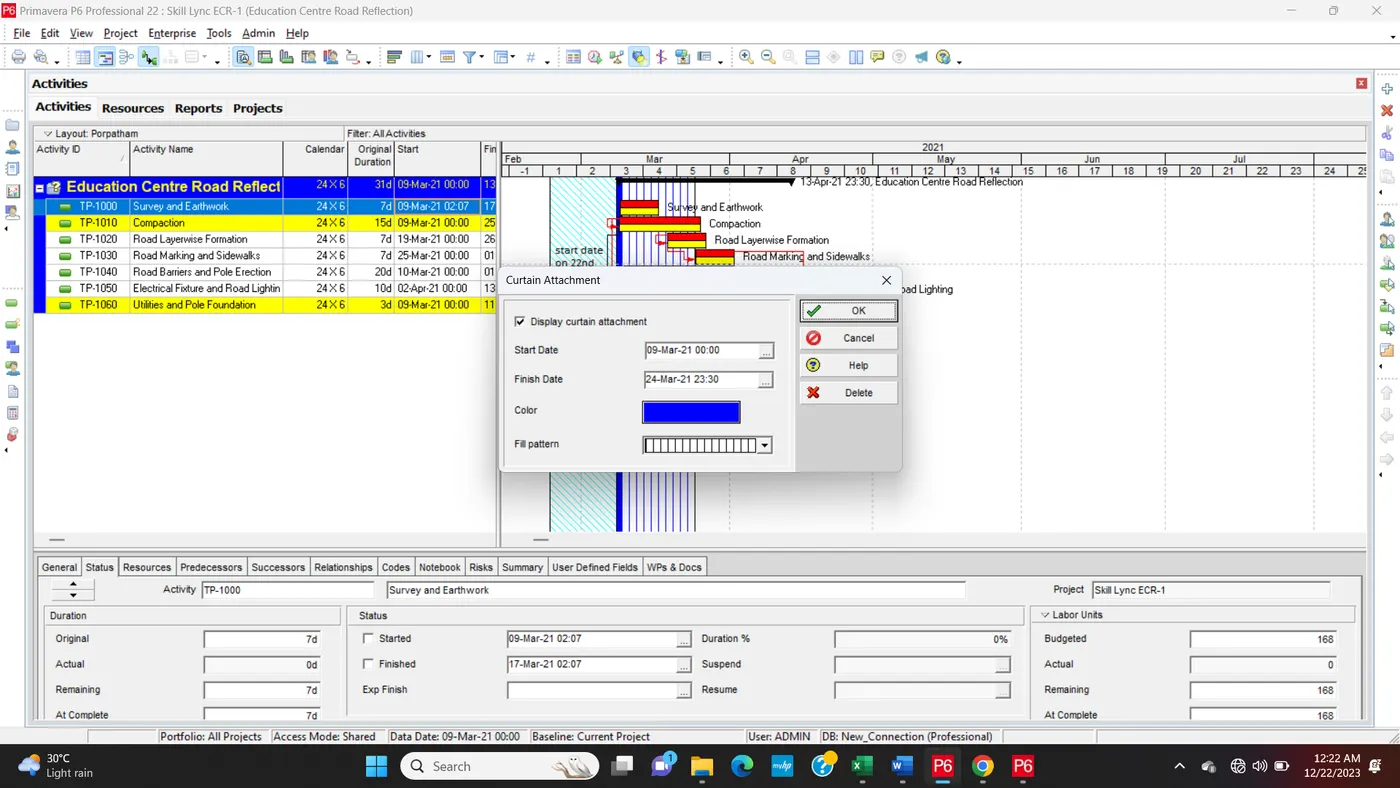

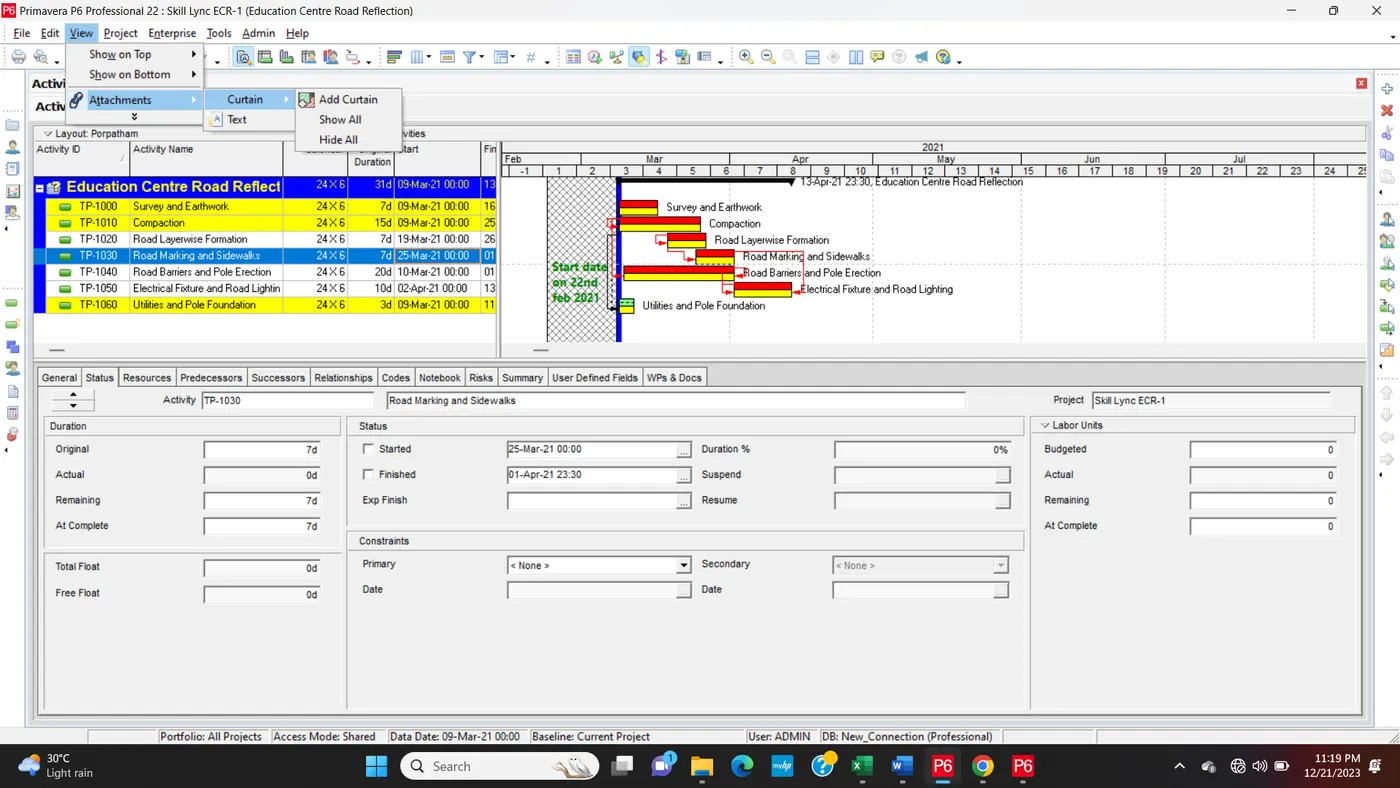

Q12. Add curtains up-to first 15 days of the project.

Step1:

Step2:

Step3:

Step4:

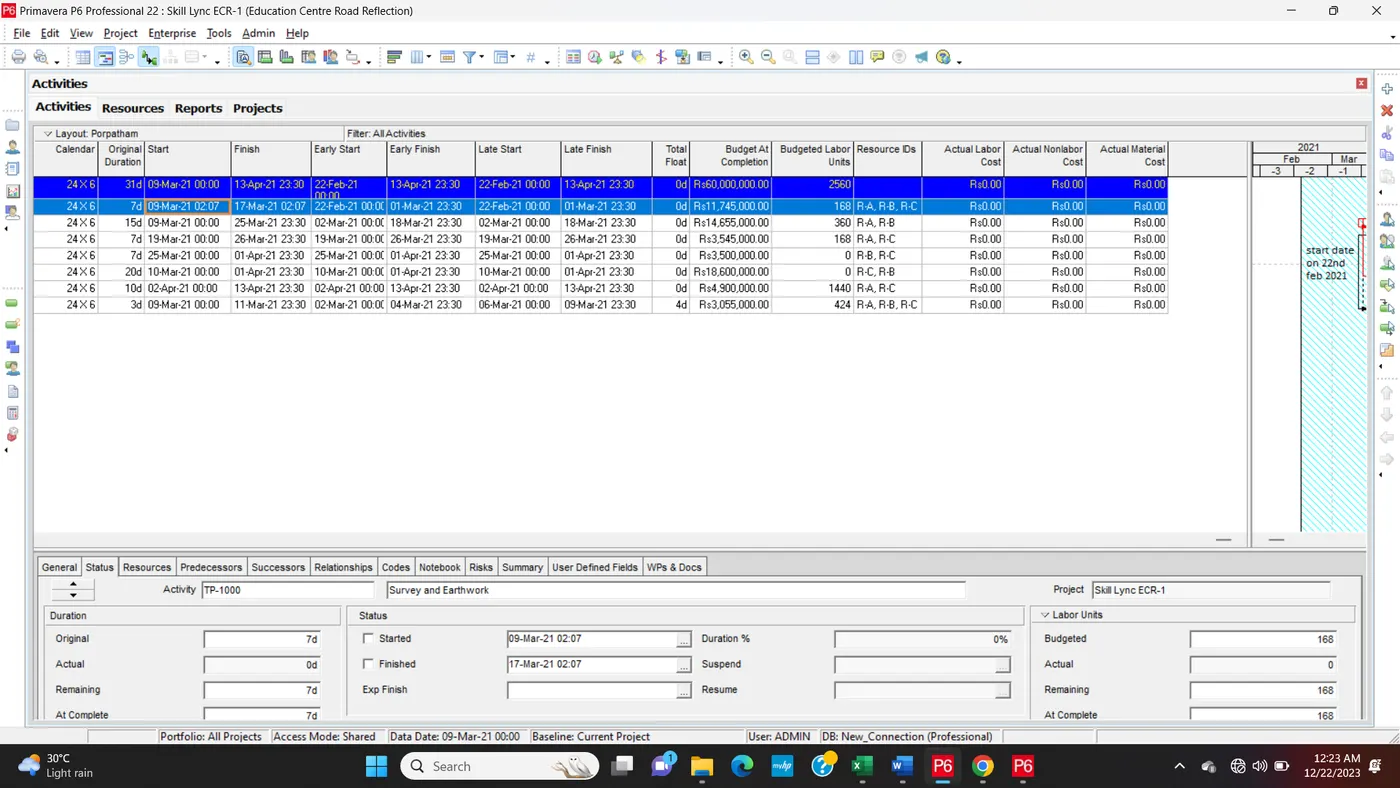

Q13. Find out the actual cost for labour, non-labour and material cost of the updated schedule

Step1:

Step2:

Step3:
