Challenge

Project 2

AIM:

A 100 m WBM road needs to be constructed inside the Skill Lync Education center premises to allow access to the center for students and faculties.
Create the following Project (under same EPS/OBS as project-1) and Resource :
Project Name - Education Centre Road
Assume - Calendar as 6 x 24 and start date on 22nd Feb 2021

Procedure :
*Open the previous project in P6

*Go to projects page > new project

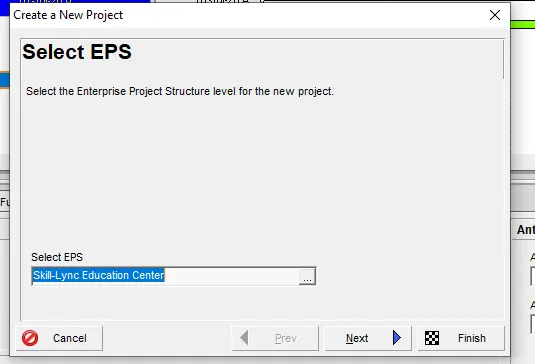

*Choose eps as previous " Skill-Lync education "

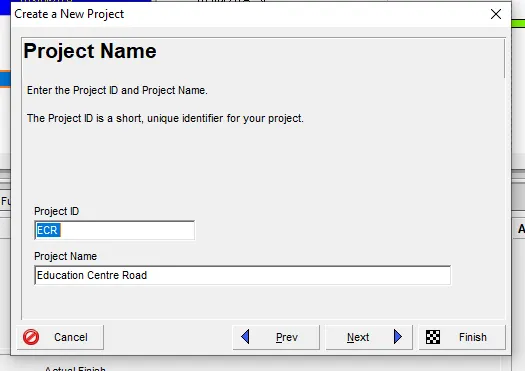

*name the project as Education Centre Road

*Mention the start date as 22nd Feb 2021

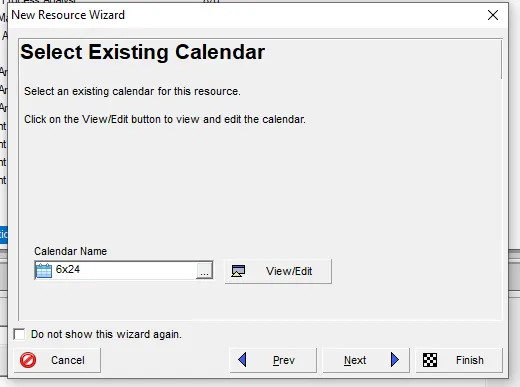

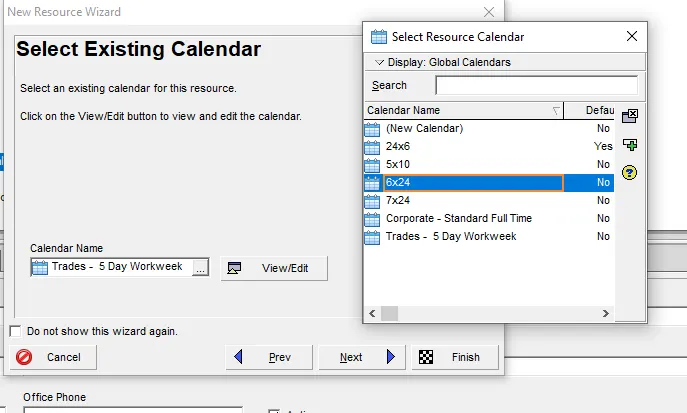

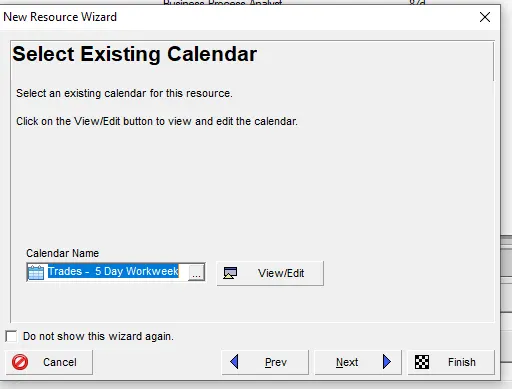

*Calendar as 6X24, and choose the responsible manager

*Go to enterprise tab >resources option

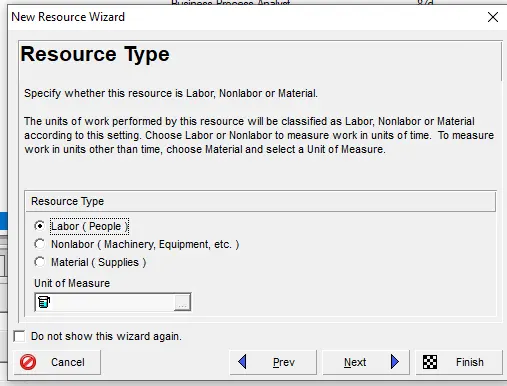

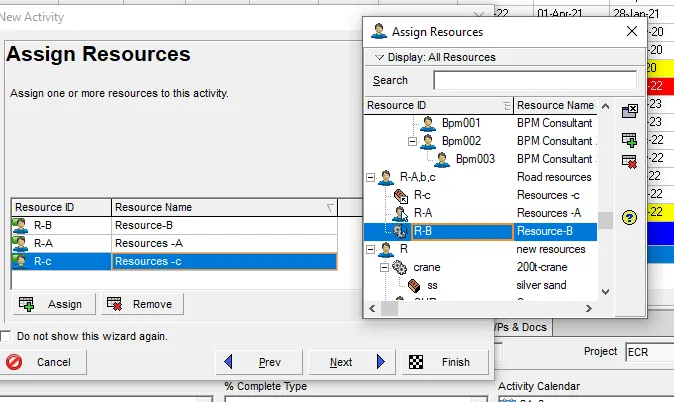

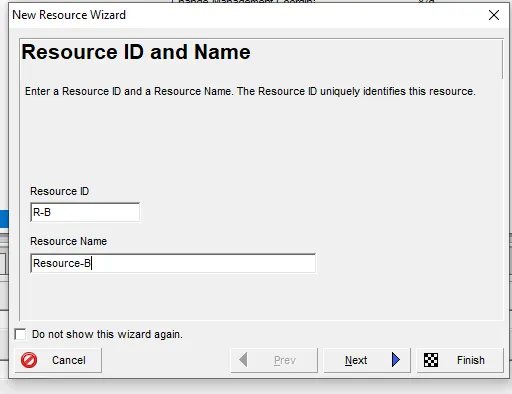

*Click +

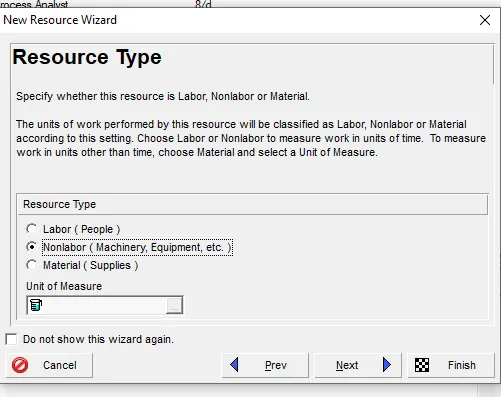

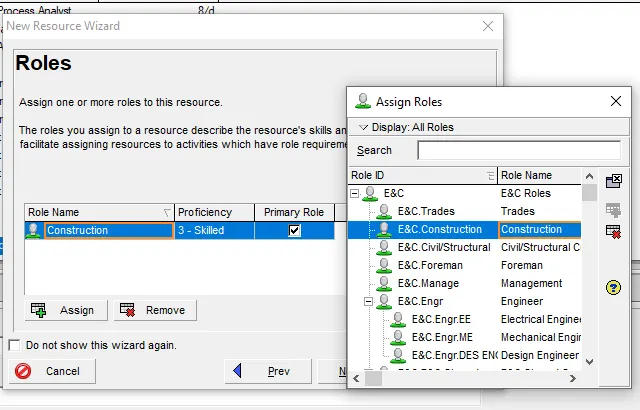

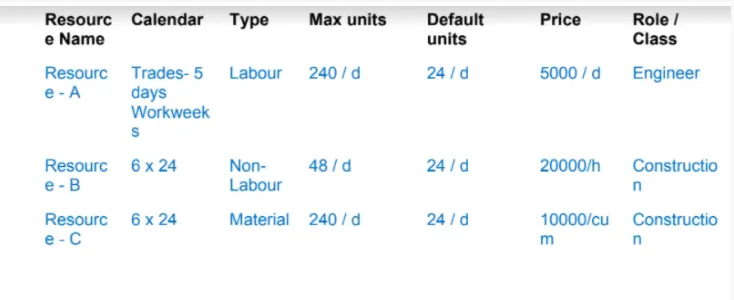

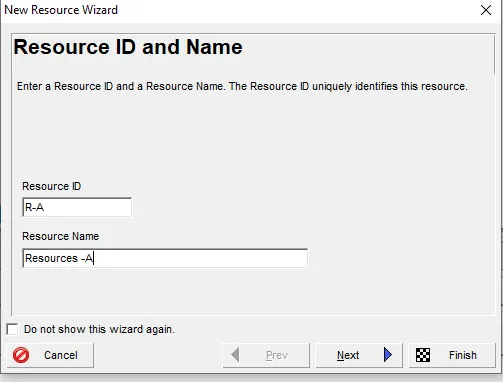

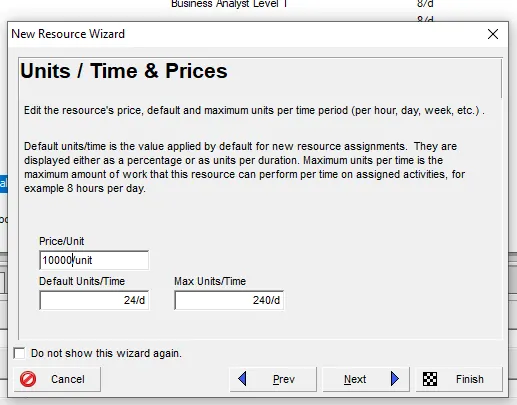

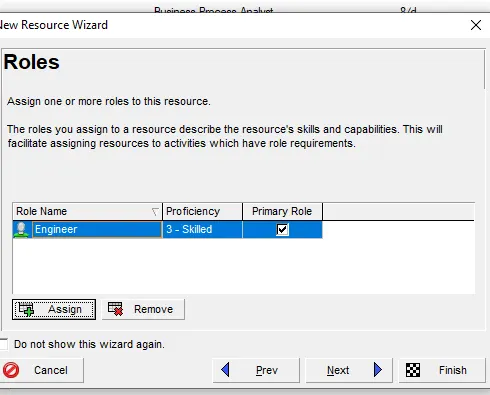

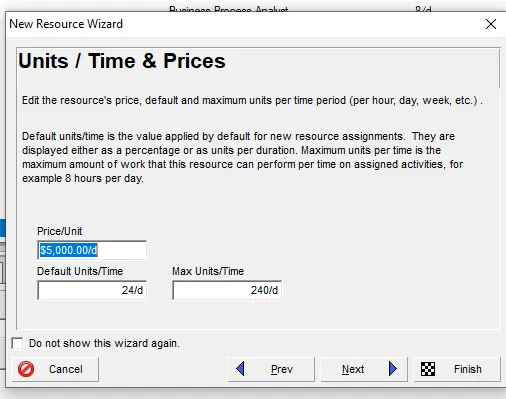

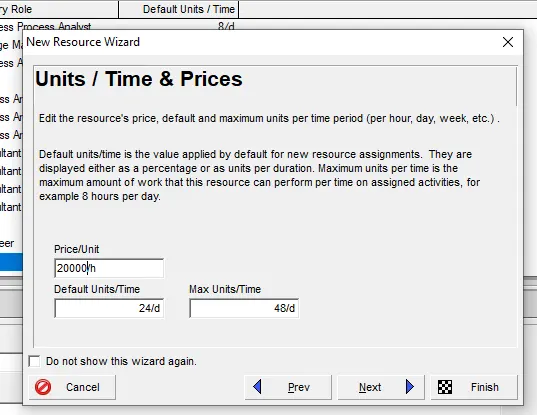

*Name the resources accordingly as given in the question

The same is done for the rest 2

*Adding activities > go-to activities select ECR project

*Click +

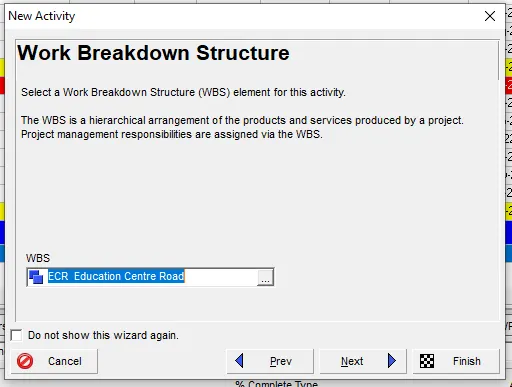

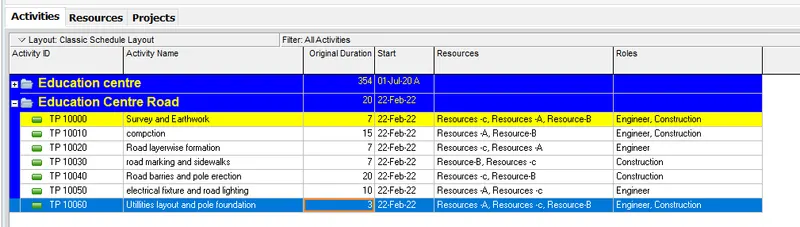

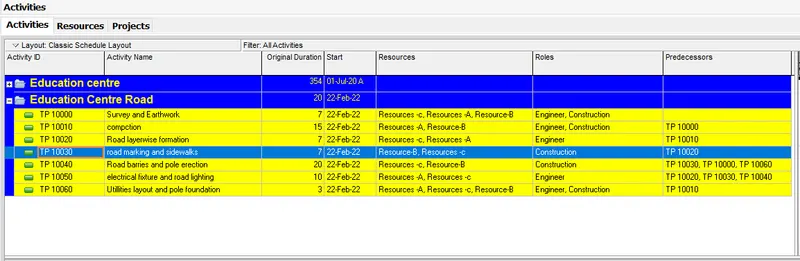

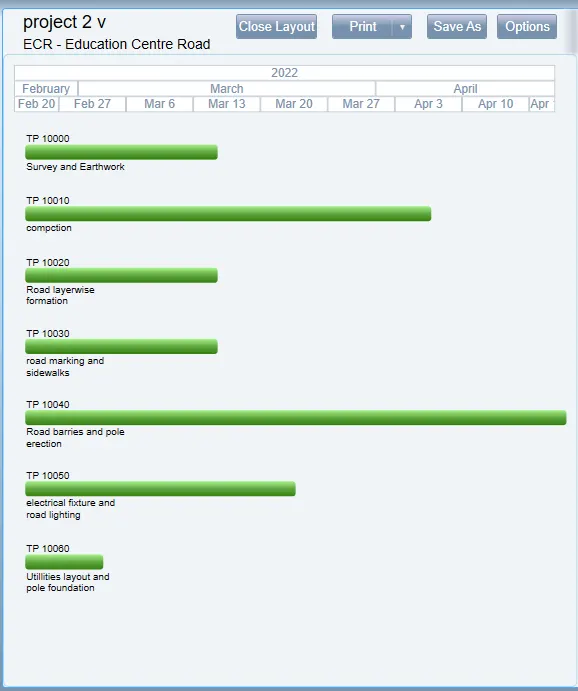

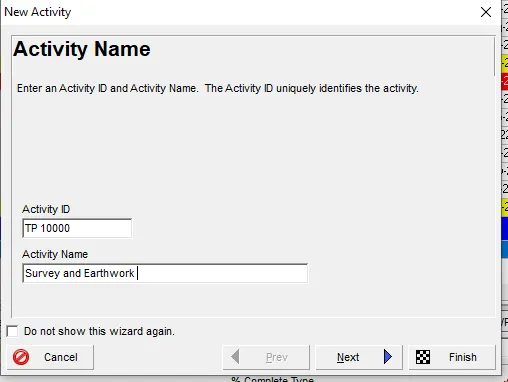

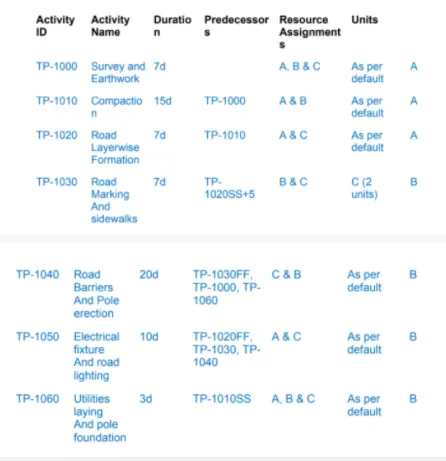

*add the activities according to the question

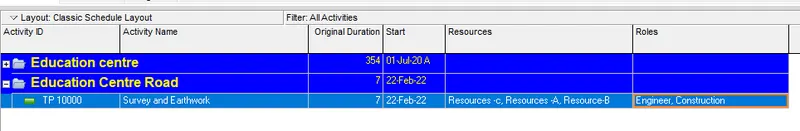

*duration is added

*now the predecessors are added

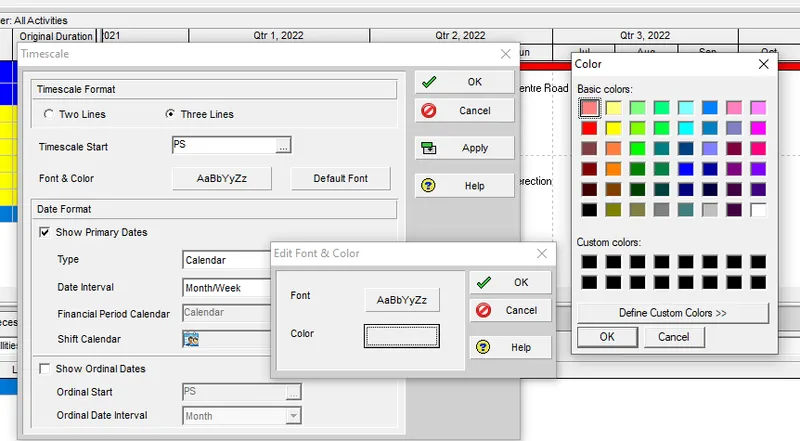

2. Use 3-Tier timescale with Year / Month / Weeks

4. Add a budget to your project - INR 6 cr.

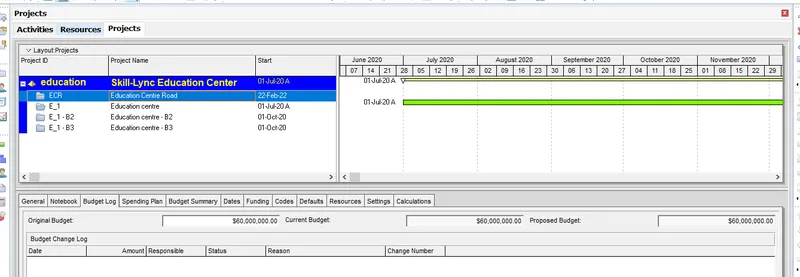

*Go to budget log and add in the details

5. Assign a baseline to the project

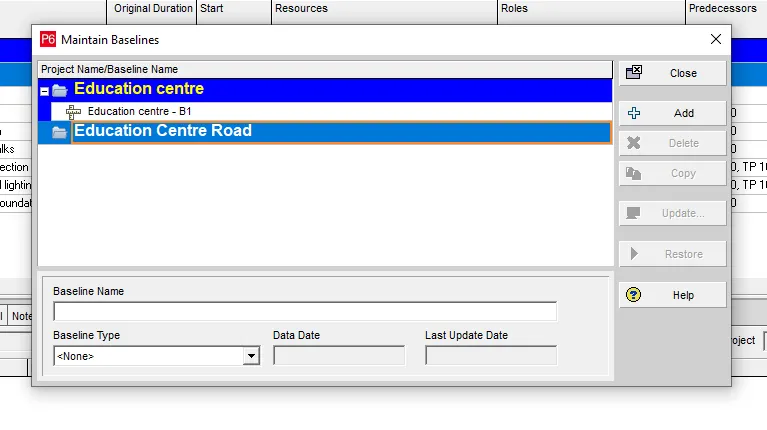

Go to project>maintain baseline

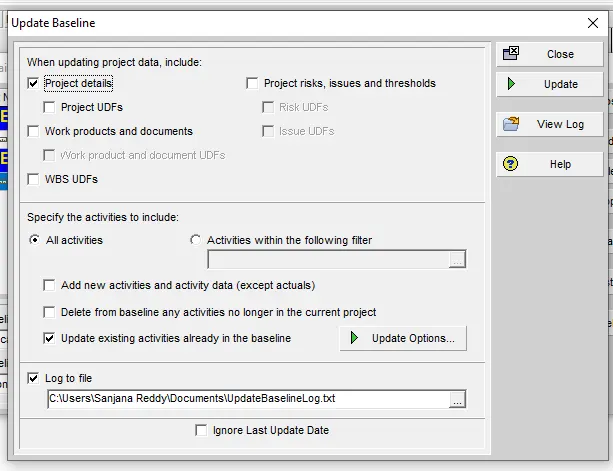

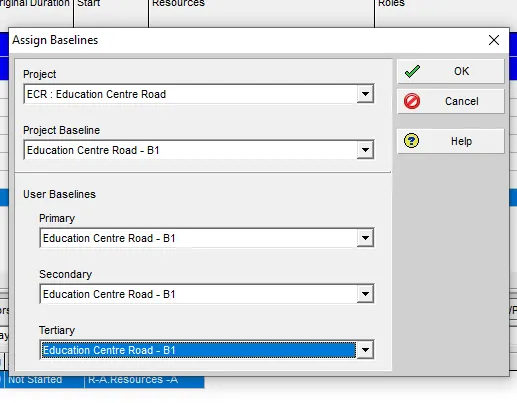

Again go to project >assign baseline

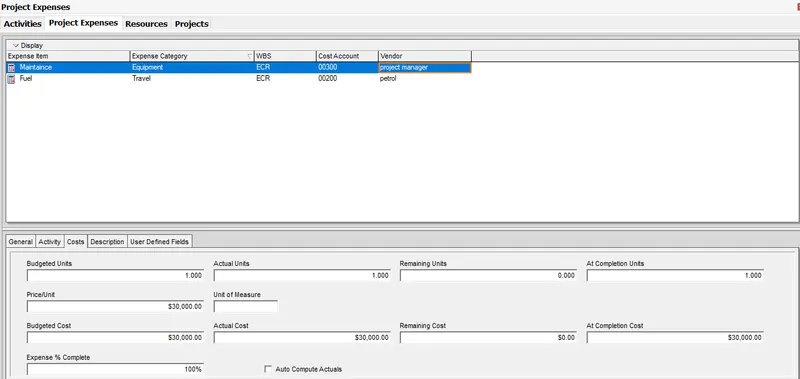

6. Add following expense:

Task - 1 - Rs 20,000/- (Item - Fuel)
Task - 2 - Rs 30,000 /- (Item - Maintenance)

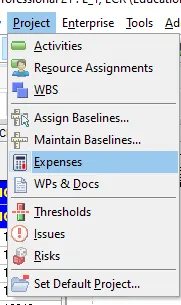

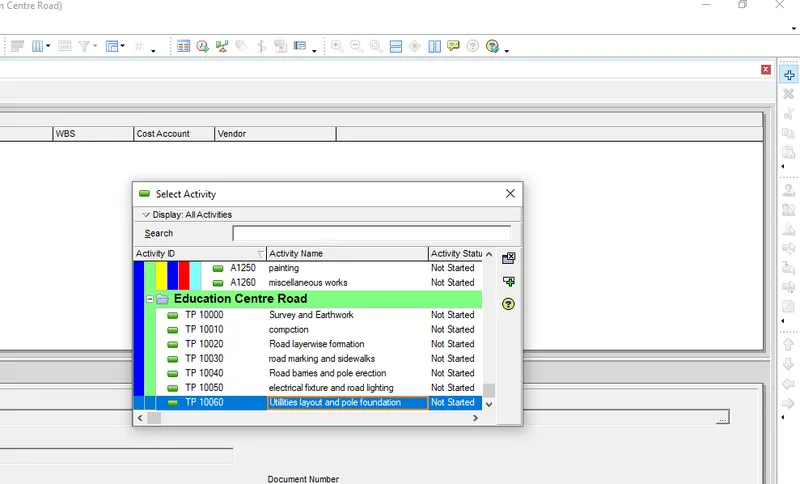

*project >enpense option

*Click +

*select the activity and add the details accordingly to the question

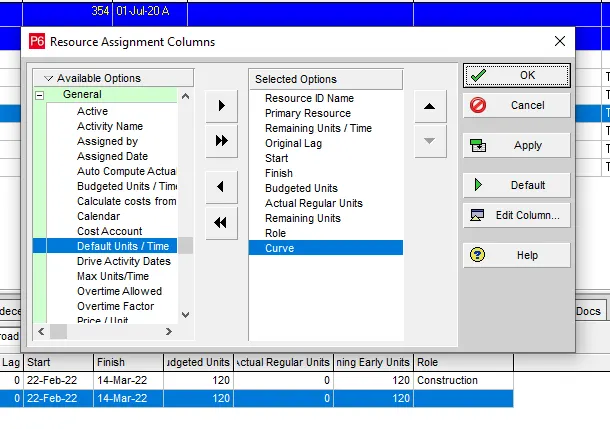

7. Generate material resource costs curve

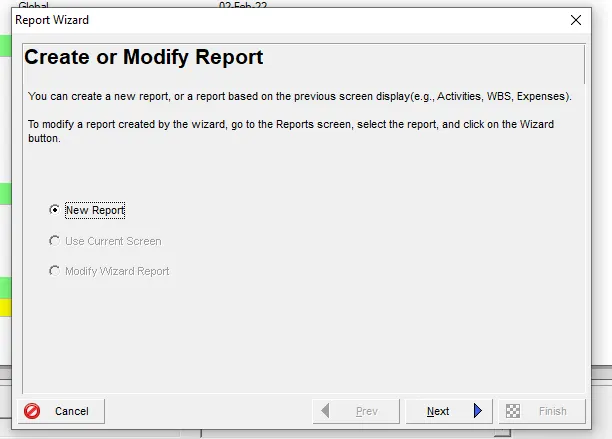

8. Generate an activity-wise cost report

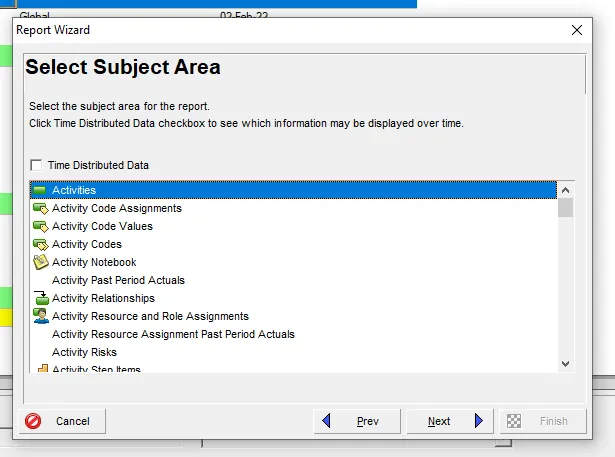

*Report >+

*New report >activities >relative subjects

9. Create a reflection

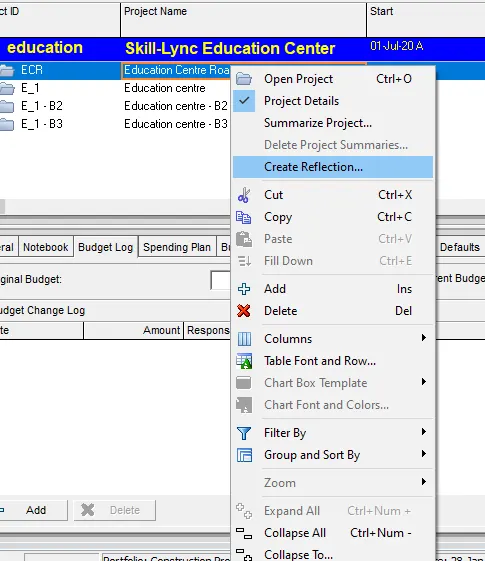

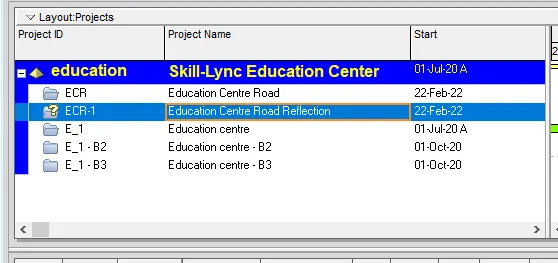

Go to project page > right -click >select reflection

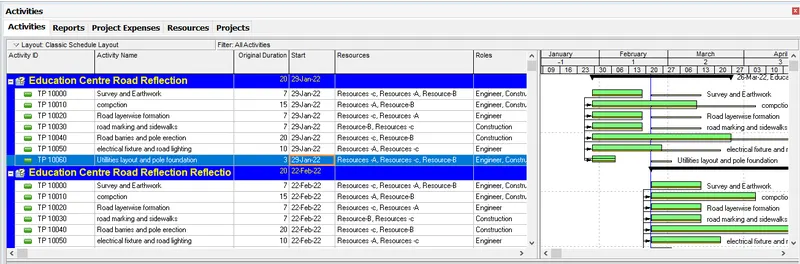

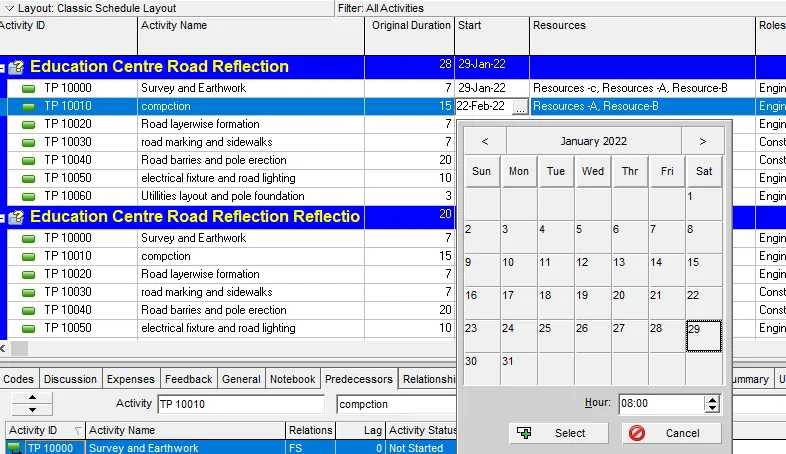

10. In the reflection, auto update the project at 15 days from start

*right click the reflection project

*open project

*Change date to 15 days ahead the current project

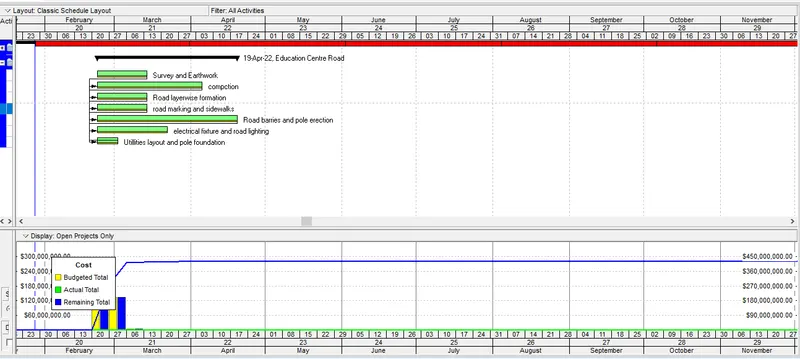

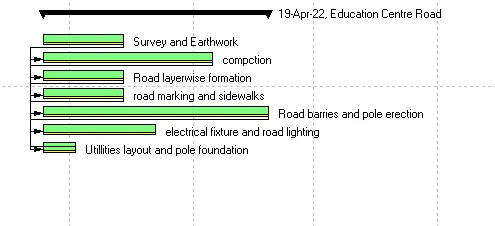

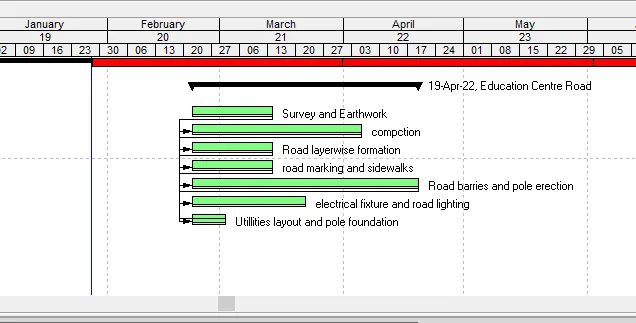

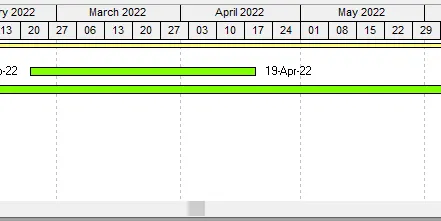

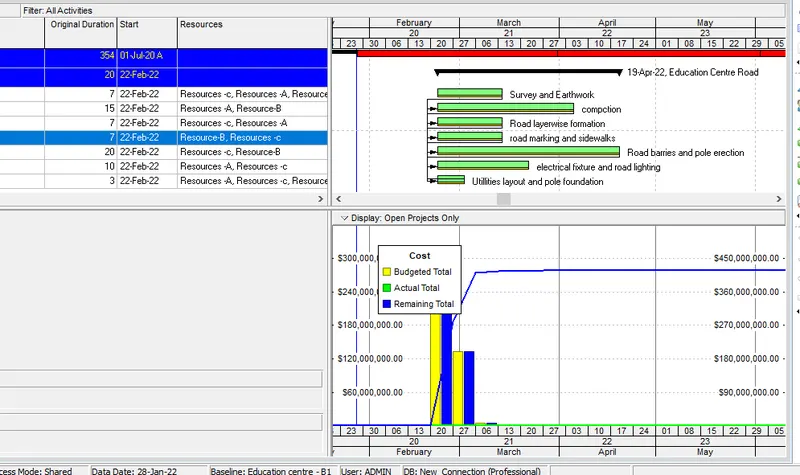

11. Open a TSLD view of the project in Visualizer

*Tools >Visualizer option

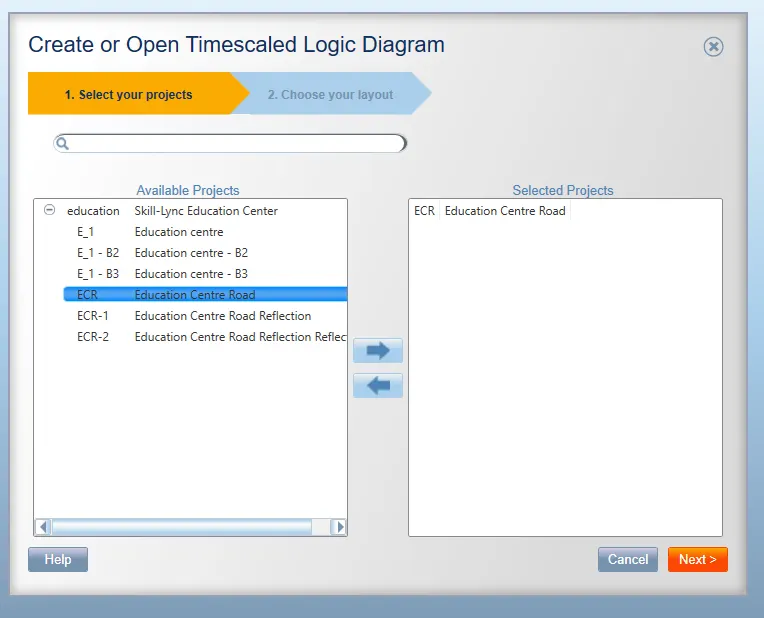

*Click + > TSLD > ECR project >okay

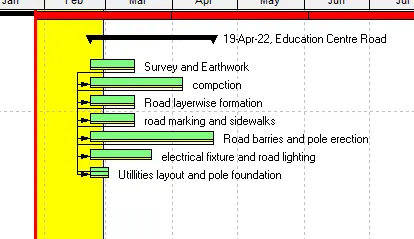

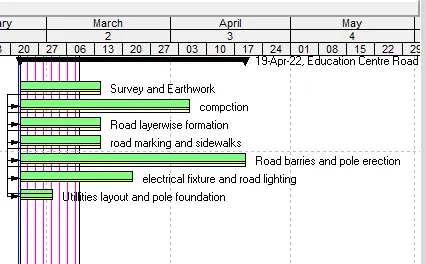

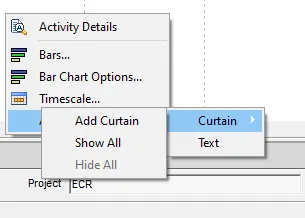

12. Add curtains up-to first 15 days of the project.

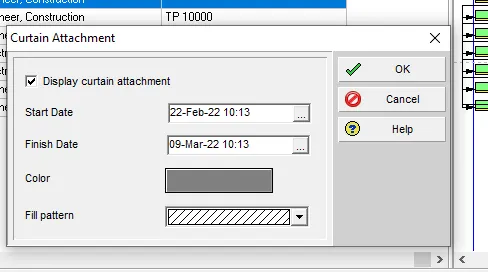

*Right -click on the left side project page >attachments >curtains

3. Find out the actual cost for labour, non-labour and material cost of the updated schedule

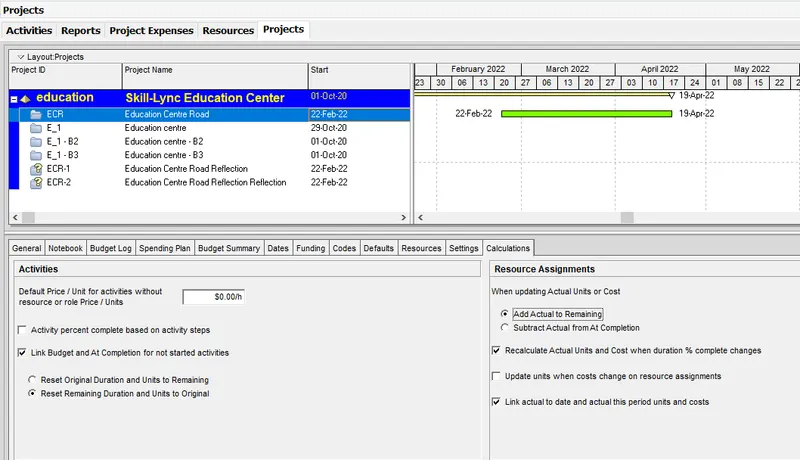

*Go to project page > calculation tab

*select  actual to Remaining

*Select resources to find the value

Your portfolio, next

Ship work like this
in your own course.

Talk to a career counsellor

Free 20-minute call. We'll map the right course to where you want to work.

By submitting you agree to our Terms and Privacy Policy.
