Project 1
Step 1:
Make the EPS as “Skill-Lync Education” and OBS and assign a Project Manager

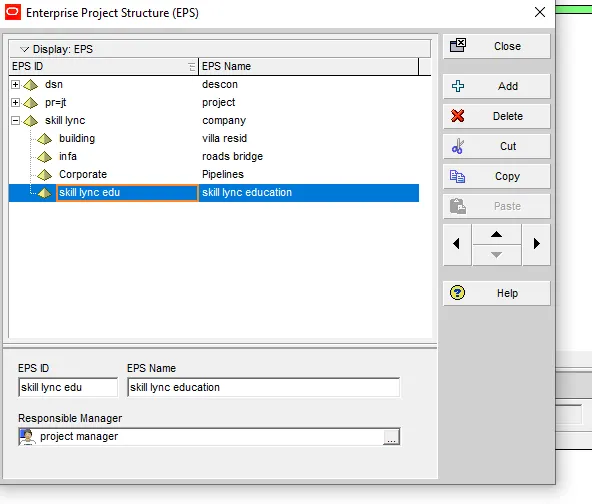

* Enterprise tab > OBS > add ( new > project manager )

*Enterprise > EPS >Skill -Lync education
*Assign > OBS ( project manager )
*Click okay
project us created under EPS " Skill-Lync Education Centre"

*Project will start on 1st October 2020 and end by 30th April 2023.

Create at least 50 activities.

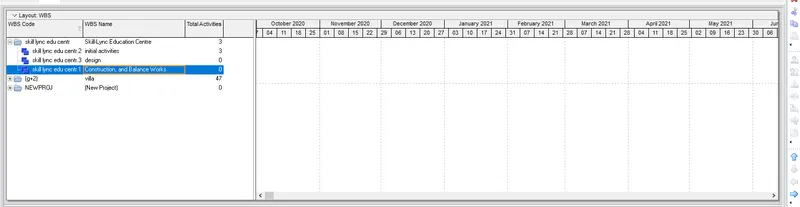

*Break Major WBS as - Initial Activities, Design, Construction, and Balance Works
*Click on WBS ( Right side of the project )
*The details are added

Now adding the sub-topics

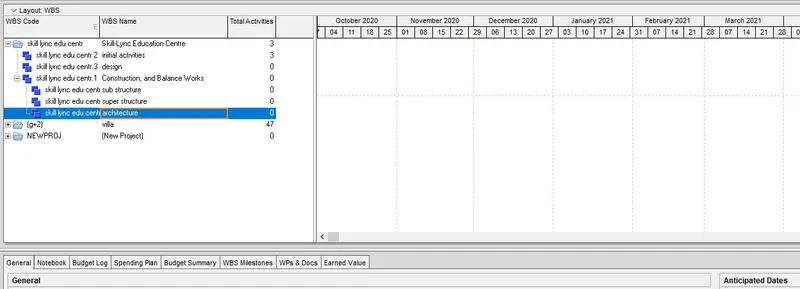

*Further Breakdown Construction into Substructure, Superstructure, and Architectural

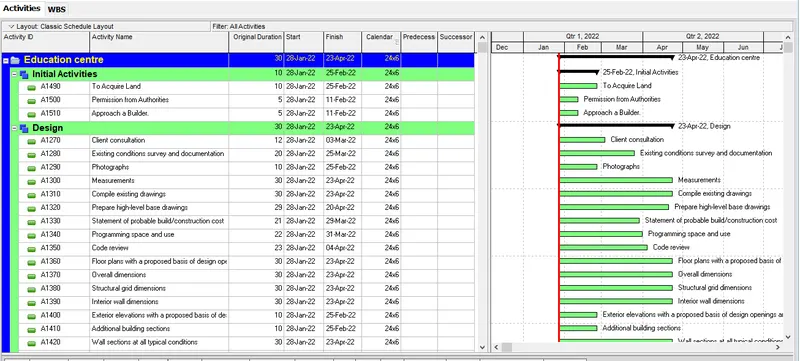

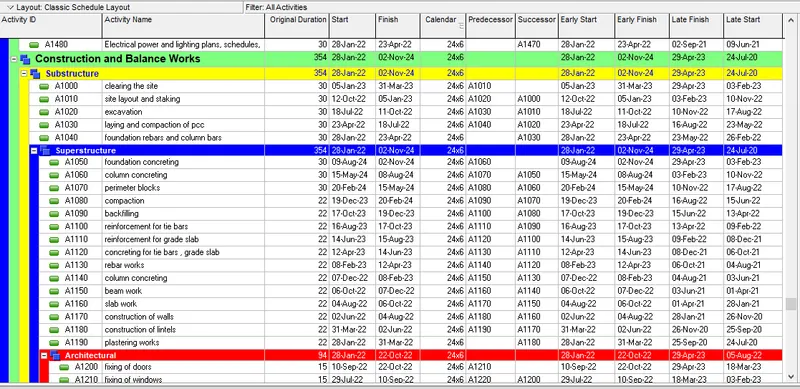

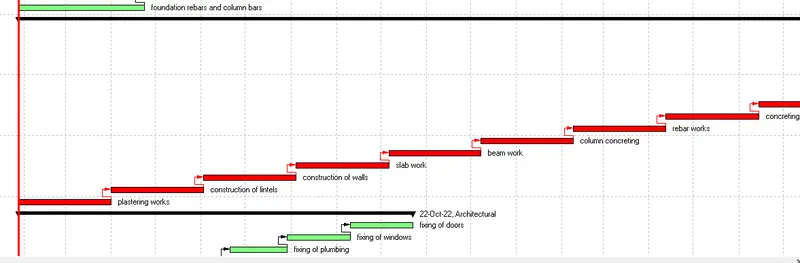

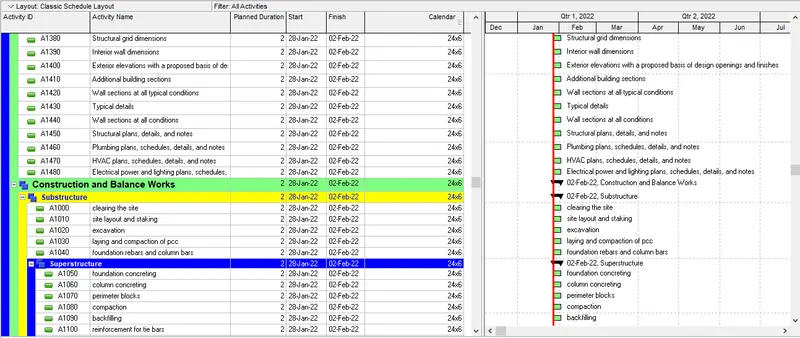

Now go activities > and 50 activities are added

All activity Id’s are having an interval of exactly 10

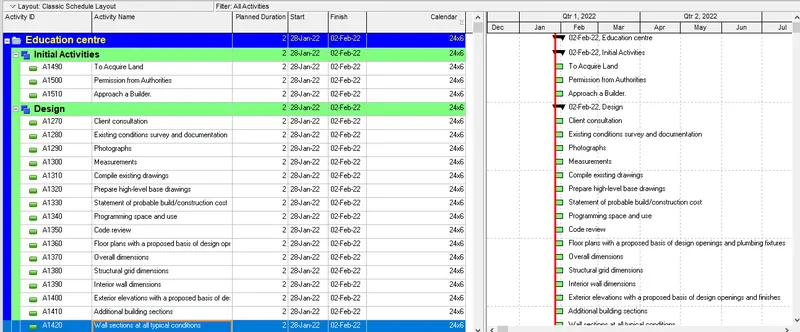

*the duration is changed to approximate dates

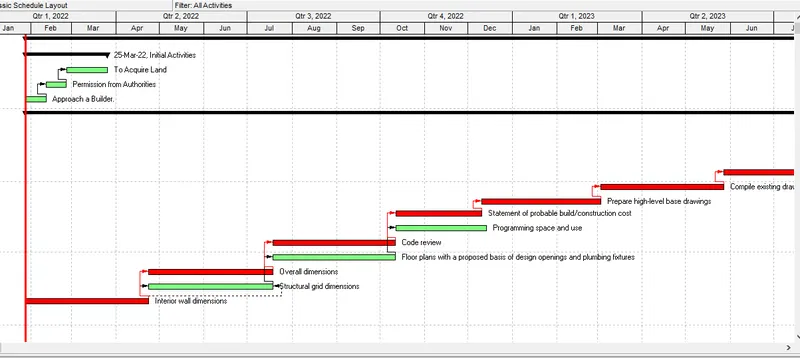

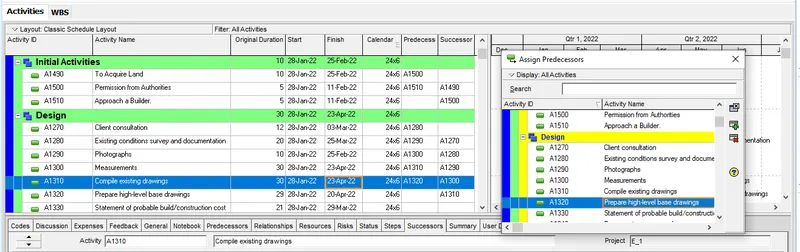

predecessor/successor choose suitable relationship of each activity is added
*Using the column option the predecessor and successor are added

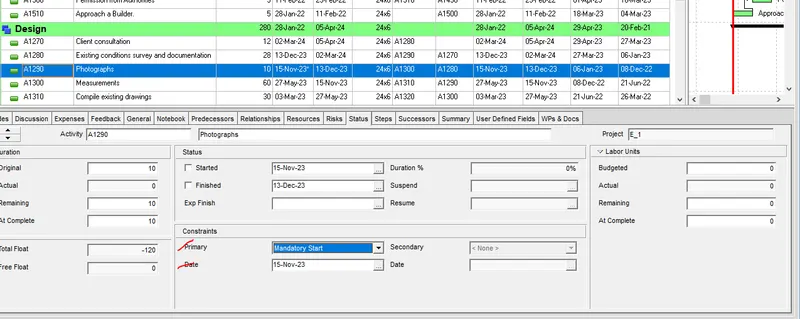

Work hours will be 24 hours and 6 days a week are added
*Complete Design in 8 months
Select the Schedule tool on top of the tool bar

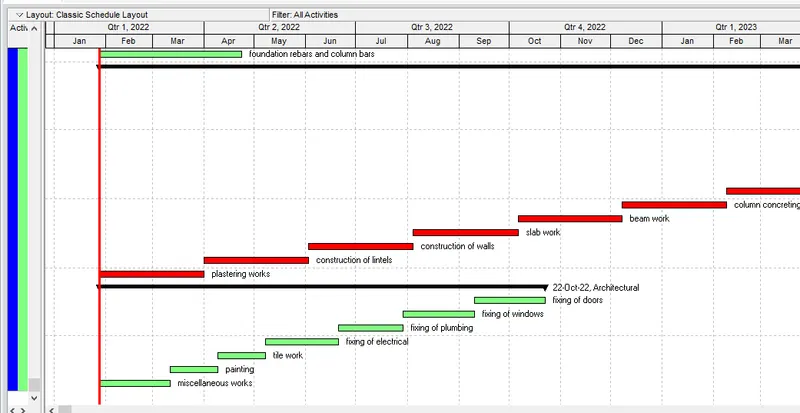

*therefore the Early/Late start and finish has been determined successfully

he constraints are done using the bottom > status tab
